Skip to content
MaintWiz: Innovating Industrial AI

Free tool

Excel to Gantt Chart: Free Shutdown Critical Path Tool

Short answer

Paste a task list from Excel into this free tool and it draws a Gantt chart with the critical path and the float of every task. It runs in your browser, uploads nothing and exports the chart as PNG or SVG and the results as CSV for Excel.

How MaintWiz helps: The free tool is a start; the module keeps the critical path live. The MaintWiz shutdown module puts the whole shutdown on a Gantt chart with the critical path, float and baselines, so you can see what moves the finish date. See the module · Get the Gantt template

By · Published · Last reviewed

What MaintWiz adds:Gantt with critical path and floatBaselines show what movedFloat flag at your limitOne plan from portfolio to task

The tool

How do you turn an Excel task list into a Gantt chart?

Paste your task list from Excel into the box below, with an ID, a task, a duration in days and the predecessors of each task, and the tool draws a Gantt chart and marks the critical path and the float of every task, all in your browser. 1

Excel to Gantt chart: paste your task list

Paste rows from Excel (copy the cells, then paste), or upload a CSV file. Columns: ID, Task, Duration (days), Predecessors, Crew. Everything runs in your browser; nothing is uploaded.

Paste your task list, or load the sample.

Columns

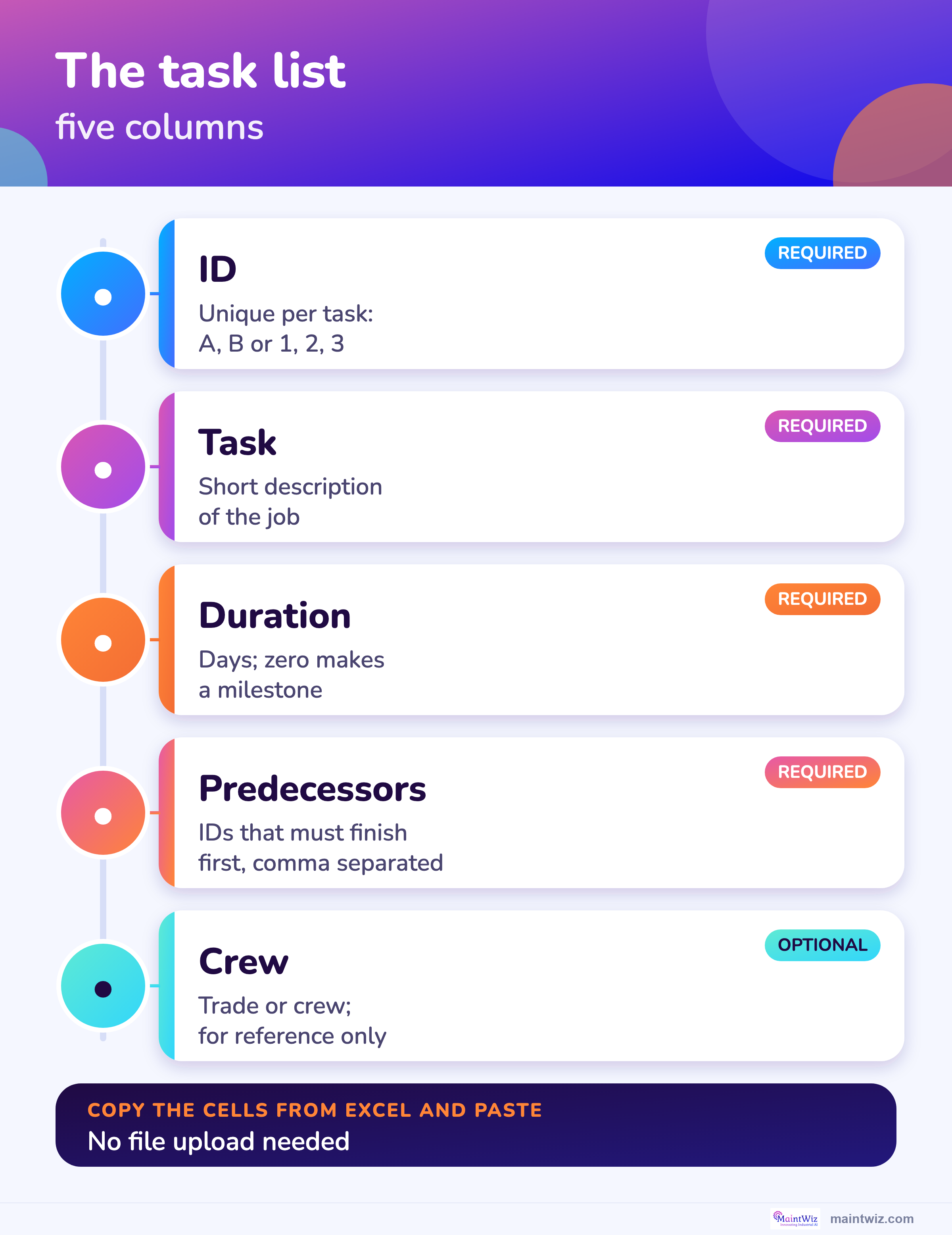

What columns does a shutdown schedule need for a Gantt chart?

A shutdown schedule needs four columns to draw a Gantt chart and find the critical path, ID, task, duration and predecessors, and a fifth for the crew helps when you review the plan.

Columns the tool reads
ColumnWhat to enterExample
IDA unique ID for each task (letters or numbers)4
TaskA short descriptionClean exchanger bundle
DurationDays, zero or more; zero makes a milestone3
PredecessorsIDs of tasks that must finish first, separated by commas or semicolons; leave empty for a first task3
Crew (optional)The trade or crew; shown in the export, not used in the calculationCleaning crew

For a real shutdown add the permit, the materials status and the work package it belongs to; see the work package guide and the shutdown scheduling guide.

Software

When do you need more than a free Gantt tool?

A free tool checks the logic of one task list; a shutdown module keeps the schedule, the work orders, the permits and the spares together and updates the critical path as work is closed.

Also see the shutdown calculators.

What the shutdown module covers

  • Gantt chart with the critical path and float, from your real work orders
  • A flag when float falls to a limit you set
  • Baselines that show what moved against the plan
  • Import and export with Excel and Microsoft Project XML, with interoperability with Primavera P6
  • Resource availability by trade and week
  • Work packages, permits and spares status linked to the schedule

Method

How do you find the critical path of a shutdown from a task list?

The tool finds the critical path with a forward pass and a backward pass: early dates come from the longest chain of predecessors, late dates work back from the finish, and tasks with zero float form the critical path. 1,2

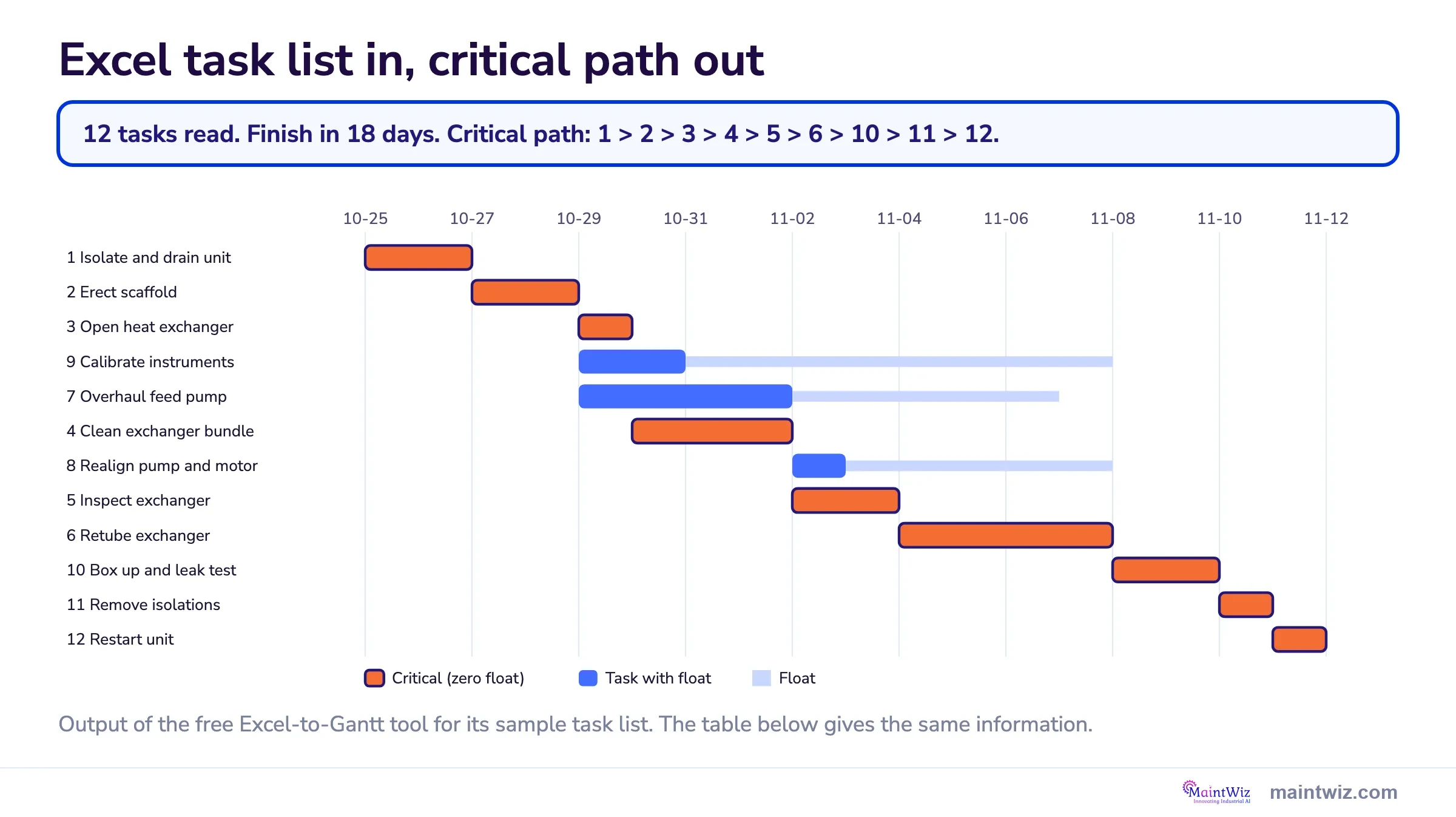

Excel-to-Gantt tool output for 12 sample tasks: an 18-day plan with the critical path in orange and float in pale bars
Excel task list in, critical path out. A Gantt chart for 12 tasks from 10-25 to 11-12, headed 12 tasks read. Finish in 18 days. Orange bars are critical with zero float, blue bars are tasks with float, and pale bars to their right show the float itself.

Follow the orange bars from task 1 to task 12: any slip on them moves the finish date. The blue tasks, calibrate instruments, overhaul feed pump and realign pump and motor, have room to move. Planners can use the float to level crews without touching the 18-day path.

Excel task list in, critical path out: text version
IDTaskDaysFloat (days)Status
1Isolate and drain unit20critical
2Erect scaffold20critical
3Open heat exchanger10critical
4Clean exchanger bundle30critical
5Inspect exchanger20critical
6Retube exchanger40critical
7Overhaul feed pump45has float
8Realign pump and motor15has float
9Calibrate instruments28has float
10Box up and leak test20critical
11Remove isolations10critical
12Restart unit10critical

Sample tasks from the free tool. Critical tasks have zero float; the critical path runs 1, 2, 3, 4, 5, 6, 10, 11, 12 for 18 days.

Related: Shutdown planning templates · Free shutdown planning tools · Shutdown scheduling and critical path

See how to plan a plant shutdown and shutdown work packages for building the task list.

The forward pass gives each task its early start, the latest early finish among its predecessors, and its early finish, the early start plus the duration. The backward pass starts from the project finish and gives each task its late finish, the earliest late start among its successors. Total float is the late start minus the early start; a task with zero float is critical. The US GAO schedule guide describes these terms. 1 The HHS earned value glossary defines the critical path as the path with the longest elapsed time that fixes the shortest possible duration. 2

See the worked float example for the arithmetic by hand and the scheduling guide for the method. The tool reports a loop in the links as an error, because no schedule can be worked out from one.

Export

How do you export a shutdown Gantt chart to Excel or PNG?

Use the buttons under the chart: Download PNG and Download SVG save the picture, Download CSV saves the results with dates and float for Excel, and Copy for Excel puts the results on the clipboard to paste into a sheet.

The CSV opens in Excel with columns for early and late dates, total float and the critical flag. The tool does not write .xlsx files and keeps no copy of your data: close the page and it is gone.

Limits

Is the schedule data uploaded when you use the tool?

No: the tool runs entirely in your browser, so the task list you paste or upload is not sent to MaintWiz or anyone else, and it is cleared when you close or reload the page.

When the tool is not enough, see replacing Excel for turnaround planning.

What the tool does not do
LimitWhy it matters
Calendar days onlyNo weekends, shifts or holidays; convert durations first
Finish-to-start links onlyNo lags, leads or start-to-start links
No resource limitsIt does not level crews or equipment; the crew column is for reference
No constraints or progressNo fixed dates, no percent complete, no baseline
No .xlsx uploadPaste cells from Excel or upload CSV

For a full schedule with calendars, resource loading and baselines use scheduling software: Oracle says Primavera P6 uses a critical-path algorithm and Microsoft Project can show critical tasks in red. 3,4 This tool is for a quick check of the logic and the critical path.

Visuals

Save the Gantt tool charts

Two charts to share with your planners. Click either for the full-size image.

FAQ

Frequently asked questions

How do I turn an Excel task list into a Gantt chart?

Copy the cells with ID, task, duration and predecessors in Excel, paste them into the tool and press Calculate. The chart and results appear below the box.

How do I find the critical path from a task list?

The tool runs a forward and a backward pass and marks tasks with zero float as critical. 1

What columns does a shutdown schedule need?

ID, task, duration and predecessors; crew is optional.

How do I export the chart?

Download PNG or SVG for the picture, Download CSV or Copy for Excel for the results.

Is my schedule data uploaded?

No. Everything runs in your browser and nothing is stored.

Can I upload an .xlsx file?

Not directly. Copy the cells and paste them, or save the sheet as CSV and upload that.

Does it handle weekends and shifts?

No. Durations are calendar days; convert them first.

What is float?

The time a task can slip without delaying the finish; zero float means the task is critical. 1

Put your shutdown schedule in one plan

Book a demo and bring your shutdown schedule. We will show how the module handles the critical path, float and baselines.

Book a demo
