Skip to content
MaintWiz: Innovating Industrial AI

India boilers

Annual Boiler Shutdown India: Inspection and Overhaul

Short answer

In India a boiler certificate lasts no more than twelve months in the main case under the Boilers Act, 2025, so the boiler must be inspected and the certificate renewed by a competent person each year; "boiler passing" is plant slang for that process, not a legal term. The Act came into force on 1 May 2025.

How MaintWiz helps: Boiler stops need inspection steps, permits and records in order. The MaintWiz shutdown module shows permits and isolations from ePTW on each work order and blocks closing a package while a permit or isolation is open. See the module · Get the permit register

By · Published · Last reviewed

What MaintWiz adds:Permits and isolations from ePTWShown on each work orderPackage cannot close with an open permitApprovals by signed-in user

The law

Is an annual boiler inspection mandatory in India?

Yes in effect: under the Boilers Act, 2025, a boiler certificate authorizes use for no more than twelve months in the main case, and when it ends the owner must have the boiler inspected by a competent person to renew it. 1

India: the Occupational Safety, Health and Working Conditions Code, 2020 came into force on 21 November 2025 and subsumes the Factories Act, 1948. The Act sections quoted on this page now have corresponding duties in the Code, and the Centre and the states are still issuing rules under it, so confirm the current rule for your state before you plan work. 6,7

The Act came into force on 1 May 2025 by a Gazette notification of 30 April 2025. 2 It repealed the Boilers Act, 1923, and Section 45 keeps rules and regulations made under the old Act in effect until new ones are made, so check the regulations for the details of tests and forms. 1

What the Boilers Act, 2025 says about the boiler certificate
TopicProvisionWhat it saysSource
In forceNotification of 30 April 2025The Central Government appointed 1 May 2025 as the date on which the provisions of the Act come into force; the Act lets different dates be appointed for different provisionsBoilers Act commencement notification, Boilers Act 2025
Certificate periodSection 12(6)The certificate authorizes use of the boiler for a period not exceeding twelve months; for an economiser or unfired boiler forming an integral part of certain processing plant, not exceeding twenty-four monthsBoilers Act 2025
When a certificate endsSection 13(1)On expiry; when an accident occurs; when the boiler is moved (with exceptions); on structural alteration, addition or renewal (with exceptions); and on an order prohibiting use as dangerousBoilers Act 2025
RenewalSection 13(3)-(5)The owner applies to the competent person, who inspects within fifteen days of receiving the application; if satisfied the boiler and components are in good condition, grants a certificate for the period specified by regulationsBoilers Act 2025
Use while renewal is pendingSection 15If the owner applied for renewal before expiry, the boiler may be used at the maximum pressure on the expired certificate pending the order on renewalBoilers Act 2025
Provisional orderSection 14An Inspector may permit use at a stated pressure pending the Chief Inspector's order; it ceases on the earliest of six months, the Chief Inspector's order and certain eventsBoilers Act 2025
RepairsSection 10(1)No repair unless, among other conditions, welders hold a welder's certificate, a boiler repairer is engaged where there are no in-house facilities, a competent person approves the repairs, and the safety of persons working inside the boiler is ensured by the measures the regulations specifyBoilers Act 2025
Old lawSection 45The Boilers Act, 1923 is repealed; rules, regulations and orders made under it have effect under the new Act until new ones are made; boilers registered under it are deemed registered; certificates in force continue until the date shownBoilers Act 2025

Boiler passing

What is boiler passing?

"Boiler passing" is plant slang, not a term in the Boilers Act; it is generally understood in Indian plants as the boiler being inspected and declared fit so its certificate can be renewed, while the Act speaks of inspection by a competent person and renewal of the certificate. 1

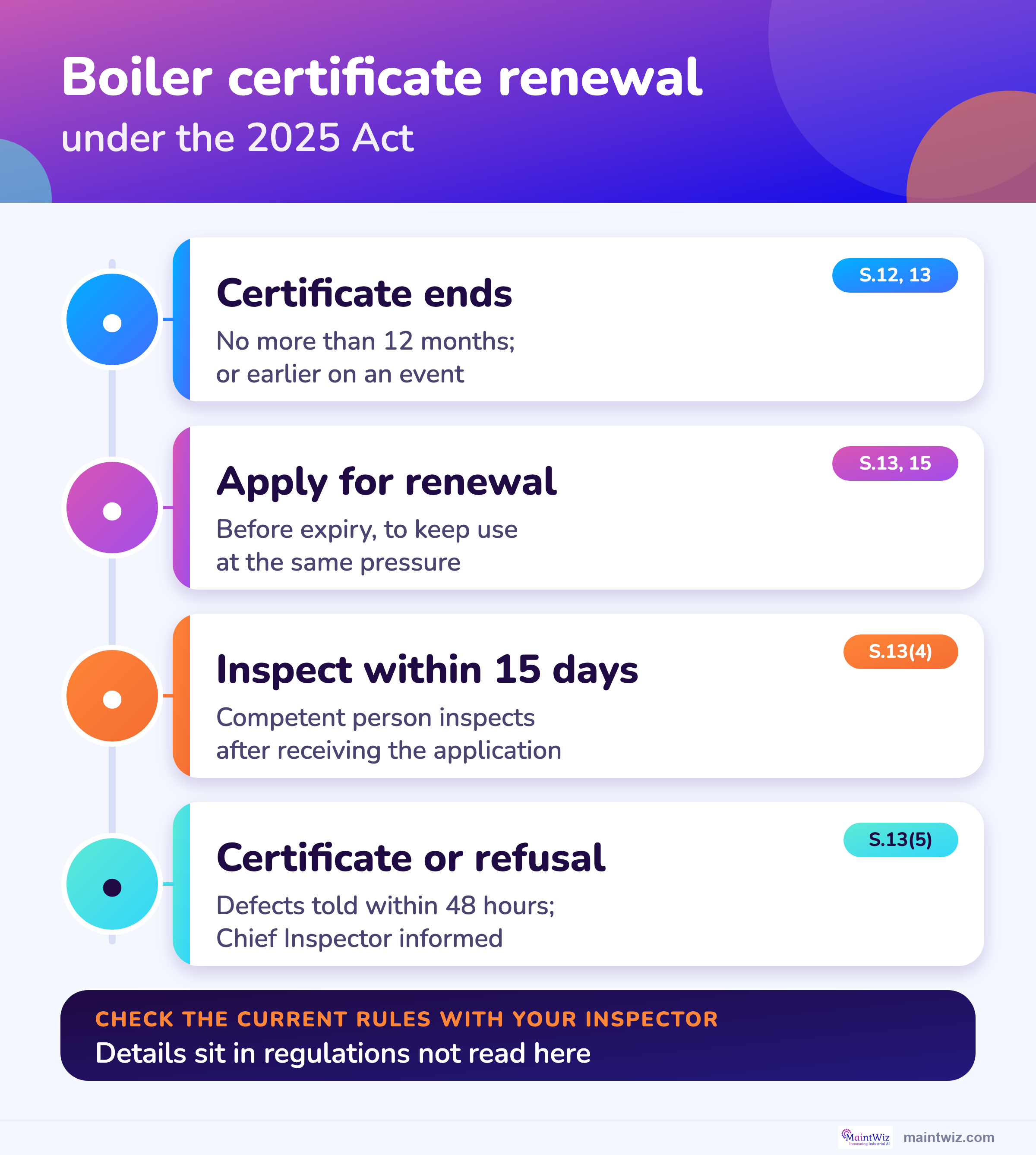

The steps in the Act are: the certificate ceases at the end of its period; the owner applies for renewal to the competent person; the competent person inspects within fifteen days and, if satisfied, grants a certificate for the period set by regulations; if not, they may refuse for reasons recorded in writing and report to the Chief Inspector. 1 The competent person must tell the owner of any defect or deficiency within forty-eight hours of the inspection. 1

So a plant should plan its annual shutdown so the boiler is open, clean, repaired and ready for the competent person before the certificate expires, and should file the renewal application before expiry to keep the right to run the boiler meanwhile. 1

Software

How can software help with an annual boiler shutdown?

Software can hold the certificate expiry date, the shutdown schedule, the repair packages, the permits and the inspection evidence together, so the boiler is ready for the competent person before the date.

Also see annual shutdown planning in India.

What the shutdown module covers

  • Gantt chart with the critical path and float for the annual shutdown
  • Preventive maintenance scheduling shared with the shutdown module, so due certificates and inspections are visible
  • Work orders with tick, reading and photo tasks for inspection findings and pressure readings
  • Permits and isolations from ePTW shown on each work order
  • Readiness gates and sign-offs recorded with the name, date and reason
  • Handover note and as-left summary on each work order

Worked plan

How long does an annual boiler shutdown take in India?

The example below is an illustrative 15-day plan that shows how the critical path runs through cool-down, inspection, repairs, box-up, pressure test, certification and light-up.

Terms are in the shutdown turnaround glossary; the job list format is in the free shutdown templates. Sugar mills run a boiler-led off-season: sugar mill off-season maintenance shutdown planning.

Critical path: any delay moves the finishActivity with floatFloat: days the activity can slip

The critical path is A, B, C, D, G, H, I, J: 15 days. Refractory repair (E) has 2 days of float and the mountings overhaul (F) has 4, so they can slip without moving the finish. Add a repair package and everything after it moves: for example, five more days on the tube repairs moves light-up by five days. 4

Durations are for illustration. Adapt the plan in the schedule with Gantt template (.xlsx). Set the pressure test step from your regulations and competent person. Use your own inspection history to estimate. See the critical path and float example.

Sequence

What is the cool-down and light-up sequence for a boiler shutdown?

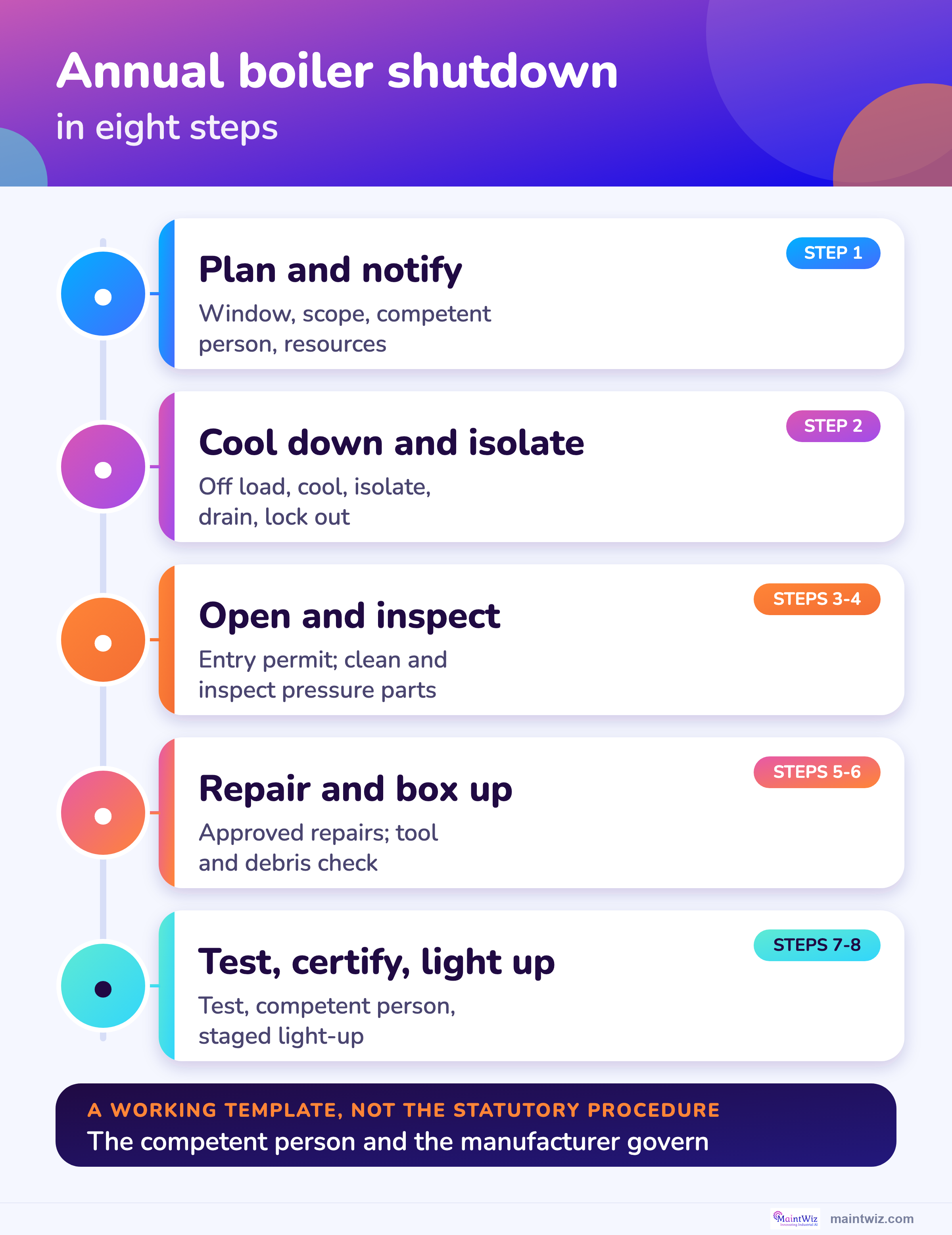

A boiler shutdown runs in eight steps: plan and notify, cool down and isolate, open and make safe, inspect, repair, box up, test and certify, and light up, with a permit and a record at each step.

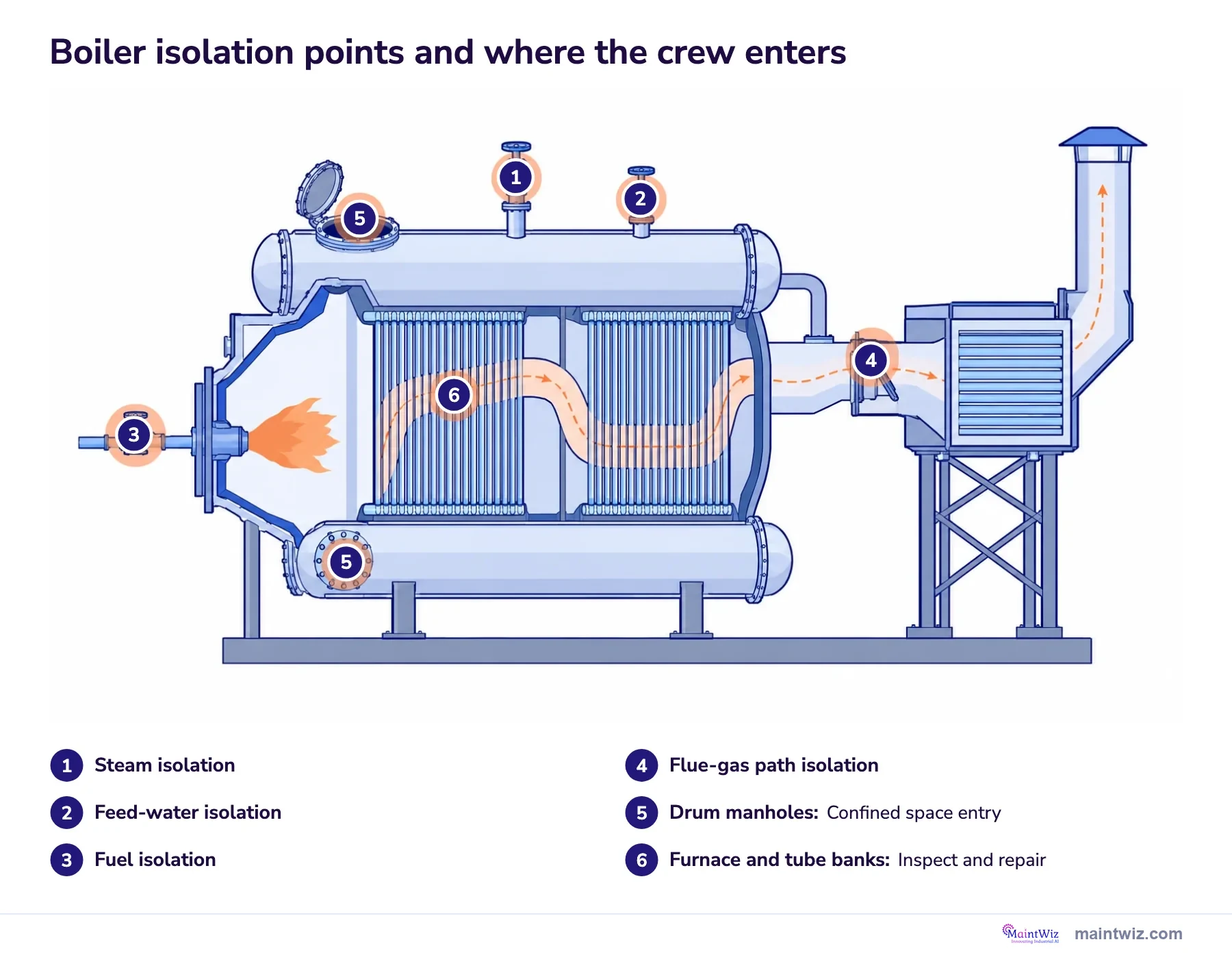

Cutaway of a water-tube boiler with numbered isolation points and drum and furnace entry and inspection areas
Boiler isolation points and where the crew enters. A water-tube boiler in section with six numbered markers: steam, feed-water, fuel and flue-gas path isolation points, drum manholes marked for confined space entry, and the furnace and tube banks marked for inspection and repair.

Read the markers in order: isolate steam, feed water, fuel and the flue-gas path before anyone goes in. Markers 5 and 6 show where the crew enters, so each drum manhole and the furnace needs a confined space permit and a verified isolation. Use it to brief the crew before cool-down starts.

Boiler isolation points and where the crew enters: text version
MarkerWhat it marksNote
1Steam isolation
2Feed-water isolation
3Fuel isolation
4Flue-gas path isolation
5Drum manholesConfined space entry
6Furnace and tube banksInspect and repair

Illustration by MaintWiz with numbered markers.

Related: Permit to work in a shutdown · OSHA rules for shutdowns

A free Excel file for this page: India annual shutdown format and boiler checklist (.xlsx).

Cool-down to light-up: a working sequence
StepWhat happensControl
1. Plan and notifyAgree the window, the scope and the competent person's visit; book repair and welding resourcesWelders hold the required certificates (Act s.10(1)(c))
2. Cool down and isolateTake the boiler off load, cool at the rate your procedure sets, isolate steam, feed, fuel and flue paths, drainLockout and tagout; record the isolation points
3. Open and make safeOpen drums and manholes, ventilate, test the atmosphere, erect accessConfined space entry permit and a standby person
4. InspectClean and inspect pressure parts, mountings and refractory; record findingsFindings logged and sent to the planner
5. RepairRepair pressure parts under approval of a competent person; overhaul mountingsRepairs approved (Act s.10(1)(e)); welding records
6. Box upRemove tools and debris, count and sign out tools, close manholes with new gasketsForeign-object check before closing
7. Test and certifyPressure test as the regulations and the competent person require; competent person inspects for the certificateApplication for renewal filed before expiry (Act s.15)
8. Light upFire in stages, check mountings under steam, return to serviceSteam trial record; restart review

For entering a boiler, the Factories Act s.36 says a person may not enter a confined space in which gas, fume, vapor or dust is likely to be present unless a competent person certifies in writing that it is reasonably free, or the person wears breathing apparatus with a rope held outside. 3 Lockout and isolation follow your own procedure; see permit to work during a shutdown.

Use this sequence as a starting point and follow the instructions of your competent person and the manufacturer. Your boiler manufacturer's instructions and the competent person's requirements govern. A boiler engineer should review it.

Permits

What permits are needed to enter a boiler?

Entry into a boiler is a confined space entry: the Factories Act requires a competent person's written certificate that the space is reasonably free of dangerous gas, fume, vapor or dust, or breathing apparatus with a rope held outside, and state factory rules and your site permit system add detail. 3

For confined space and isolation see permit to work during a shutdown.

Permits and approvals around an Indian boiler shutdown
ItemBasisSource
Entry into a boiler or drumFactories Act s.36: certification in writing that the space is reasonably free of gas, fume, vapor or dust, or breathing apparatus with a rope held outside; state factory rules add detailFactories Act 1948
Portable lights insideFactories Act s.36A: portable electric lights above 24 volts are restricted in such spacesFactories Act 1948
RepairsBoilers Act s.10: certified welders, approved repairs, safety of persons inside ensured by the regulations' measuresBoilers Act 2025
Energy isolationYour own procedure; for reference, the US OSHA lockout rule requires verification of isolation before workOSHA 1910.147

Visuals

Save the boiler charts

Two charts to share with your boiler team. Click either for the full-size image.

FAQ

Frequently asked questions

What is boiler passing?

Plant slang, not a legal term, generally for the boiler being inspected and declared fit for its certificate to be renewed. The Act speaks of inspection by a competent person and renewal of the certificate. 1

Is an annual boiler inspection mandatory in India?

A boiler certificate lasts no more than twelve months in the main case, and renewal needs an inspection by a competent person. 1 Confirm the current rules with your Inspector of Boilers.

Is the Boilers Act, 2025 in force?

The Central Government appointed 1 May 2025 for the provisions to come into force. 2 The Act repealed the Boilers Act, 1923, and kept rules and regulations made under it in effect until new ones are made. 1

How long does an annual boiler overhaul take?

The plan is a starting point. MaintWiz lets you replace the durations with your own history.

Can I keep running while renewal is pending?

If the renewal application was made before the certificate expired, the Act lets the owner use the boiler at the maximum pressure on the expired certificate pending the order. 1

What happens to the certificate after a structural alteration or accident?

It ceases to be in force, with limited exceptions. 1

Who approves boiler repairs?

A competent person approves repairs; welders hold a welder's certificate; a boiler repairer is engaged where the user has no in-house facilities. 1

Where is the plant-wide view?

See annual shutdown planning in India and the shutdown timing guide.

Keep permits and isolations tied to the work

Book a demo and bring your permit process. We will show how ePTW permits and isolations appear on each work order.

Book a demo
