Shutdown planning

How to Plan a Plant Shutdown: Process, Phases and Timeline

Short answer

How to plan a plant shutdown: work backward from the start date through five phases: scope and strategy, plan and schedule, readiness, execute and restart, and close-out and review. Freeze the scope early, settle long-lead materials and contractors before the stop, and treat late work as a change request.

Planning here means everything before the stop. Execution and restart are covered in the execution guide.

How MaintWiz helps: A 12-month plan fails when scope, schedule and readiness live in different files. The MaintWiz shutdown module puts the whole shutdown on a Gantt chart with the critical path, float and baselines, so you can see what moves the finish date. See the module · Get the Gantt template

By · Published · Last reviewed

What MaintWiz adds:Gantt with critical path and floatBaselines show what movedFloat flag at your limitOne plan from portfolio to task

Lead time

How to plan a plant shutdown: how far ahead should it start?

A large refinery turnaround may need 1 to 2 years of advance planning: EIA says turnarounds may involve that much, and AFPM says teams often begin years ahead. 1,2Work backward from your longest lead item instead.

This guide covers the planning that comes before the stop. The work itself is shutdown maintenance; execution is covered in the execution guide.

  • 1–2 yrsAdvance planning for a US refinery turnaround (EIA)
  • 3–5 yrsInterval for routine turnarounds on key US refinery units (EIA)
  • Weeks to monthsHow long a refinery unit is offline (EIA, AFPM)
  • Spring or fallWhen US refinery turnarounds are typically scheduled (AFPM)

US refining examples. Not benchmarks for other sectors.

What sets your own lead time

Longest-lead item

The equipment, materials or specialist service that takes longest to get. Work backward from it.

Contractor availability

Specialist crews and heavy equipment are booked ahead; a late scope leaves less choice.

Inspection and legal dates

A statutory inspection or certificate date can fix the window before anything else does.

Demand and season

Low-demand windows are chosen so capacity is available at peak. 2,3

Phases

What are the phases of a shutdown plan?

A shutdown plan has five phases, each ending in a gate decision, with project control (progress, critical path, cost, changes, risk) running through all of them. Planning is phases 1 to 3; the stop and the restart are phase 4.

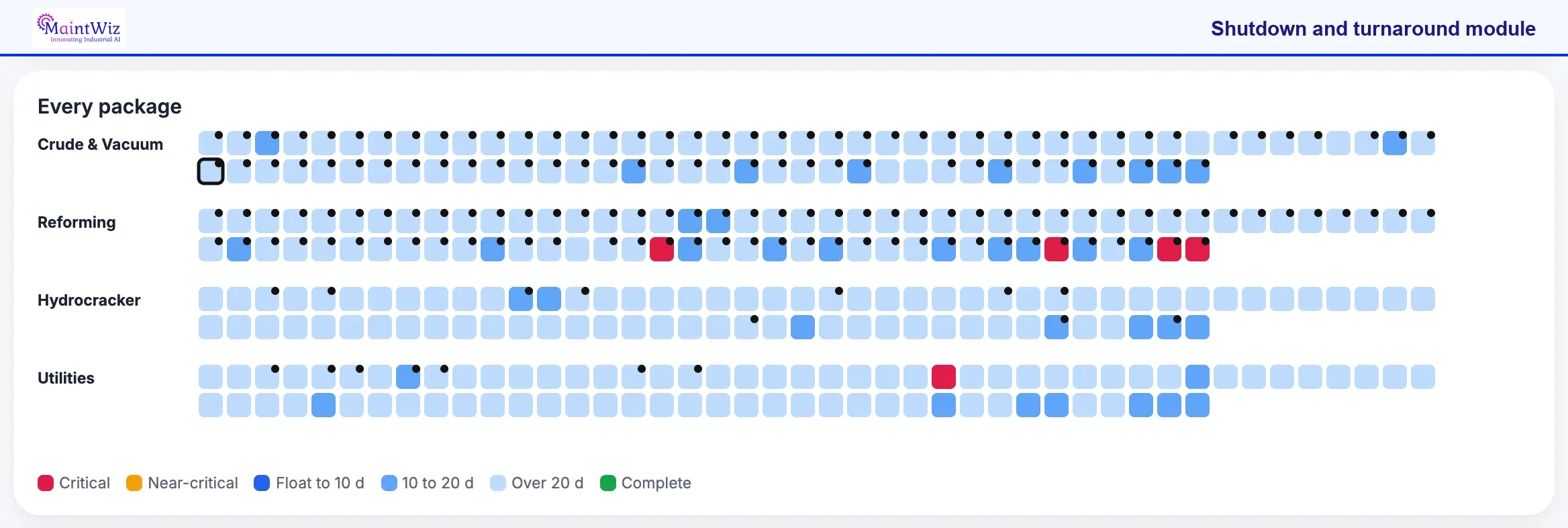

MaintWiz: map of every work package with one package selected
Map of every work package. Small tiles group every work package under Crude & Vacuum, Reforming, Hydrocracker and Utilities. Tile colour shows float: critical, near-critical, float to 10 d, 10 to 20 d, over 20 d or complete. One tile is outlined as the selected package.

Look for the red tiles first; they are critical, and most sit in the Reforming row. Then read across a unit to see how its float is spread. Use the map to decide which packages need a planner's attention now and which can wait while the phases are built.

Material planning is in shutdown spare parts planning. For T&I gated planning in Gulf refining, see T&I turnaround and inspection planning. Estimates need history: keep maintenance history in S/4HANA.

  1. 1

    Scope and strategy

    Collect the work list from the backlog, inspection findings and past shutdowns. Set objectives, timing and a cost estimate. Define the team and roles. Obtain approvals.

    Outputs: Approved scope, budget, dates, team · Gate: Scope approved
  2. 2

    Plan and schedule

    Break the scope into work packages with job plans. Sequence the work and find the critical path. Plan resources, permits, external approvals, spares, tools, logistics and isolations.

    Outputs: Work packages, schedule, resource and material plan, isolation plan · Gate: Plan and schedule baselined
  3. 3

    Readiness

    Freeze the scope. Confirm materials and contractors. Complete training. Prepare permits and isolations. Hold a go / no-go review.

    Outputs: Readiness sign-off · Gate: Scope frozen, readiness review, go / no-go
  4. 4

    Execute and restart

    Mobilize, shut down in the planned sequence, isolate, inspect, clean, repair and replace, calibrate, check quality, assess discovered work, then restart in the planned sequence.

    Outputs: Completed work, inspection records, safe restart · Gate: Restart approval
  5. 5

    Close-out and review

    Demobilize, close permits and contracts, reconcile cost and schedule, review performance and lessons, report to management.

    Outputs: Close-out report, lessons learned, updated asset records · Gate: Close-out signed off
Planning is not finished at the freeze: it ends at the go / no-go review, when materials, people, permits and isolations are confirmed ready.

Software

Where do the lists of a shutdown plan live?

A shutdown plan is a set of linked lists: scope, work packages, schedule, materials, permits and budget. Keeping them in one place stops them drifting apart.

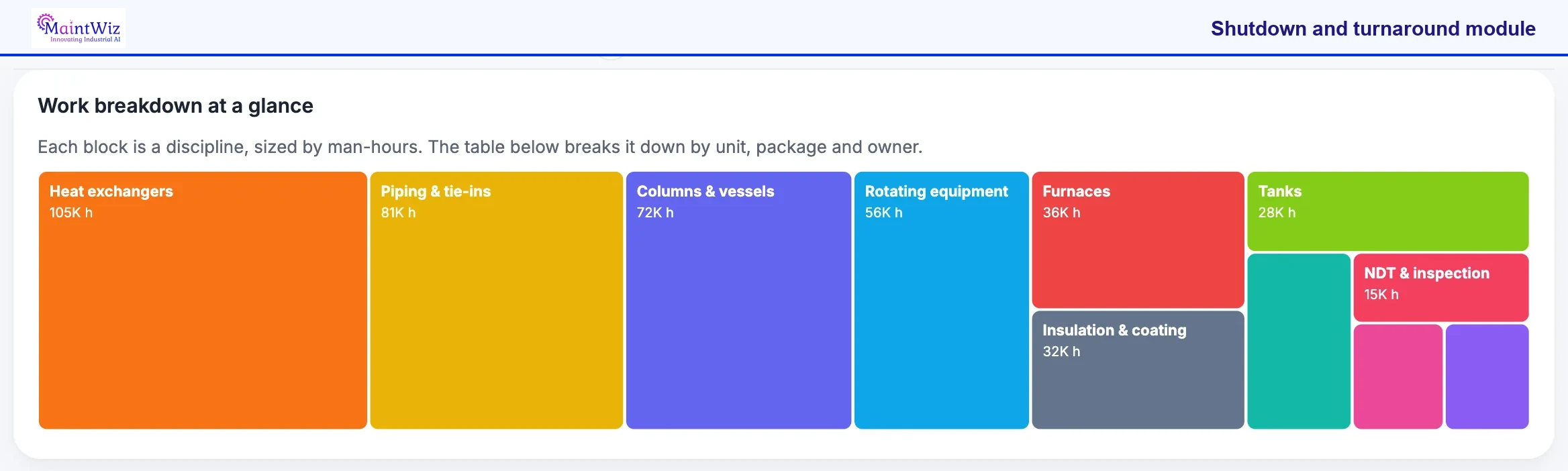

MaintWiz: work breakdown structure of a shutdown project
Work breakdown structure. A block map of the shutdown work breakdown, each block a discipline sized by man-hours: heat exchangers at 105K h, piping and tie-ins at 81K h, then columns and vessels, rotating equipment, furnaces, insulation and coating, tanks, and NDT and inspection.

Check the largest blocks first, since they set the crew size and the duration. Heat exchangers and piping carry the most hours, so their work packages need scope, materials and contractors fixed earliest. The table under the map breaks each block down by unit, package and owner for the planner.

See the MaintWiz shutdown module data sheet and the shutdown management software page for what the module covers. See digital shutdown management for the order in which to digitize. To choose a tool, see shutdown software vs spreadsheets vs Primavera P6. For SAP PM sites see SAP PM shutdown management.

Also: product data sheet · maintenance budget module.

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Backward plan

What does a backward plan look like?

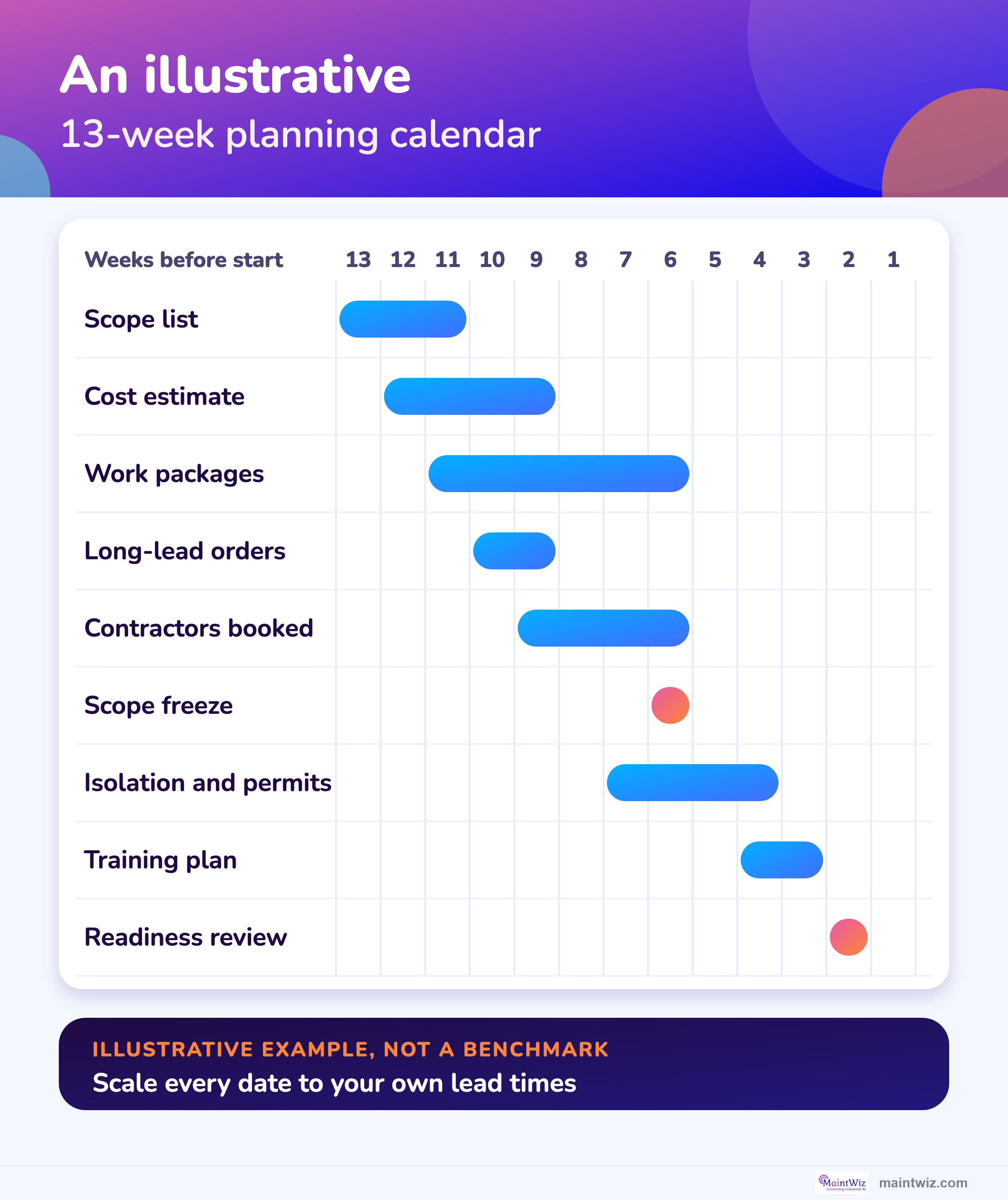

A backward plan starts from the shutdown start date and places the gates backward in order. The calendar below is an illustration for 13 weeks of planning. Scale every date to your own lead times.

Free Excel work list and schedule templates for this plan are in the shutdown planning templates. Check the logic of your task list with the free Excel to Gantt tool. Budget timing is in how to estimate a shutdown budget. Check each stage with the gates in turnaround readiness review and phase gates, and estimate with the classes in turnaround cost estimate and AACE classes.

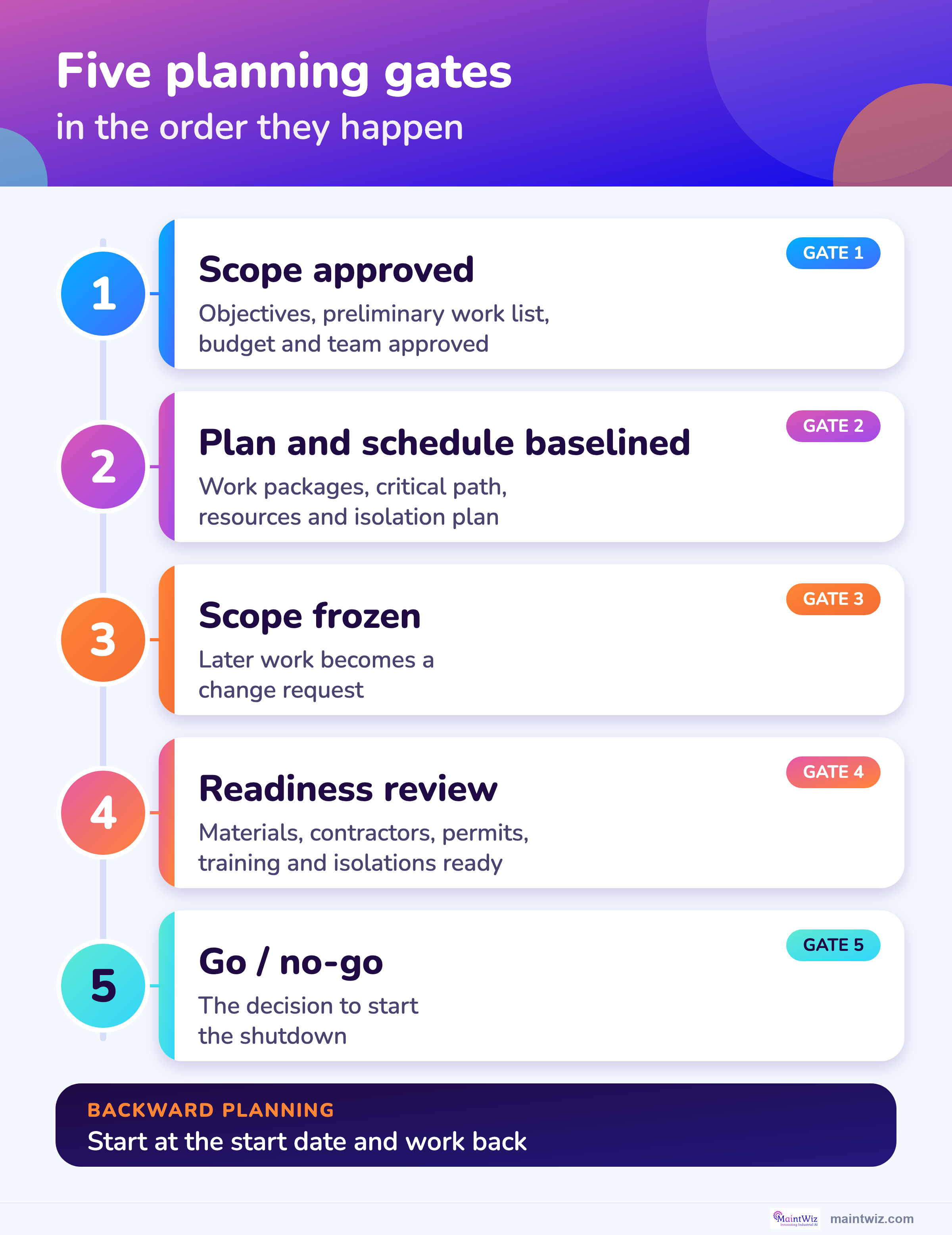

The gates in the example

Illustrative planning gates for a 13-week plan
GateExample timingWhat must be true
Scope approved13 to 9 weeks before startObjectives, preliminary work list, budget estimate and team are approved
Plan and schedule baselinedAbout 6 weeks before startWork packages and job plans exist; critical path and resources are loaded; isolation plan drafted
Scope frozen6 weeks before startLong-lead items are ordered and contractors priced; later work needs a change request
Readiness review2 weeks before startMaterials on site or confirmed, crews booked and trained, permits and isolations prepared
Go / no-goStart of the shutdownDecision to start, recorded

For the sequencing and critical path of the shutdown itself, see shutdown scheduling. For when to schedule it in the year, see when to schedule shutdowns.

Try it: put your start date into the backward plan

Enter the planned shutdown start date and adjust the weeks for each gate. The starting weeks are the illustrative ones used above. The dates are worked out in your browser; nothing is sent or stored.

Scope approvedenter a start date
Plan and schedule baselinedenter a start date
Scope frozenenter a start date
Readiness reviewenter a start date

Competing demands

What competing demands break a shutdown plan?

Competing demands break a shutdown plan when maintenance, contract work, modifications and operations all want the same people, equipment and time. HSE guidance lists these conflicts as work pressures that a realistic schedule must manage and resource.

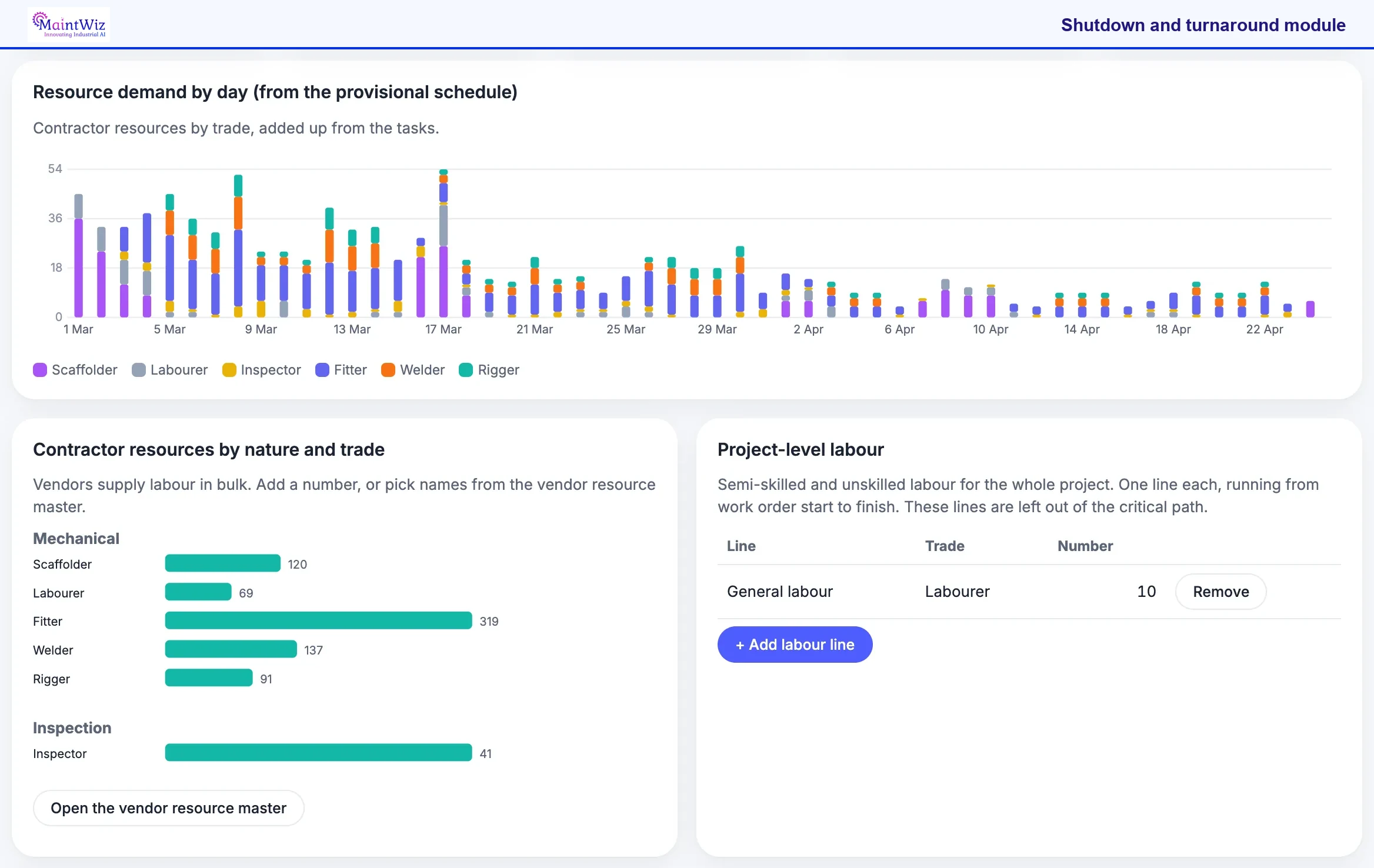

MaintWiz: resource demand by day and contractor resources by trade from the provisional schedule
Resource demand by day. A stacked daily bar chart of contractor demand from 1 Mar to late April, coloured by trade: scaffolder, labourer, inspector, fitter, welder and rigger. Below it are headcounts by trade for mechanical and inspection, and a project-level labour line.

Look for the tallest bars, in the first weeks of March, and see which trades make them up. Those are the days when crews compete for access, tools and supervision. Moving or splitting a job on a peak day is cheaper at planning stage than finding extra people during the shutdown.

Maintenance and operation

HSE guidance names competing demands between maintenance and operation as something a realistic schedule must manage. 4

Contract work and operation

The same HSE guidance names contract work against operation. Resources have to be adequate for the work. 4

Modifications and maintenance

HSE also names shutdown modifications against maintenance. Modifications add scope that needs change control. 4,6

Several units at once

When several units stop in the same period they share crews, cranes, scaffolding and the permit desk. Plan the shared resources as one calendar, and give the whole event one control point.

Roles and team structure: shutdown team roles · Contractors: contractor management · Materials: materials and logistics.

Change control

How do you handle late work after the scope is frozen?

Late work after the scope is frozen should be handled as a change request, not an informal addition. NERC's generator reporting rules make the same distinction: tasks are fixed in advance as the original scope of work, and discovery work is outside it.

Water plants: water and wastewater plant outages.

  1. 1

    Record the request

    Log the job, who raised it and why, against the frozen scope.

  2. 2

    Assess the effect

    Check safety, schedule, cost, materials and isolations, and whether it is a replacement in kind or a modification.

  3. 3

    Approve through change control

    An authorized person approves, defers or rejects it. Where OSHA's Process Safety Management standard applies, changes other than replacements in kind need written management-of-change procedures. 6

  4. 4

    Update the plan

    Add approved work to the schedule and budget and re-baseline the affected packages.

  5. 5

    Reconcile at close-out

    Compare approved changes with the frozen scope in the close-out report.

NERC treats in-scope inspection overrun as a planned extension, and repairs to damage found as forced outage time. 5 More: shutdown scope definition.

Visuals

Save the planning charts

Save or share these two planning charts. Each opens full size.

FAQ

Frequently asked questions

How do you plan a plant shutdown step by step?

Work backward from the start date: set the scope and budget, build work packages and the schedule, freeze the scope and confirm readiness, run the stop and restart, then close out and review. Each phase ends in a gate decision. EIA says refinery turnarounds may involve 1 to 2 years of advance planning; smaller shutdowns need less. 1

How far in advance should a shutdown be planned?

For large refinery turnarounds EIA says 1 to 2 years, and AFPM says planning often begins years ahead. Work backward from your longest lead item.1,2

What are the phases of a shutdown plan?

Five: scope and strategy, plan and schedule, readiness, execute and restart, and close-out and review, with project control running through all of them.

When should scope be frozen?

As a rule, freeze it before long-lead items are ordered and contractors are priced, and handle later work as change requests. NERC's generator rules likewise fix tasks in advance as the original scope of work. 5

What goes into a shutdown plan?

A scope list, work packages and job plans, a schedule with the critical path, a budget, a materials and spares plan, contractor bookings, an isolation and permit plan, a risk register, a communication plan, a readiness checklist and a close-out plan.

How do you plan a shutdown with no dedicated planner?

Keep the same five phases and gates but with fewer people: one owner for scope, one for materials and contractors, one for permits and isolations, and a short weekly review. This is planning guidance, not a sourced benchmark.

How do you coordinate several units shutting down together?

Plan shared resources (crews, cranes, scaffolding, permit desk) as one calendar and give the event one control point. HSE guidance names competing demands between maintenance, contract work, operation and modifications as pressures to manage. 4

Can software plan a shutdown?

Software can hold the scope, work packages, schedule, materials, permits and budget in one place and track progress against the plan. See the MaintWiz shutdown and turnaround module.

Put your shutdown schedule in one plan

Book a demo and bring your shutdown schedule. We will show how the module handles the critical path, float and baselines.

Book a demo
