Shutdown scheduling

Shutdown Scheduling: Critical Path, Gantt Chart and Float

Short answer

A shutdown schedule links every activity to its predecessors, gives each a duration and resources, and calculates the critical path: the longest continuous sequence of activities, which sets the earliest finish. A delay on a critical activity delays the whole shutdown day for day. Float is how long other activities can slip.

Scheduling here means sequencing the stop itself. Planning before the stop is in the planning guide.

How MaintWiz helps: A Gantt chart helps only if the critical path stays current. The MaintWiz shutdown module puts the whole shutdown on a Gantt chart with the critical path, float and baselines, so you can see what moves the finish date. See the module · Get the Gantt template

By · Published · Last reviewed

What MaintWiz adds:Gantt with critical path and floatBaselines show what movedFloat flag at your limitOne plan from portfolio to task

Contents

What must a shutdown schedule contain?

A shutdown schedule contains every activity, linked by logic, with a duration, resources, calendars and a baseline. GAO's schedule guide sets these out as best practices for any project schedule, and they apply directly to a shutdown.1

For reporting outages as planned or forced, see nuclear refueling outage planning.

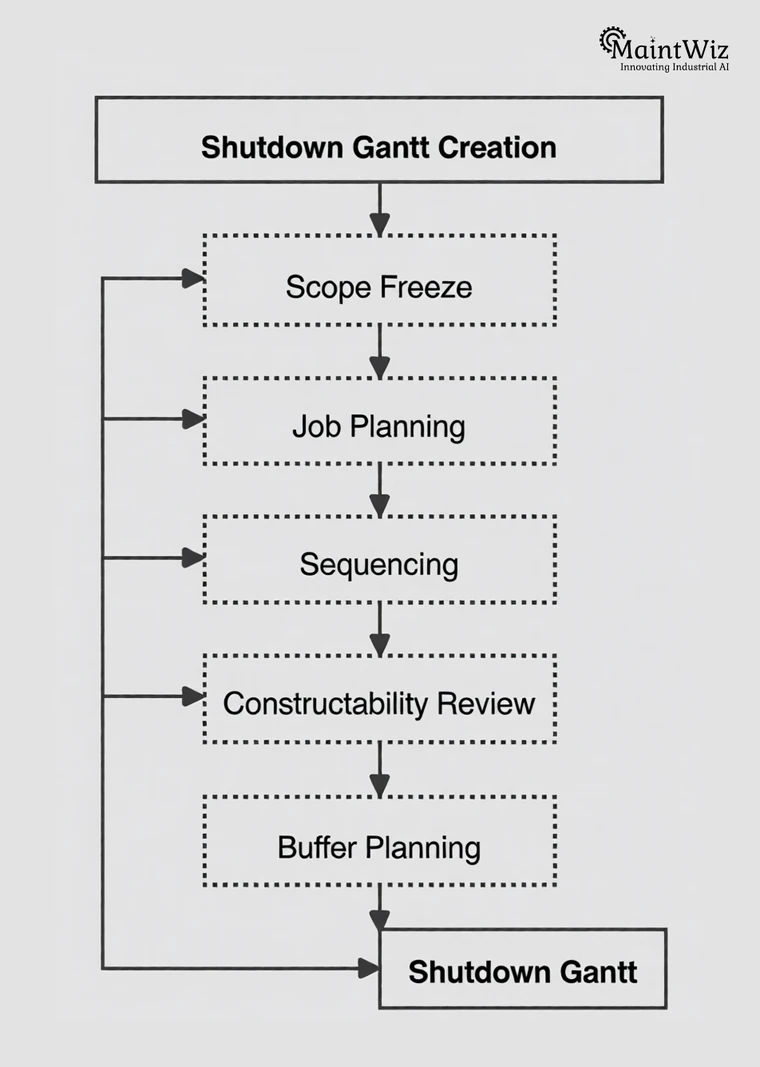

Flowchart of shutdown Gantt creation: scope freeze, job planning, sequencing, constructability review and buffer planning
The steps that precede the shutdown Gantt: scope freeze, job planning, sequencing, constructability review and buffer planning, with feedback arrows because earlier steps are revisited as the plan firms up. A MaintWiz illustration.

Scheduling here means sequencing the stop itself. Planning before the stop, including phases and gates, is in the planning guide; the work is shutdown maintenance.

What a shutdown schedule must contain
ElementWhat it meansWhy it matters
Every activityAll the work from the work packages, plus isolation, permits, restart and close-outWork missing from the schedule is invisible to the critical path
LogicEach activity linked to what must finish before it starts. GAO describes an ideal chart as a continuous waterfall of activities logically linked with finish-to-start relationshipsThe critical path is calculated from the links, not drawn by hand
DurationsAn estimate for each activity, owned by the person who does the workUnreasonable durations hide float and move the end date
ResourcesAll required labor and significant materials, equipment and other costs assigned to activities, compared with what is availableGAO: a resource-loaded schedule shows whether the resources will be there when needed
Calendars and constraintsWorking shifts and non-working periods; date constraints only where justifiedGAO: non-working periods are not float; date constraints override the network logic
A baselineThe original plan that stakeholders agreed, kept so that progress can be compared with itGAO defines the baseline as the consensus on sequence, resources and key dates

Sources: GAO schedule guide, GAO cost guide.

Critical path

What is the critical path, and what is float?

The critical path is the longest continuous sequence of activities, and it sets the earliest finish. Float is the time an activity can slip without delaying the end date, and critical activities have none.

The shutdown turnaround glossary defines critical path, float and earned value terms with sources. On critical path vs critical chain, see the float example.

GAO defines the critical path as the longest continuous sequence of activities in a schedule, which defines the earliest completion date. It defines total float as the time an activity can slip before its delay affects the end date, and says that float should not be treated as schedule contingency because it is shared along a sequence of activities. 1

Early finish

EF = ES + duration

The forward pass adds durations through the network from day one to give each activity's early start and finish.

Float

Float = LS - ES

Late start minus early start, from the backward pass. It is the time an activity can slip before it delays the end date.

Critical

Float = 0

With no date constraints, critical activities have zero float, so any delay moves the finish day for day.

Float is shared

Float belongs to the sequence, not to one activity. If one activity uses it, the others on that path lose it. 1

Non-working time is not float

Shifts and non-working periods in the calendar are not flexibility. 1

Watch near-critical work

Activities with a small amount of float can become critical quickly. GAO says management must closely monitor critical and near-critical activities. 1

Software

Where should the shutdown schedule live?

A shutdown schedule should live where it can be updated by the people doing the work, and where scope, materials and permits sit in the same place. A spreadsheet can list activities and draw bars, but the critical path and float need the logic links between activities, so use a tool that calculates the network or check by hand as in the example.

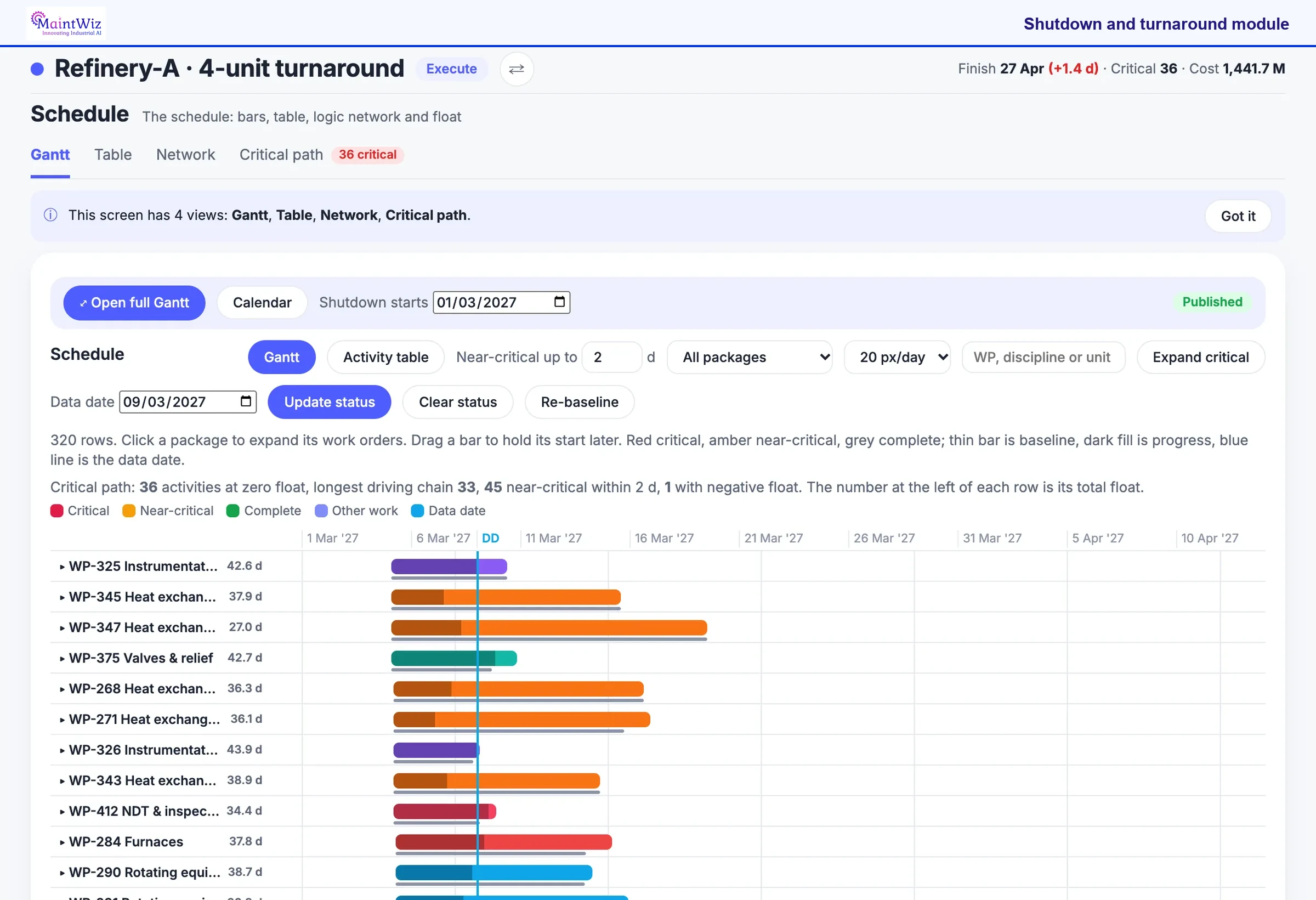

MaintWiz: shutdown Gantt chart with critical and near-critical activities and a data date
Shutdown Gantt chart. The Schedule screen for Refinery-A, 4-unit turnaround, with Gantt, Table, Network and Critical path tabs, a data date field, package filters, a colour key for critical, near-critical and complete work, and one bar per work package with its total float.

Start with the key line under the controls, which counts the critical and near-critical activities. Red bars have zero float, so any delay there moves the finish; amber bars are next in line. The planner sets the data date, updates status, and then reads which packages are critical before the daily meeting.

The shutdown management software page and the shutdown module data sheet describe the Gantt and float features. For scheduling tool choice see shutdown software vs spreadsheets vs Primavera P6.

A shutdown network can be built in scheduling software such as Oracle Primavera P6, which Oracle says uses the Critical Path Method algorithm, or Microsoft Project, where tasks on the critical path can be shown with red Gantt bars. 5,6

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Worked example

How do you find the critical path? A worked example

To find the critical path, add durations forward to get early dates, work backward from the finish to get late dates, and the activities with zero float form the critical path. In this illustrative example the critical path is A, B, C, D, G, H and the job takes 10 days; the pump work (E, F) has 1 day of float.

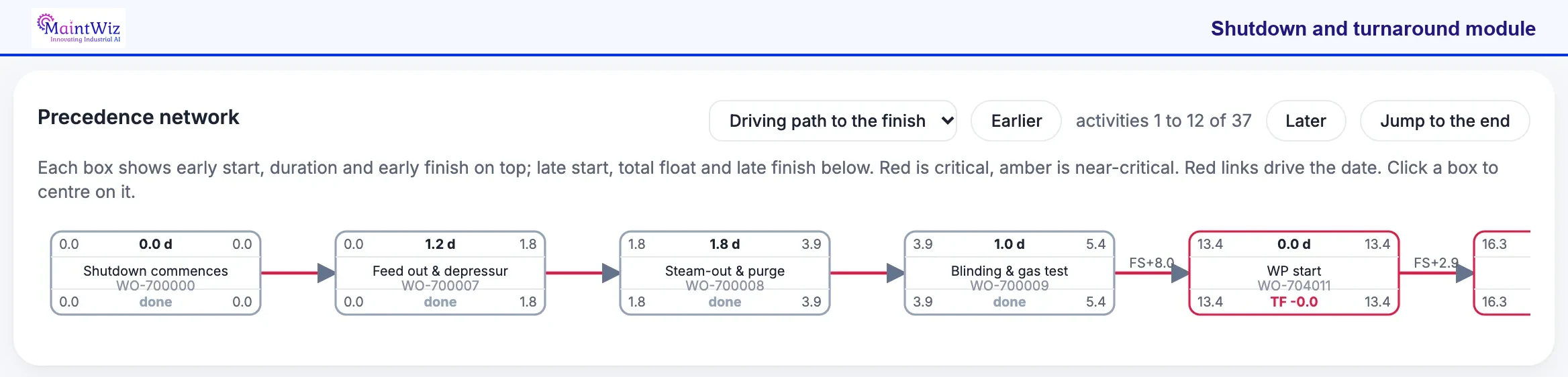

MaintWiz: precedence network of shutdown activities
Precedence network. A row of activity boxes joined by arrows, from Shutdown commences to WP start. Each box shows early start, duration and early finish on top, late start, total float and late finish below. Controls read Driving path to the finish, Earlier, Later and Jump to the end.

Look at the bottom row of each box first. A total float of zero, shown in red on the last box here, marks an activity on the critical path, where any slip moves the finish. Boxes with float can absorb delay, so that is where you can move crews to help critical work.

To try this on your own task list, paste it into the free Excel to Gantt tool.

Durations are illustrative, not typical values. Dates are elapsed days from the start of the shutdown.

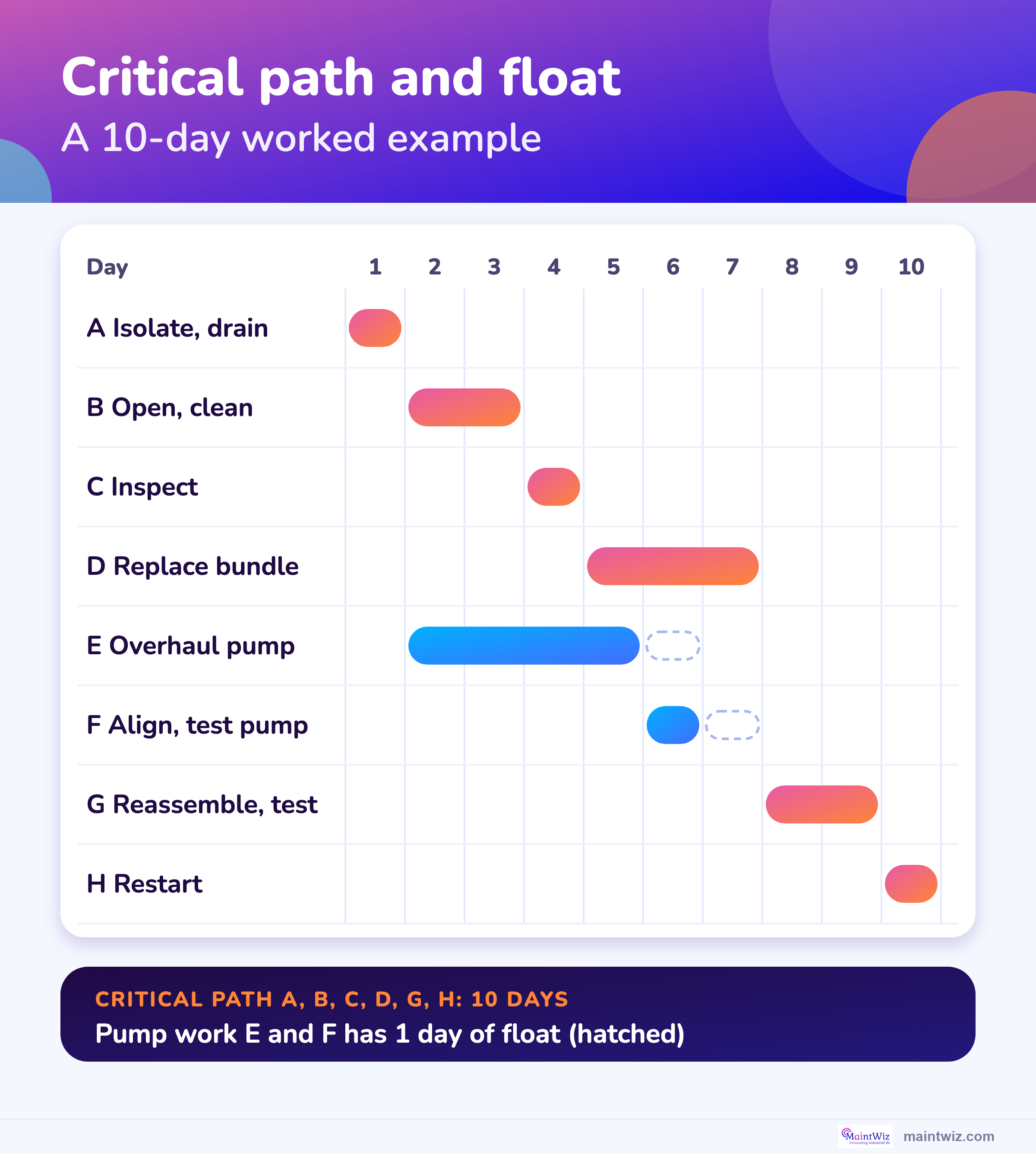

Annotated Gantt chart of the worked exampleActivities A, B, C, D, G and H form the critical path and set a 10-day finish. Activities E and F, the pump work, share 1 day of float. Each arrow is a finish-to-start dependency.Day012345678910A Isolate and drain the unit1 dB Open and clean the heat exchanger2 dC Inspect the exchanger1 dD Replace the tube bundle3 dE Overhaul the pump4 dF Align and test the pump1 dG Reassemble and test2 dH Restart the unit1 dFinish: day 1012345
Annotated Gantt chart of the worked example. Critical jobs are red, other jobs are blue and float is dashed.
  1. Critical path. A, B, C, D, G and H have zero float. A delay to any of them moves the finish date by the same amount.
  2. Float. The dashed line is float: how far a job can slip without moving the finish. F can start up to 1 day late, or take up to 1 day longer.
  3. Dependency. Each arrow is a finish-to-start link. G cannot start until both D and F are finished.
  4. Finish date. The longest chain of dependent jobs, 10 days, sets the finish. Shortening a job that is not on it does not bring the finish forward.
  5. Shared float. E and F are in sequence, so they share the same 1 day. If E uses it, F has none left and both become critical.
Worked example: ten-day heat exchanger and pump shutdown (illustrative durations)
IDActivityDaysAfterEarly startEarly finishLate startLate finishFloatCritical?
AIsolate and drain the unit1-01010Yes
BOpen and clean the heat exchanger2A13130Yes
CInspect the exchanger1B34340Yes
DReplace the tube bundle3C47470Yes
EOverhaul the pump4A15261No
FAlign and test the pump1E56671No
GReassemble and leak test2D, F79790Yes
HRestart1G9109100Yes

How to read it. The forward pass gives early dates: D finishes on day 7 and F on day 6, so G cannot start before day 7. The backward pass from day 10 gives late dates: G must start by day 7, so F must finish by day 7 and E by day 6. E can start on day 1 but may start as late as day 2, so it has 1 day of float. The chain A, B, C, D, G, H has none.

Try it: change a duration and watch the critical path move

Edit any duration (whole days). The logic links are fixed as in the worked example. The sums run in your browser; nothing is sent or stored.

IDActivityAfterDaysEarly startEarly finishFloat
AIsolate and drain the unitnone
BOpen and clean the heat exchangerA
CInspect the exchangerB
DReplace the tube bundleC
EOverhaul the pumpA
FAlign and test the pumpE
GReassemble and leak testD, F
HRestartG
Job duration, days
Zero-float activities

Resources

Why does resource leveling move the end date?

Resource leveling moves the end date because a schedule that ignores crews assumes they are free. When two activities need the same crew, one has to wait, and if the wait is longer than that activity's float, the end date moves. In the example, B and E need the same crew, so the job grows from 10 to 11 days.

A mill reline, where one crew sets the critical path, is shown in mining shutdown planning. Convert hours to headcount with the turnaround manpower plan and labor histogram.

GAO describes a resource-loaded schedule as one that assigns all required labor and significant materials, equipment and other costs to activities and compares them with what is available, so it shows whether resources will be there when needed. It also notes that knowing float lets management reassign resources from activities that can slip to those that cannot. 1

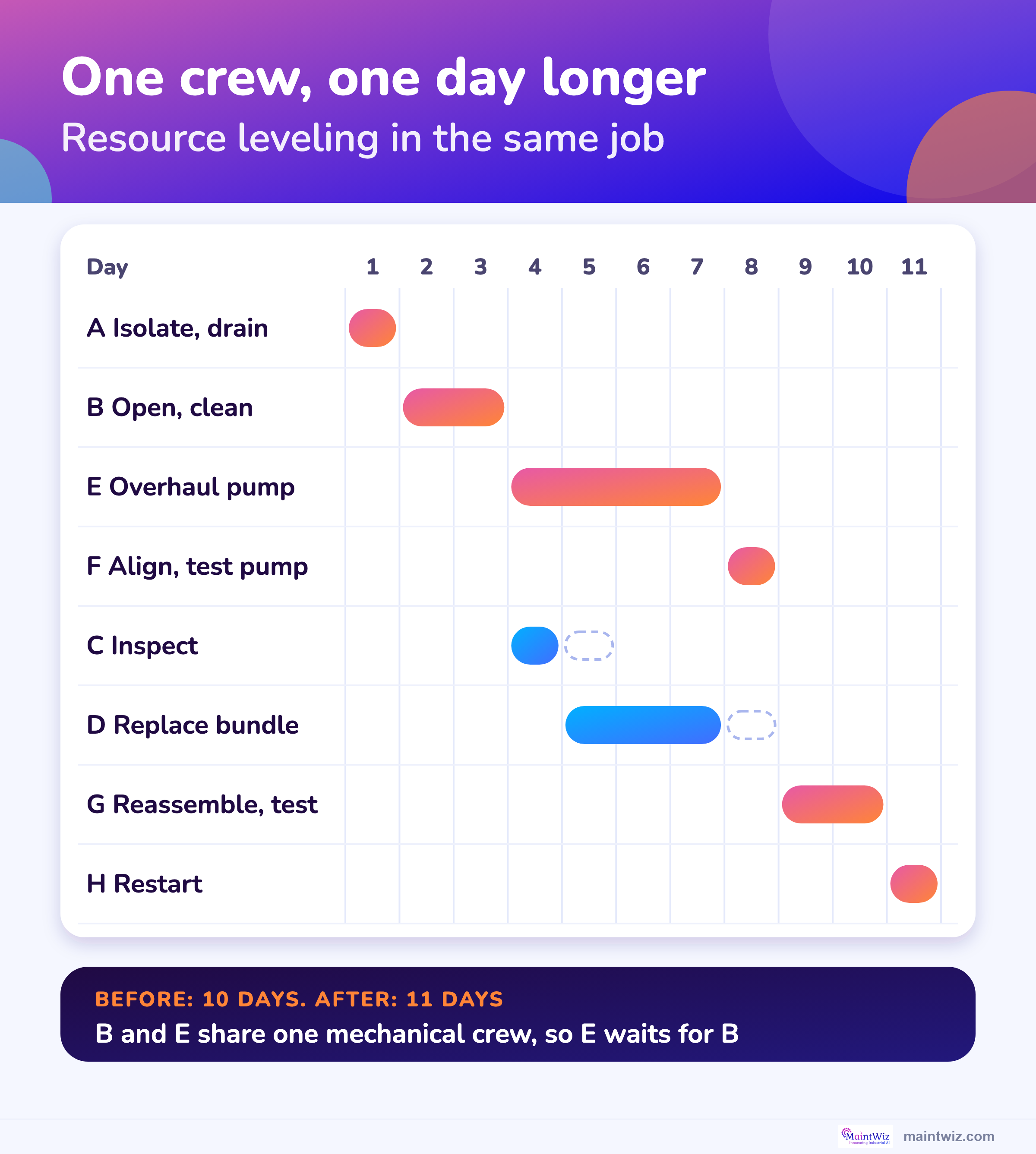

Same job after resource leveling: one mechanical crew for B and E
IDActivityEarly startEarly finishFloatCritical?
AIsolate and drain the unit010Yes
BOpen and clean the heat exchanger130Yes
EOverhaul the pump (waits for the crew)370Yes
FAlign and test the pump780Yes
CInspect the exchanger341No
DReplace the tube bundle471No
GReassemble and leak test8100Yes
HRestart10110Yes

Here E had 1 day of float but had to wait 2 days for B, so E and F became critical and the job grew by 1 day. Shutdown crews, cranes and the permit desk are the usual shared resources. HSE guidance lists competing demands between maintenance, contract work, operation and modifications among the pressures a realistic schedule must manage. 4

Control

How do you keep a shutdown schedule honest while it runs?

To keep a shutdown schedule honest while it runs, baseline it, update it on a fixed rhythm, recalculate the critical path each time, and treat new work as a change request.

Measure progress against the baseline with the shutdown S-curve and percent complete guide.

  1. 1

    Baseline it

    Freeze the agreed plan as the baseline. GAO describes a baseline as the consensus on sequence, resource assignments and acceptable dates. 1

  2. 2

    Update progress on a fixed rhythm

    Record actual progress at the same time each shift or day so the schedule reflects the plant, not last week.

  3. 3

    Recalculate and look at the critical and near-critical paths

    GAO's Gantt chart can show baseline dates, forecast dates and actual progress for each activity. 1

  4. 4

    Treat discovered work as a change

    NERC's generator rules treat discovery work as outside the original scope: in-scope inspection overrun is a planned extension, repairs to damage found are forced outage time. 3

  5. 5

    Recover with a plan, not with float

    Float is shared and not contingency. Re-sequence, add shifts or resources on critical activities, and record why.

More: daily shutdown management · why schedules slip · critical chain · execution.

Errors

What are the common shutdown scheduling errors?

The common shutdown scheduling errors are constraints that override logic, float used as contingency, ignored calendars and resources, and no baseline.

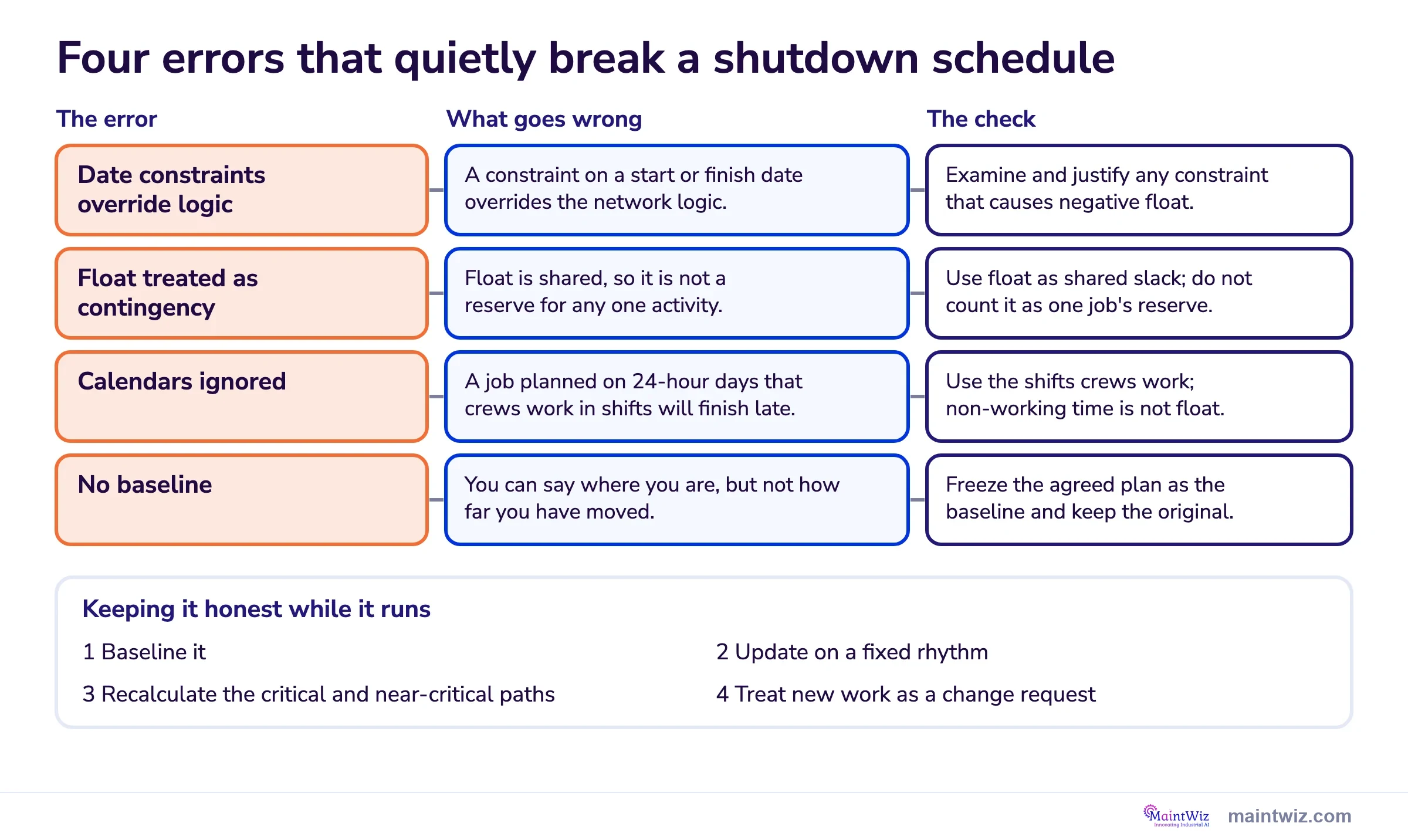

Matrix of four shutdown scheduling errors, such as float used as contingency, with what goes wrong and the check for each
Four scheduling errors. A three-column matrix with a row for each error: Date constraints override logic, Float treated as contingency, Calendars ignored and No baseline. The columns give what goes wrong and the check. A lower box lists four steps to keep the schedule honest.

Run the four checks against your own schedule before the freeze. Look for date constraints that cause negative float, jobs planned on 24-hour days when crews work shifts, and a missing baseline. The box at the bottom gives the routine: baseline, fixed update rhythm, recalculate the paths, treat new work as a change request.

Four scheduling errors: text version
The errorWhat goes wrongThe check
Date constraints override logicA constraint on a start or finish date overrides the network logic.Examine and justify any constraint that causes negative float.
Float treated as contingencyFloat is shared, so it is not a reserve for any one activity.Use float as shared slack; do not count it as one job's reserve.
Calendars ignoredA job planned on 24-hour days that crews work in shifts will finish late.Use the shifts crews work; non-working time is not float.
No baselineYou can say where you are, but not how far you have moved.Freeze the agreed plan as the baseline and keep the original.

Keep it honest while it runs: baseline it, update on a fixed rhythm, recalculate the critical and near-critical paths, treat new work as a change request.

Related: Critical path vs critical chain · Shutdown schedule delays

Date constraints that override logic

A constraint on a start or finish date overrides network logic. GAO says constraints that cause negative float should be examined and justified. 1,2

Float treated as contingency

Float is shared, so it is not a reserve for any one activity. 1

Calendars ignored

A job planned on 24-hour days that crews work in shifts will finish late. Non-working periods are not float. 1

No baseline

Without a baseline you can say where you are, but not how far you have moved. Keep the original plan.

Visuals

Save the scheduling charts

Two scheduling charts to save or share; click for the full-size version.

FAQ

Frequently asked questions

What is the critical path in a shutdown schedule?

It is the longest continuous sequence of activities in the schedule. It defines the earliest completion date, so a delay to any activity on it delays the whole shutdown by the same amount. 1

What is float in a shutdown schedule?

Float is the time an activity can slip before it delays the end date. With no date constraints, critical activities have zero float. 1

Is float the same as contingency?

No. GAO says float should not be treated as schedule contingency, because it is shared along a sequence of activities and any activity on the sequence can use it up. 1

What should a shutdown Gantt chart show?

Every activity as a bar, in logical order, with the critical path marked, resource assignments available, and baseline, forecast and actual dates compared. GAO says a Gantt chart can show baseline dates, forecast dates and actual progress for each activity. 1

Can I schedule a shutdown in Excel?

A spreadsheet can list activities and draw bars. The critical path and float depend on the logic links between activities, so you need a tool that calculates the network, or you must calculate it by hand as in the worked example.

Should the schedule be hour by hour or shift by shift?

Choose a time unit small enough to show your shortest critical activities, and match it to how often you update. This is scheduling guidance, not a sourced benchmark.

What is resource leveling?

It is adjusting the schedule so that activities do not need more of a resource than is available. In the worked example leveling for one shared crew moves the end date from day 10 to day 11. GAO describes resource-loaded schedules as a way to see whether resources will be available when needed. 1

How often should the schedule be updated during a shutdown?

On a fixed rhythm, at least each shift or day, then recalculate the critical and near-critical paths. GAO says management must closely monitor critical and near-critical activities. 1

Put your shutdown schedule in one plan

Book a demo and bring your shutdown schedule. We will show how the module handles the critical path, float and baselines.

Book a demo
