Shutdown budget

How to Estimate a Shutdown Budget: Cost and Contingency

Short answer

A shutdown budget is built bottom-up: estimate each work package, add support costs, then add contingency sized by risk, and track actual cost against the baseline during execution. There is no universal contingency percentage; GAO says there are no set rules for what level is sufficient.

Budget here means direct and support cost. Lost production is counted separately as the cost of delay.

How MaintWiz helps: Budgets slip when cost is seen after the work, not during it. The MaintWiz shutdown module tracks earned value, cost and schedule indices and shows budget, actual and forecast cost in one view. See the module · Get the budget template

By · Published · Last reviewed

What MaintWiz adds:Earned value and cost indicesBudget, actual and forecast costCost by project and packageCumulative spend

Categories

What costs go into a shutdown budget?

A shutdown budget includes labor, contractors, materials and spares, equipment and access, inspection and testing, logistics, engineering and planning, and contingency. Lost production is counted separately.

A budget and contingency workbook is among the free shutdown templates. Parts and long-lead costs are covered in shutdown spare parts planning. Parts demand in SAP: SAP MM shutdown materials.

The work being costed is shutdown maintenance; the cost of the stop itself is covered in planned vs unplanned shutdown cost.

An illustrative budget, in units

Illustrative numbers to show how the parts add up.

Cost categories in a shutdown budget
CategoryWhat it includesHow to estimate it
LaborOwn maintenance and operations staff, including overtime and shift allowancesHours per work package multiplied by the rate
ContractorsContract labor, supervision, mobilization and demobilizationQuoted price, unit rates or hours by trade, depending on the contract
Materials and sparesParts, consumables and long-lead itemsBill of materials per work package, plus freight and handling
Equipment and accessCranes, scaffolding, temporary power, rental toolsDays on site multiplied by the daily rate
Inspection and testingNon-destructive testing, pressure tests, statutory inspectionsQuoted or scheduled per item
Logistics and site servicesGate and induction, accommodation, waste, welfareHeadcount multiplied by days multiplied by the rate
Engineering and planningThe shutdown team, engineering, planning and schedulingTeam size multiplied by months
ContingencyAn amount for uncertainty within the defined scopeSet by risk analysis at the confidence level management chooses
Lost productionOutput that is not made during the stopKept separate from the direct budget; see the cost of a day of delay below

Method

How do you estimate a shutdown budget?

A shutdown budget is estimated bottom-up from the work packages, plus support costs, cross-checked against your own history, with contingency set by risk. This is a practical method; GAO's cost guide organizes its best practices for program estimates into 12 steps.1

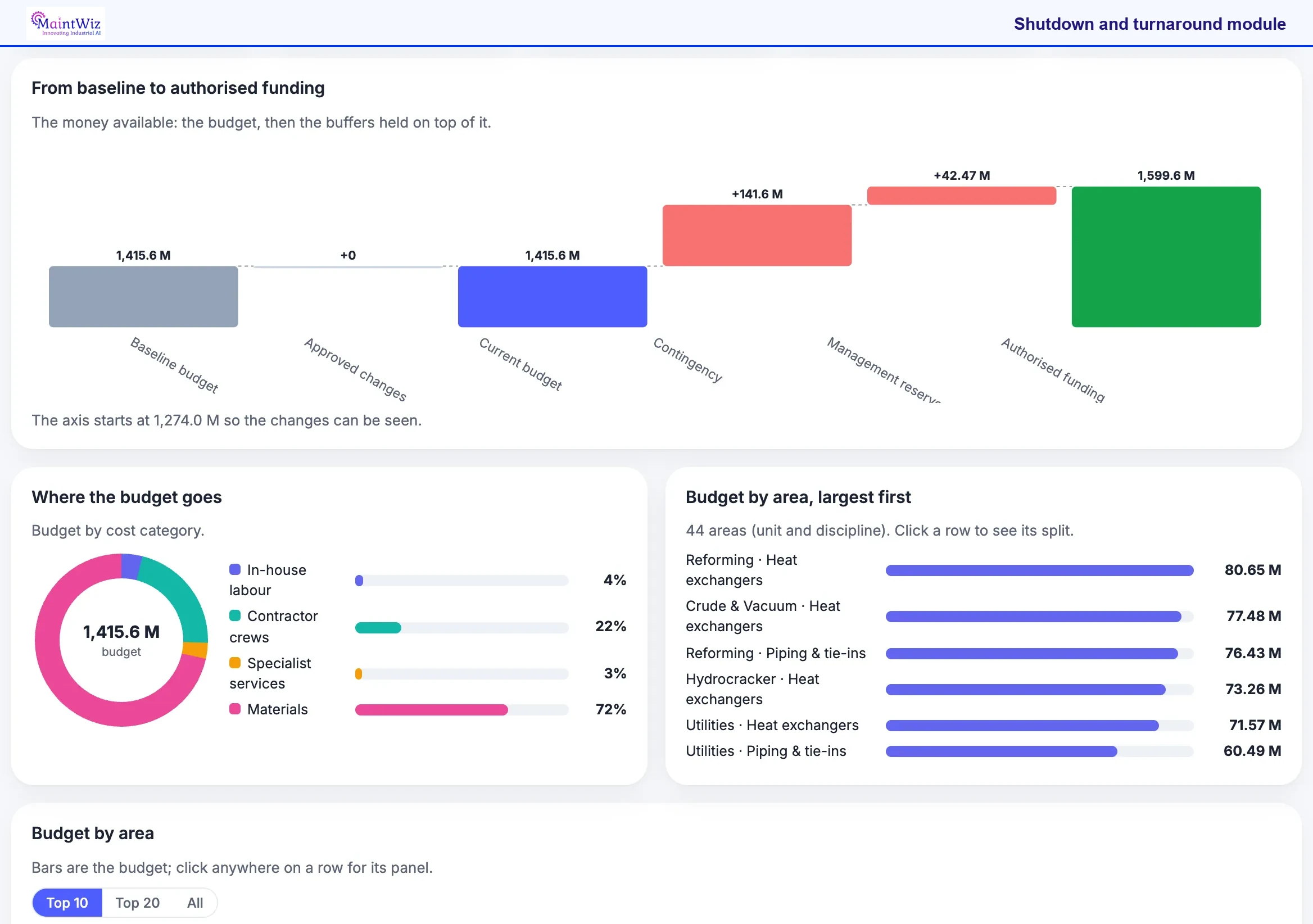

MaintWiz: budget from baseline to authorised funding and budget by area
Budget from baseline to funding. A waterfall, From baseline to authorised funding, steps from baseline budget through approved changes, current budget, contingency and management reserve to 1,599.6 M. Below it sit a Where the budget goes donut by cost category and a Budget by area list, largest first.

Read the waterfall left to right to see how much of the authorised funding is held as contingency and reserve on top of the budget. Then check the cost category split, where materials are the largest share, and the largest areas. These show where the estimate needs the firmest basis.

Past stop costs are history to keep: SAP S4HANA maintenance data migration. Estimate classes and the basis of estimate are explained in turnaround cost estimate and AACE classes.

  1. 1

    Fix the scope

    Start from the frozen scope and work packages. An estimate can only be as firm as the scope behind it.

  2. 2

    Estimate bottom-up

    Cost each work package: hours and rates, materials, equipment, inspection.

  3. 3

    Add support and indirect costs

    Logistics, site services, engineering, planning and management of the stop.

  4. 4

    Cross-check

    Compare the total with the cost of previous shutdowns of similar scope in your own records.

  5. 5

    Analyze risk and set contingency

    Identify what could change the cost and set contingency at a confidence level management chooses. 1

  6. 6

    Document and approve

    Record assumptions, what is in and out of scope, and who approved the number.

  7. 7

    Baseline it

    Fix the approved work budget as the baseline you will measure progress against.

Related: shutdown scope · work packages · risk assessment.

Software

Where should the shutdown budget be tracked?

The shutdown budget should be tracked next to the work packages and schedule, so that actual cost and progress come from the same records.

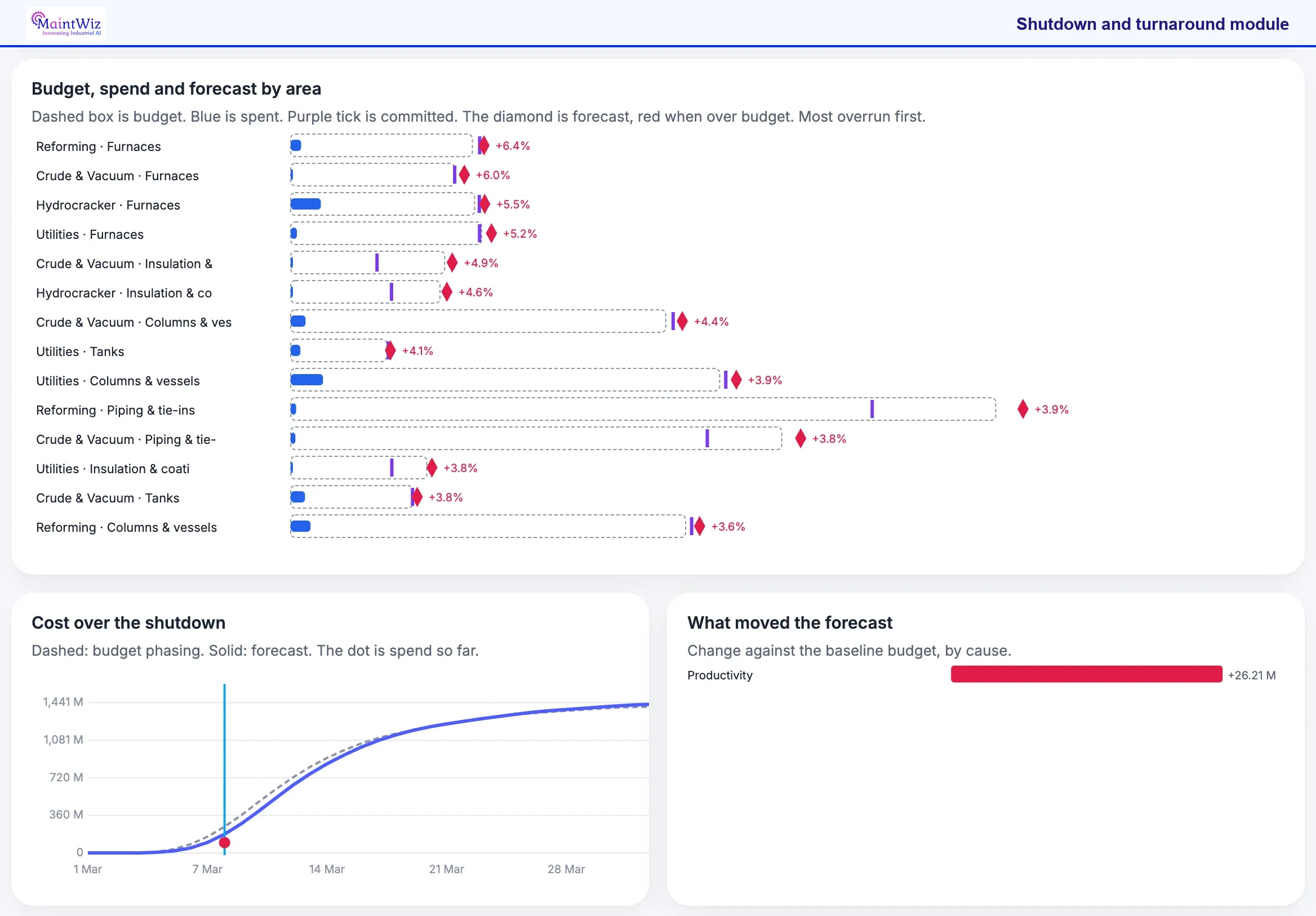

MaintWiz: budget, spend and forecast by area and what moved the forecast
Budget, spend and forecast by area. Three panels: budget, spend and forecast by area, with a dashed budget box, blue spend, purple committed tick and red forecast diamond; cost over the shutdown, budget phasing against forecast; and what moved the forecast, showing Productivity at +26.21 M.

Read the top list from the top: areas are sorted most overrun first, led by Reforming Furnaces. Then check the cost curve for the gap between dashed budget and solid forecast, and the cause bar for why it moved. Use it to pick which area to review with its owner.

For choosing tools see shutdown software vs spreadsheets vs Primavera P6.

Also: maintenance budget module · product data sheet.

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Accuracy

How accurate is a shutdown estimate, and why does scope definition matter?

The better a shutdown scope is defined, the narrower the estimate range. A US Department of Energy protocol says estimate uncertainty is expected to decrease as project definition improves and the project matures, and publishes ranges by estimate class. These come from capital projects; a shutdown estimate may differ, but the direction holds: a frozen scope tightens the range.2

For why estimates fall short, see why shutdowns go over budget.

Estimate uncertainty range by estimate class
Estimate classLow rangeHigh range
Class 5: concept screening-20% to -50%+30% to +100%
Class 4: study or feasibility-15% to -30%+20% to +50%
Class 3: budget authorization-10% to -20%+10% to +30%
Class 2: control or bid-5% to -15%+5% to +20%
Class 1: check estimate-3% to -10%+3% to +15%

The classes are the professional-society ranges as reproduced in the DOE protocol for capital asset projects. They are not shutdown benchmarks.

Contingency

How much contingency should a shutdown budget carry?

No universal contingency percentage exists for a shutdown budget. Set it from a risk analysis at the confidence level management chooses, and reduce it as the scope firms up. The 130 units in the example come from an assumed risk analysis, not from a rule.

See turnaround cost estimate and AACE classes for how to size and hold contingency.

No universal percentage

GAO says that because each program is different, there are no set rules as to what level of contingency is sufficient. 1

Set it by risk

GAO describes the required contingency as the difference between the point estimate and the estimate at the confidence level decision-makers choose. 1

Define what it is for

GAO describes contingency as funds added to an estimate for items, conditions or events whose state, occurrence or effect is uncertain and that experience shows are likely to cost more. 1

Keep it separate from scope changes

Discovered work is outside the original scope in NERC's reporting rules, so decide up front whether contingency covers it or whether it goes through change control. 3

Cost of delay

How do you calculate the cost of one extra day of shutdown?

The cost of one extra day of shutdown is the margin lost for each extra day without production plus the extra cost of keeping the shutdown running. Use margin, not revenue, and count a fixed cost only if the delay adds to it.

For a published example of outage length, see nuclear refueling outage durations. For planned against unplanned cost, see planned vs unplanned shutdown cost.

Cost of one extra day

Daily cost = lost margin + extra running cost

Add the margin lost for each day production is out, and the extra daily cost of keeping the crews, equipment and services on site.

Lost margin per day

Daily output x (price - variable cost)

Use contribution margin, not revenue. Output that is only deferred and sold later is not fully lost.

Do not double count

Count a fixed cost only if the delay adds to it

Fixed costs that are paid anyway are not caused by the delay.

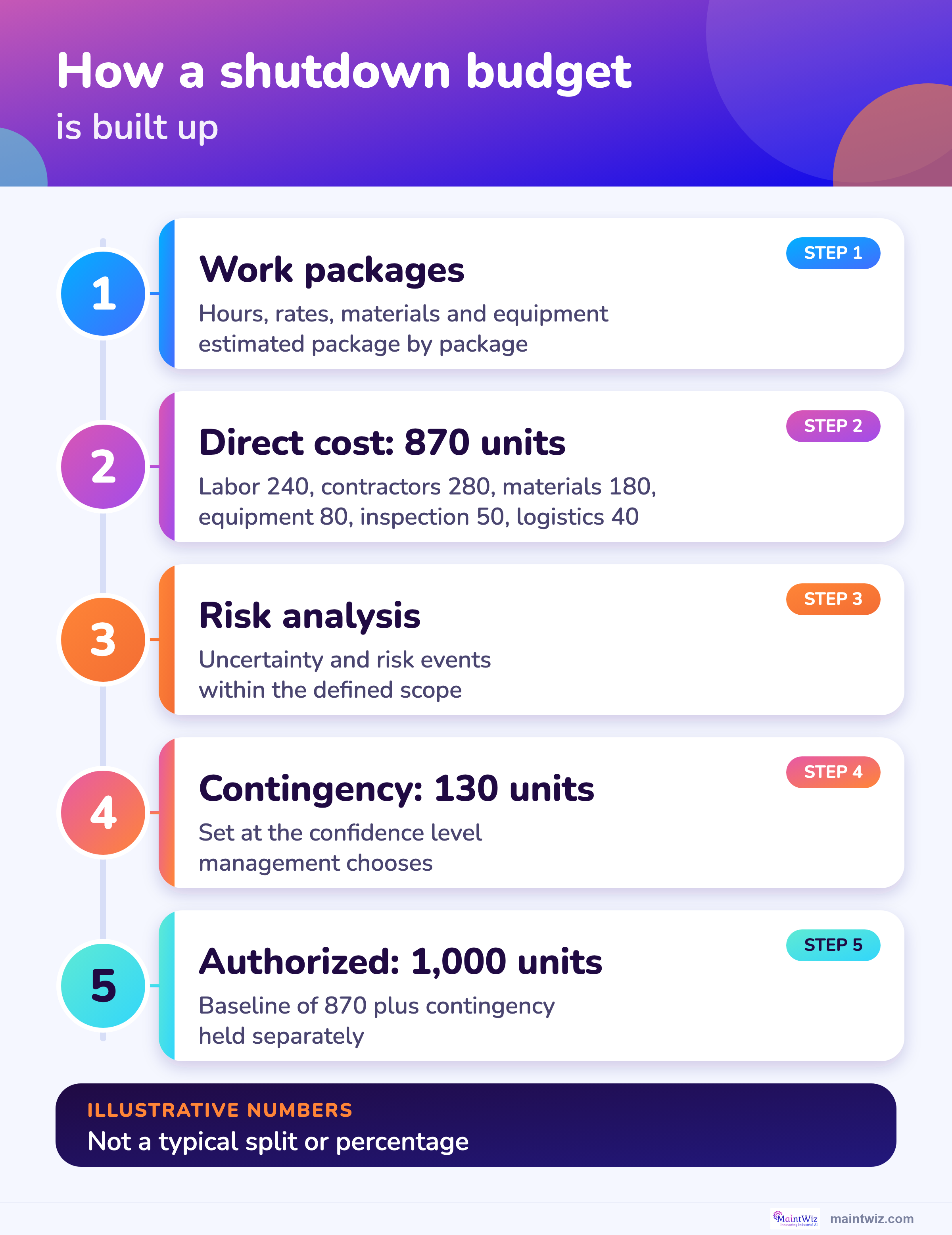

Worked example: cost of one extra day (illustrative units)
ItemPer dayNote
Lost contribution margin120Output not made, valued at price less variable cost
Crews and equipment kept on site25Extra daily cost caused by the delay
Site services5Only the part that continues because of the delay
Cost of one extra day150Sum of the three lines

The numbers are for illustration. No source gives a typical cost of delay for any industry.

Try it: cost of delay

Enter your own numbers. Nothing is sent or stored; the sums run in your browser. The starting values are the illustrative numbers from the worked example.

Cost of one extra day150
Cost of the delay450

Cost control

How do you control cost during the shutdown?

Cost control during the shutdown means measuring earned value against planned value and actual cost, and forecasting the final cost from performance to date. GAO describes earned value management as comparing the value of work accomplished with the actual cost and with the work planned, and measures differences as cost and schedule variances.1

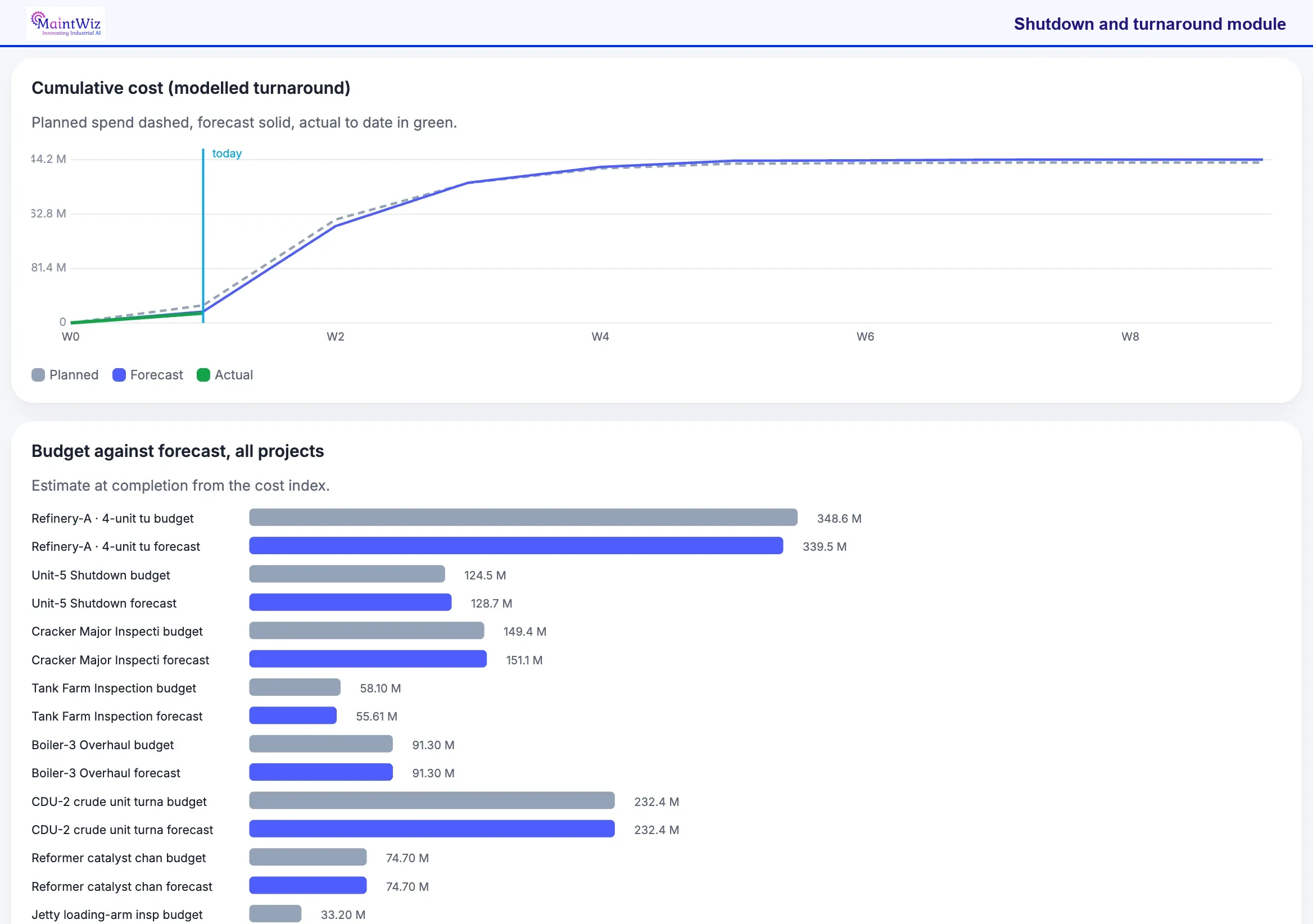

MaintWiz: cumulative cost curve and budget against forecast for all projects
Cumulative cost curve. A cumulative cost chart for a modelled turnaround (planned dashed, forecast solid, actual in green, with a today marker) above a Budget against forecast panel with a bar pair per project, such as Refinery-A at 348.6 M budget and 339.5 M forecast.

Check the gap between the dashed and solid lines at the today marker, then scan the paired bars for any project where the forecast bar is longer than the budget bar, such as Unit-5 Shutdown. Those are the projects to take to cost control at the next review.

For measuring the return on a shutdown program, see shutdown program ROI. The cost measures in a worked example: shutdown case study. A free Excel file for this page: budget and contingency workbook (.xlsx). If a software line is in the budget, see turnaround software cost. Cost-control tools compared: Cleopatra Enterprise alternatives.

Cost variance (CV)

CV = BCWP - ACWP

Earned value minus actual cost. Positive is favorable.

Cost performance index (CPI)

CPI = BCWP / ACWP

Above 1.0 the work cost less than planned.

Schedule variance (SV)

SV = BCWP - BCWS

Earned value minus planned value. Positive is ahead.

Schedule performance index (SPI)

SPI = BCWP / BCWS

Above 1.0 more work was done than planned.

Estimate at completion (EAC)

EAC = ACWP + (BAC - BCWP) / efficiency index

The forecast final cost, adjusted by past performance.

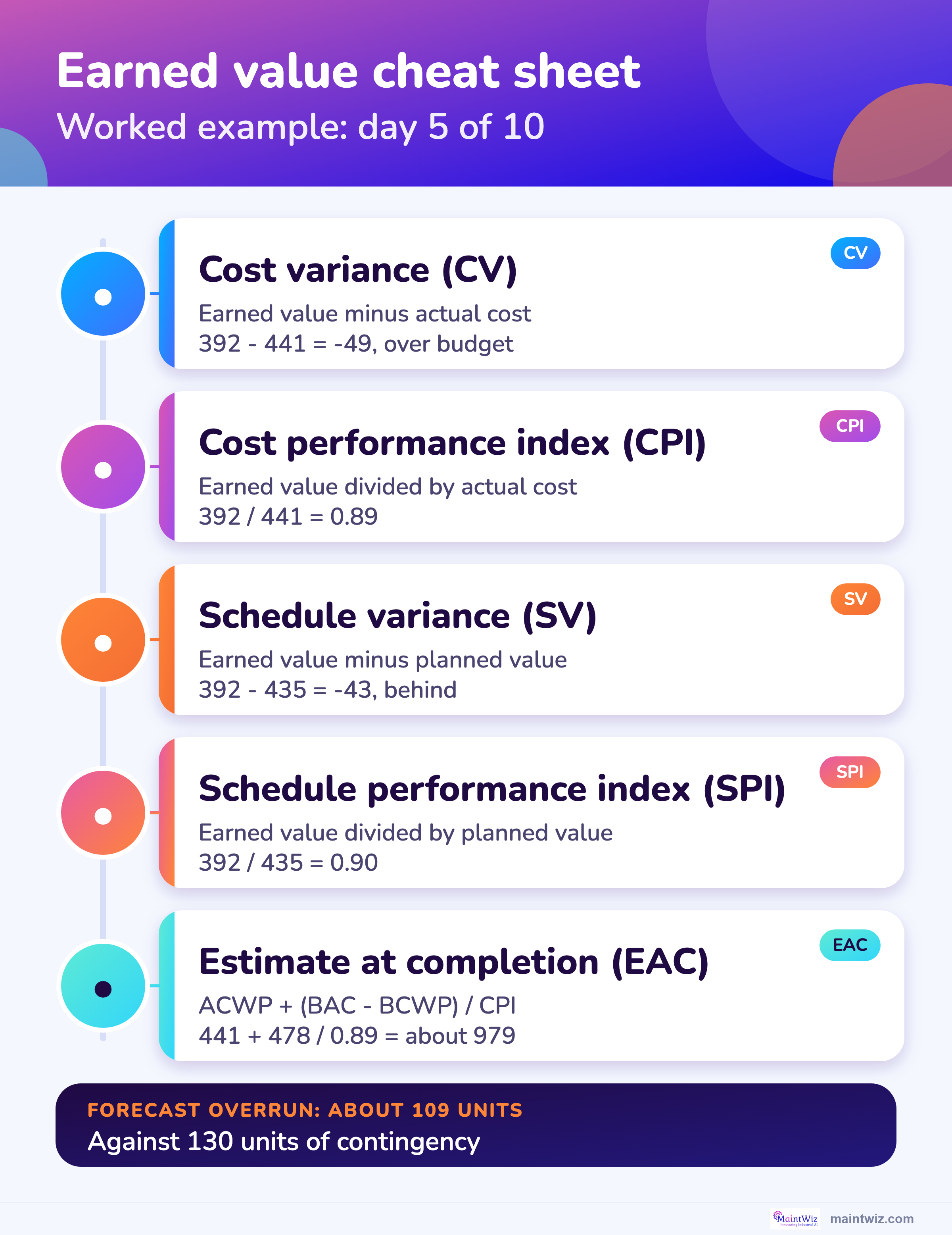

Worked example: day 5 of a 10-day shutdown (illustrative units)
MeasureValueHow it is found
Budget at completion (BAC)870The baseline for the work, excluding contingency
Planned value (BCWS)435Work planned by day 5 (half the baseline)
Earned value (BCWP)392Budget of the work actually completed
Actual cost (ACWP)441What has been spent
Cost variance-49392 - 441: over budget
CPI0.89392 / 441
Schedule variance-43392 - 435: behind plan
SPI0.90392 / 435
EAC (using CPI)about 979441 + (870 - 392) / 0.89
Forecast overrunabout 109979 - 870, against 130 of contingency

GAO defines BCWP (earned value) as the budget for completed work, BCWS as the budget for work scheduled, and ACWP as actual cost. A CPI below 1.0 means the work cost more than planned, and GAO notes an unreliable earned value system gives unreliable results, so keep progress reporting honest. 1 Set variance thresholds that trigger action to suit your own history; no source gives a universal one.

Related: cost variance analysis · shutdown ROI · shutdown KPIs.

Visuals

Save the budget charts

Two budget charts to save or share. Click either to see it at full size.

FAQ

Frequently asked questions

How do you estimate a shutdown budget?

Estimate each work package bottom-up (hours, rates, materials, equipment, inspection), add support and indirect costs, cross-check against your own history, then add contingency from a risk analysis and baseline the approved work budget. GAO organizes its cost-estimating best practices into 12 steps. 1

What costs are included in a shutdown budget?

Labor, contractors, materials and spares, equipment and access, inspection and testing, logistics and site services, engineering and planning, and contingency. Lost production is counted separately as the cost of delay.

How much contingency should a shutdown budget have?

There is no universal percentage. GAO says there are no set rules as to what level of contingency is sufficient, and that the required amount is the difference between the point estimate and the estimate at the chosen confidence level. 1

How accurate is a shutdown cost estimate?

It depends on how well the scope is defined. A DOE protocol says estimate uncertainty is expected to decrease as project definition improves, and lists ranges by estimate class for capital projects, from -20% to -50% and +30% to +100% for a concept screening estimate to -3% to -10% and +3% to +15% for a check estimate. 2

How do you calculate the cost of one extra day of shutdown?

Add the contribution margin lost for the day (output multiplied by price less variable cost) to the extra daily cost of keeping the crews, equipment and services on site. Count a fixed cost only if the delay adds to it. The worked example above uses illustrative numbers.

What is earned value?

Earned value (BCWP) is the budget for the work actually completed. Comparing it with actual cost gives cost variance and CPI; comparing it with planned value gives schedule variance and SPI. 1

How do you read a CPI of 0.89?

It means the work completed so far cost about 12% more than budgeted for that work (1 / 0.89). A CPI below 1.0 means work cost more than planned. 1

Why do shutdown budgets overrun?

A common cause is work found after the scope is fixed: NERC's generator reporting rules treat discovery work as outside the original scope of work. Freeze the scope, hold contingency for uncertainty, and put later work through change control. See shutdown scope definition. 3

See cost and schedule performance in one view

Book a demo and bring your shutdown budget. We will show earned value and forecast cost in the module.

Book a demo
