Skip to content
MaintWiz: Innovating Industrial AI

UK and EU rules

HSG253 Safe Isolation Shutdown: UK and EU Rules

Short answer

HSE guidance HSG253 sets three isolation categories for shutdown work, positive, proved and non-proved, and says to plan intrusive maintenance for shutdown periods; COMAH 2015, the UK form of Seveso III, applies to sites by their dangerous substances. This page maps those rules to the work you plan.

How MaintWiz helps: Safe isolation depends on records that match the work. The MaintWiz shutdown module shows permits and isolations from ePTW on each work order and blocks closing a package while a permit or isolation is open. See the module · Get the permit register

By · Published · Last reviewed

What MaintWiz adds:Permits and isolations from ePTWShown on each work orderPackage cannot close with an open permitApprovals by signed-in user

HSG253

What does HSG253 require for isolation during a shutdown?

HSE guidance HSG253 sets three categories of isolation for work on process plant, positive, proved and non-proved, says to minimize isolation needs by planning intrusive maintenance for shutdown periods, and requires the choice of method to rest on a risk assessment. 1

HSE says any intrusive activity could allow hazardous substances to escape, that adequate isolation is critical to avoiding loss of containment, and that isolation requirements should be minimized where practicable by planning intrusive maintenance for shutdown periods. 1 The three categories are shown below; the guidance says the methods within a category do not all give equal security and the choice should rest on risk assessment. 1

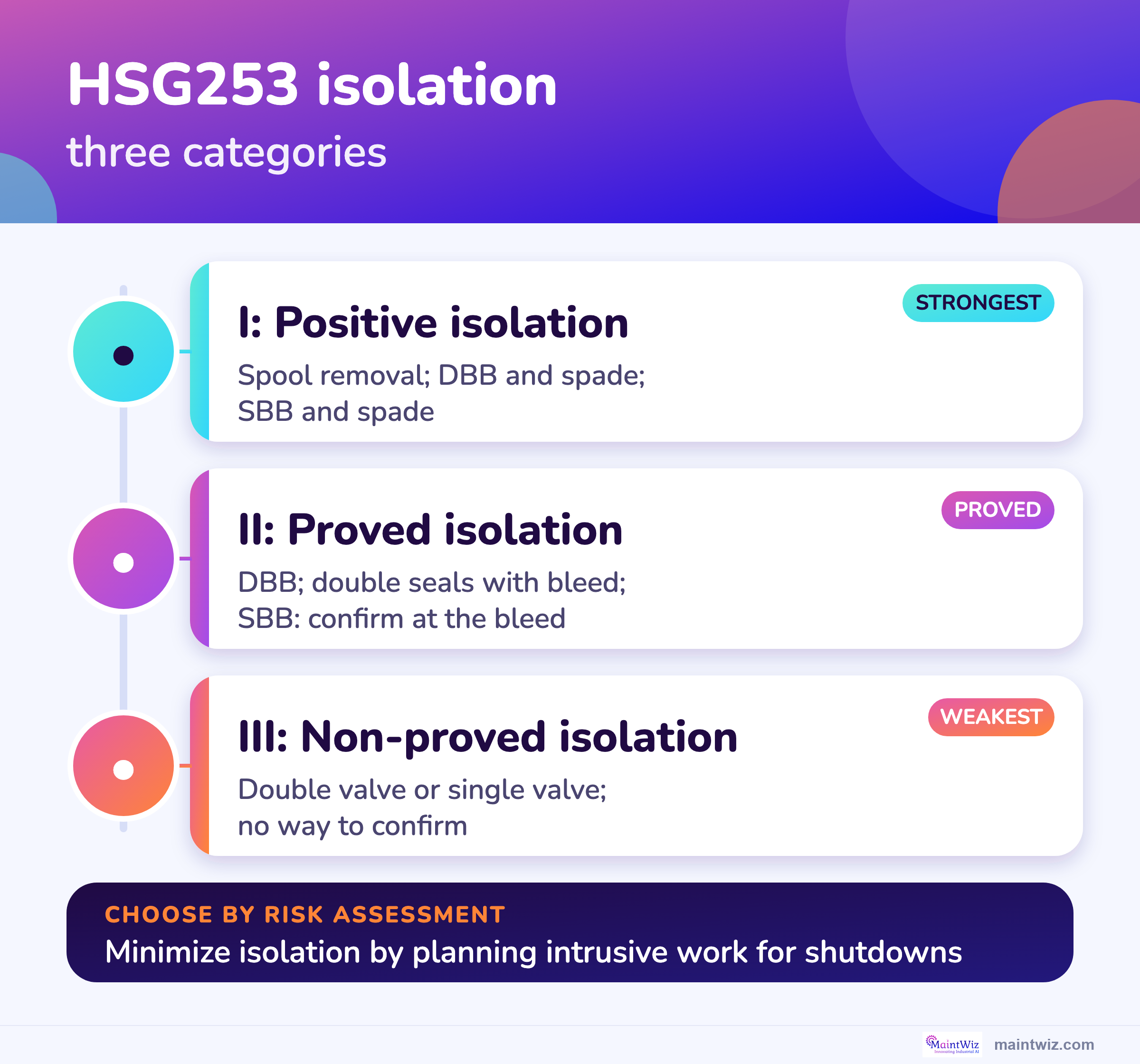

HSG253 isolation categories
CategoryMethodWhat it isHSE note
I: positive isolationPhysical disconnection (for example spool removal); double block, bleed and spade; single block and bleed and spadeComplete separation of the plant to be worked on from other parts of the system; valved isolation of an appropriate standard is needed while the positive isolation is installedA very high standard for vessel entry; good practice for confined space entry, toxic fluids and extended isolations
II: proved isolationDouble block and bleed (DBB); double seals in a single valve body with a bleed in between; single block and bleed (SBB)Valved isolation whose effectiveness can be confirmed through vent or bleed points before intrusive work startsMechanical security is greatest for DBB and lowest for SBB; as a general rule SBB should not be the final isolation for work on live plant with hazardous substances, unless a risk assessment accepts it
III: non-proved isolationDouble valve; single valveValved isolation with no provision to confirm that the valves are effective before breaking into the systemWhere possible, use double valve rather than single valve

HSE notes that all isolation methods can fail, even positive isolations, particularly during installation and plant reinstatement, and that human failure is a major factor in reliability. 1 It adds that a positive isolation is good practice for confined space entry, toxic fluids and extended isolations, and that physical disconnection should be used where reasonably practicable because removal of a spool is simpler to monitor than a correctly installed spectacle plate. 1

Proving

How does HSG253 treat proving and removing isolations?

HSG253 says to prove both the initial valved isolation and the final isolation of a positive scheme, not to rely on an isolation that cannot be proved, and to check vents or drains behind a blank before removing it. 1

A free Excel version is available: Isolation method and proving checklist (HSG253) (.xlsx).

Proving and removing isolations (HSG253)
TopicWhat HSE says
Proving a positive isolationThere are two stages of testing: prove the initial valved isolation and the final isolation; the procedure must specify the arrangements, the success criteria and the test pressure
When an isolation cannot be provedDo not rely on it; extend the isolation boundary or defer the work until shutdown, and consider a plant modification to add test facilities
Short-duration workA less secure method can be used only where the overall risk of using positive isolation, including installing and removing it, is greater than the risk of the less secure method
Removing a positive isolationHazardous substances can build up behind a blank or spade if a valve leaks; check vents or drains before it is removed, and stop work if a leak is found
PaperworkUse isolation certificates and similar documentation to record the isolation

See the permit to work guide for the isolation register and blind list.

The rows paraphrase paragraphs 132, 133, 166 to 168, 186 and 187 of HSG253.

Software

Can software support UK and EU shutdown safety?

Software cannot choose an isolation method, but it can keep the permit, the isolation points, the proof readings and the sign-offs in one record, so the evidence the guidance expects is easy to find.

What the shutdown module covers

  • Permits and isolations from ePTW shown on each work order, with a block on closing a package while one is open
  • Work order tasks with readings, limits and photos as proof of isolation steps
  • Readiness gates with signed waivers and sign-offs with the name and date
  • Preventive maintenance scheduling and instruments and calibration shared with the platform
  • Handover note and as-left summary on each work order
  • Approvals recorded against the signed-in user with the name and the time

COMAH

Does COMAH apply to shutdown maintenance?

COMAH applies to a site because of the dangerous substances it holds, not because of an activity, so a shutdown at a COMAH site happens under the site's major accident prevention policy and safety report, which cover operational control and management of change. 2

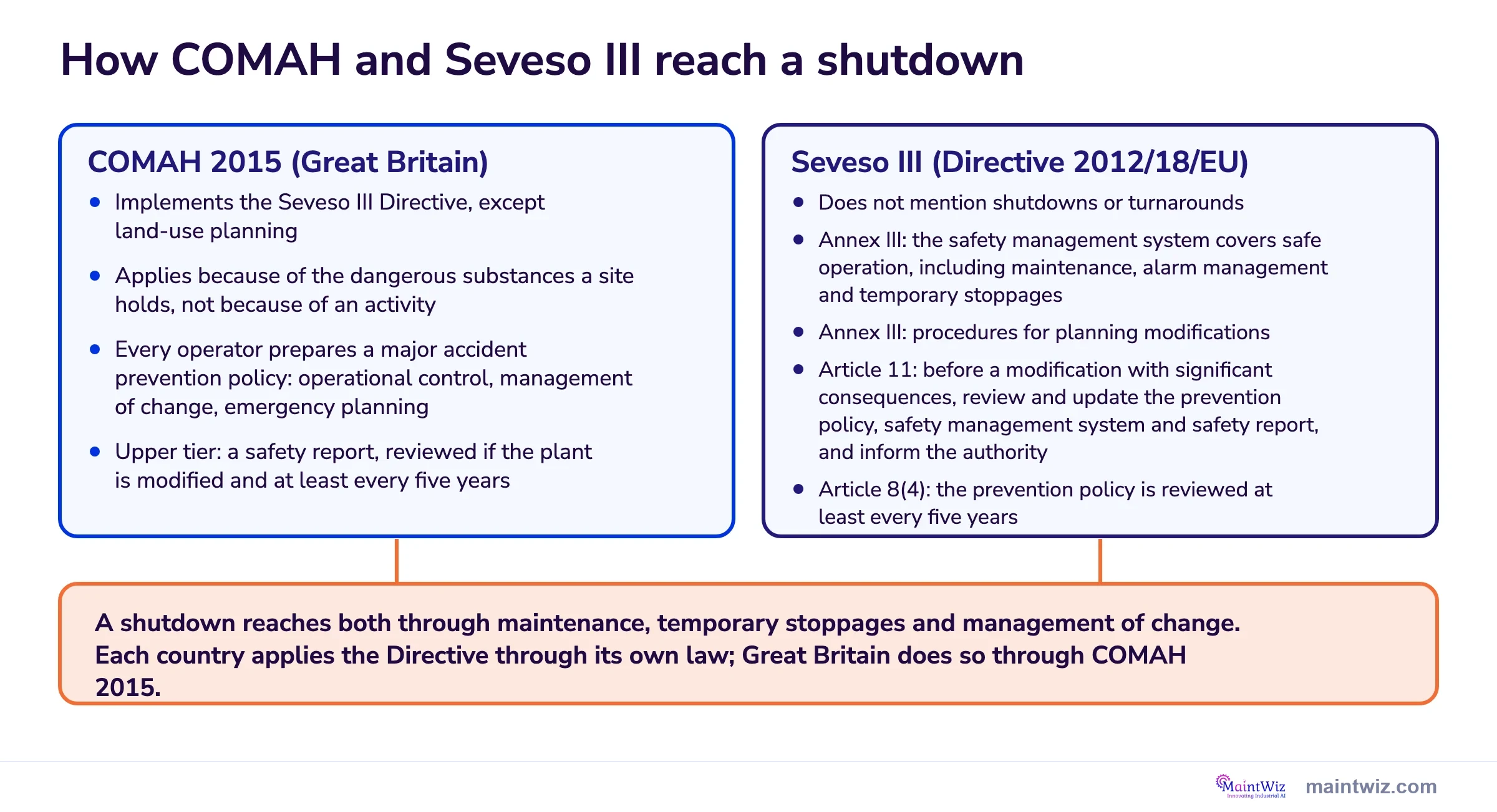

Two panels showing how COMAH 2015 in Great Britain and Seveso III in the EU reach a shutdown through maintenance and change
COMAH and Seveso III. Two side-by-side panels, COMAH 2015 for Great Britain and Seveso III (Directive 2012/18/EU), each listing the duties that matter. A box below states that a shutdown reaches both through maintenance, temporary stoppages and management of change.

Read the bottom box first, then use the two panels to find the duties that apply to your site: operational control, management of change and the safety report review. Check that each shutdown change goes through your management of change process and that the safety report is reviewed when the plant is modified.

COMAH and Seveso III: text version
RegimeHow it reaches a shutdown
COMAH 2015Implements Seveso III except land-use planning; applies because of substances held; prevention policy incl. operational control and management of change; upper-tier safety report
Seveso IIIDoes not mention shutdowns; Annex III covers maintenance, alarm management, temporary stoppages and modifications; Article 11 modifications; Article 8(4) five-year review

Summary of the page tables, sourced to HSE and Directive 2012/18/EU. Check current text.

Related: PSSR and pressure systems · OSHA rules for shutdowns

COMAH 2015 in brief (HSE description)
ItemWhat HSE says
What it implementsThe Seveso III Directive, except land-use planning, which is handled through planning legislation; it replaced COMAH 1999 and came into force on 1 June 2015
Who it applies toEstablishments with dangerous substances above the lower or upper threshold in Schedule 1; the upper threshold brings upper tier duties
General dutyTake all measures necessary to prevent major accidents and limit their consequences to people and the environment
Major accident prevention policyEvery operator prepares one; key areas include organization, hazard identification, operational control, management of change, emergency planning, and monitoring, audit and review
Safety reportUpper tier operators prepare one; it must be reviewed and revised if the plant or its operation is modified or new information affects the risk, and in any case every five years

HSE's page does not discuss maintenance explicitly; it refers to prevention measures such as safe plant and safe operating procedures and to the policy elements above. 2 Changes made during a shutdown are therefore a COMAH matter if they change the plant or its operation. See the execution guide for change control and the audit guide.

Whether your site is a COMAH establishment depends on Schedule 1 and your inventory; check with your safety team and the competent authority.

Seveso III

What does Seveso III require during plant maintenance shutdowns?

Seveso III (Directive 2012/18/EU) does not mention shutdowns or turnarounds. It reaches maintenance through two provisions: the safety management system must cover safe operation, including maintenance and temporary stoppages, and management of change (Annex III), and a modification that could have significant consequences for major-accident hazards means the operator must review and update its prevention policy, safety management system and safety report, and inform the competent authority in advance (Article 11). 6 Each EU country applies the Directive through its own law; Great Britain does so through COMAH 2015. 2

The Seveso III link
QuestionAnswer
Is COMAH the UK form of Seveso III?HSE says COMAH 2015 implements the Seveso III Directive, except land-use planning
What is the Directive?Directive 2012/18/EU of 4 July 2012 on the control of major-accident hazards involving dangerous substances; Member States apply it from 1 June 2015 (Article 31) 6
What does it say about maintenance?Annex III: the safety management system covers procedures for safe operation, including maintenance, of plant, processes and equipment, and for alarm management and temporary stoppages 6
What does it say about change?Annex III: procedures for planning modifications to, or the design of new, installations, processes or storage facilities. Article 11: review and update the notification, prevention policy, safety management system and safety report, and inform the competent authority, in advance of a modification that could have significant consequences for major-accident hazards 6
How often is the prevention policy reviewed?Article 8(4): at least every five years, without prejudice to Article 11 6
What is the operator's general duty?Article 5: take all necessary measures to prevent major accidents and limit their consequences, and prove to the competent authority at any time that they have been taken 6

For EU sites, read the national law that implements the Directive, because it can add duties. The Directive's test is whether a change could have significant consequences for major-accident hazards, and the review comes in advance of the modification. Our reading: list such changes in the shutdown scope before the work is released. Whether a given job meets the test is for your safety team and the competent authority.

Terms

Which UK and EU safety terms apply to a shutdown?

The terms a UK or EU shutdown planner meets most are PSSR, HSG253, HSG250, HSG159 and COMAH, and PSSR means something different in the US. 3,1,4,5,2

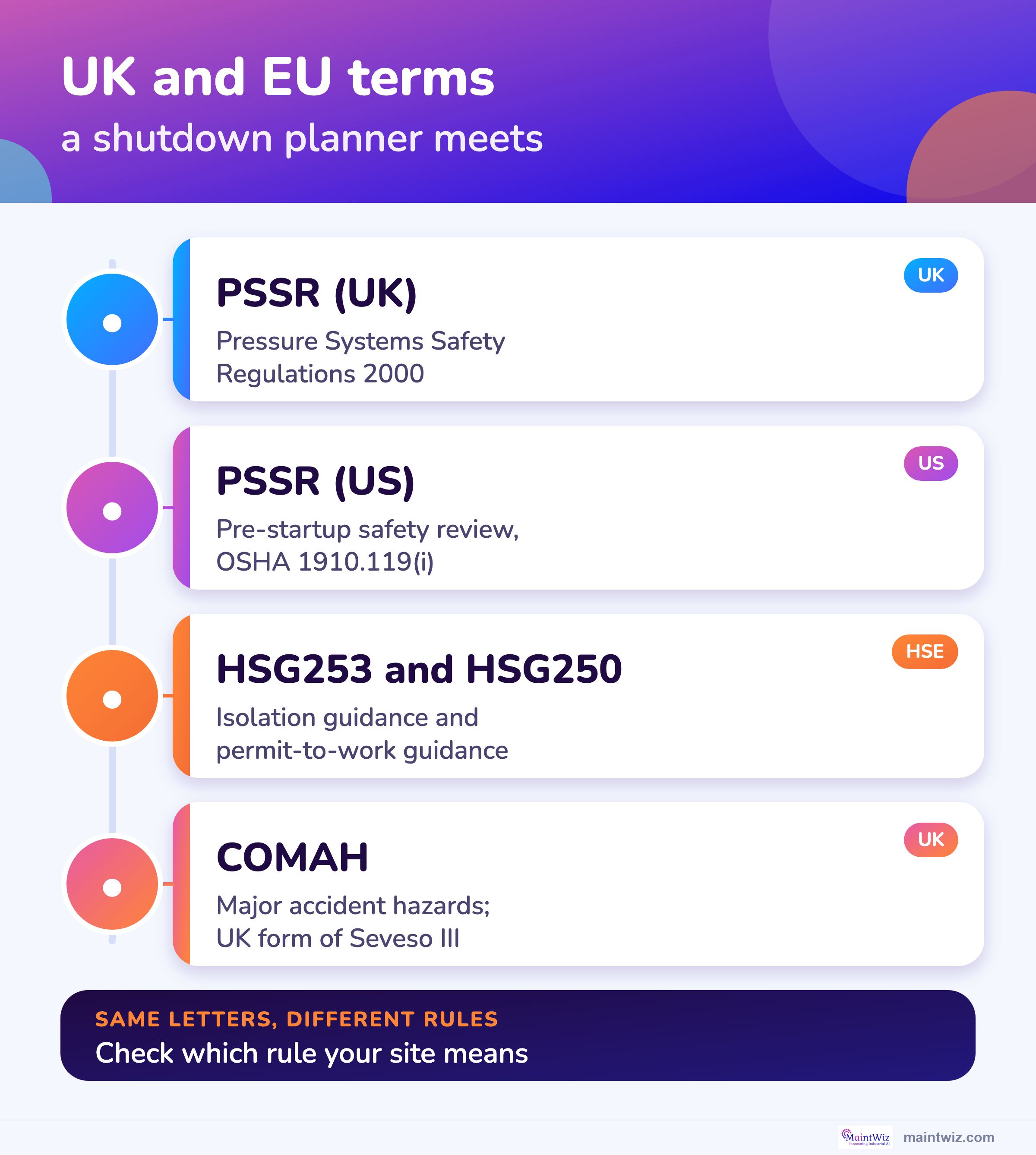

UK and EU terms you will meet
TermMeaningRead more
PSSR (UK)Pressure Systems Safety Regulations 2000: written scheme of examination before usePSSR in the UK
PSSR (US)Pre-startup safety review under OSHA 1910.119(i)Start-up after shutdown
HSG253HSE guidance on the safe isolation of plant and equipmentThis page
HSG250HSE guidance on permit-to-work systems for the petroleum, chemical and allied industriesPermit to work
HSG159HSE guide to managing contractorsContractor management
COMAHControl of Major Accident Hazards Regulations 2015This page

Visuals

Save the UK and EU charts

Two charts to share with your safety team. Click either for the full-size image.

FAQ

Frequently asked questions

What does HSG253 say about shutdowns?

It says to minimize isolation needs by planning intrusive maintenance for shutdown periods, and to choose the isolation method by risk assessment. 1

What are the three isolation categories?

Positive isolation (category I), proved isolation (II) and non-proved isolation (III). 1

Should single block and bleed be used?

As a general rule not as the final isolation for work on live plant containing hazardous substances, unless a risk assessment shows it is acceptable. 1

Does COMAH apply to shutdown maintenance?

COMAH applies by dangerous substance inventory; shutdowns at a COMAH site fall under the site's prevention policy and safety report. 2

How does COMAH relate to Seveso III?

HSE says COMAH 2015 implements Seveso III, except land-use planning. 2

What is PSSR in the UK?

The Pressure Systems Safety Regulations 2000. 3 See PSSR in the UK.

Where is the permit guidance?

HSE HSG250 covers permit-to-work systems for the petroleum, chemical and allied industries. 4 See permit to work during a shutdown.

Is this page legal advice?

No. It summarizes HSE guidance and an HSE description of COMAH; read the source documents and ask your safety team.
