Cost comparison

Planned vs Unplanned Shutdown Cost: Formulas

Short answer

A planned shutdown costs less than an unplanned stop for the same repair because the work, parts and crews are arranged in advance. The difference is built from lost margin, labor and material premiums, short-notice contractors, secondary damage and restart losses, which a formula and calculator can add up.

The calculator uses your own numbers; no cost-per-hour benchmark is quoted because none has a public source.

How MaintWiz helps: Knowing the cost of a day makes the case for planning. The MaintWiz shutdown module tracks earned value, cost and schedule indices and shows budget, actual and forecast cost in one view. See the module · Get the budget template

By · Published · Last reviewed

What MaintWiz adds:Earned value and cost indicesBudget, actual and forecast costCost by project and packageCumulative spend

Definitions

What is the difference between a planned and an unplanned shutdown?

A planned shutdown is scheduled in advance with its scope set beforehand, and an unplanned shutdown is not scheduled: EIA describes emergency shutdowns as bringing a unit down immediately, and AFPM says the key distinction between a turnaround and an unplanned outage is that turnarounds are planned. 1,2

In power generation NERC grades unplanned stops by urgency: forced outages that cannot be deferred past the end of the next weekend, and maintenance outages that can wait a few days but not until the next planned outage. 3 The full classification is in types of plant shutdowns and turnaround vs shutdown vs outage.

Cost components

Where does the cost difference come from?

The difference comes from six components: lost production, labor, materials, contractors, secondary damage and restart losses, and each is usually higher when the stop is not planned.

Cost components of planned and unplanned stops (working analysis)
ComponentPlannedUnplannedHow to count it
Lost productionKnown window, often placed in low-demand seasonStarts without warning, often at peak demandMargin lost per hour times hours down
LaborPlanned crews at normal ratesCall-outs and overtimeHours times rate, with premium
MaterialsOrdered ahead at normal lead timeExpedited freight, premium prices, emergency purchasesParts cost plus expedite cost
ContractorsContracted and mobilized in advanceShort-notice mobilizationPremium over contract rate
Secondary damageRare if isolations and procedures holdPossible if equipment fails while runningRepair cost of the extra damage
RestartPlanned and rehearsedOften done under pressureRestart losses and off-spec product

Count a fixed cost only if the stop adds to it, and use margin, not revenue, for lost production.

Software

How can software help move work into the plan?

Software can hold the standing backlog, link work orders to condition data and show which jobs are ready for the next window, so fewer of them become emergencies.

MaintWiz: cost of delay and downtime cost per day across projects
Cost of delay per day. A bar chart of cost of delay from +0 d to +10 d, driven by a per-day input set to 10.0 (M). Below it, a table gives downtime cost per day and exposure if one week late for five projects, from Refinery-A to Boiler-3 Overhaul.

Check the table first: exposure if one week late is the per-day figure times seven, so it shows which project hurts most when late. The bars show how cost builds with each extra day. Use both to rank which delays to attack first and to price a recovery option against the days it saves.

Also: product data sheet.

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Calculator

How do you calculate the cost of an unplanned stop against a planned one?

Add lost margin (margin per hour times hours down), repair cost and any premiums for each case, and compare the totals; the difference is the cost of the stop not being planned.

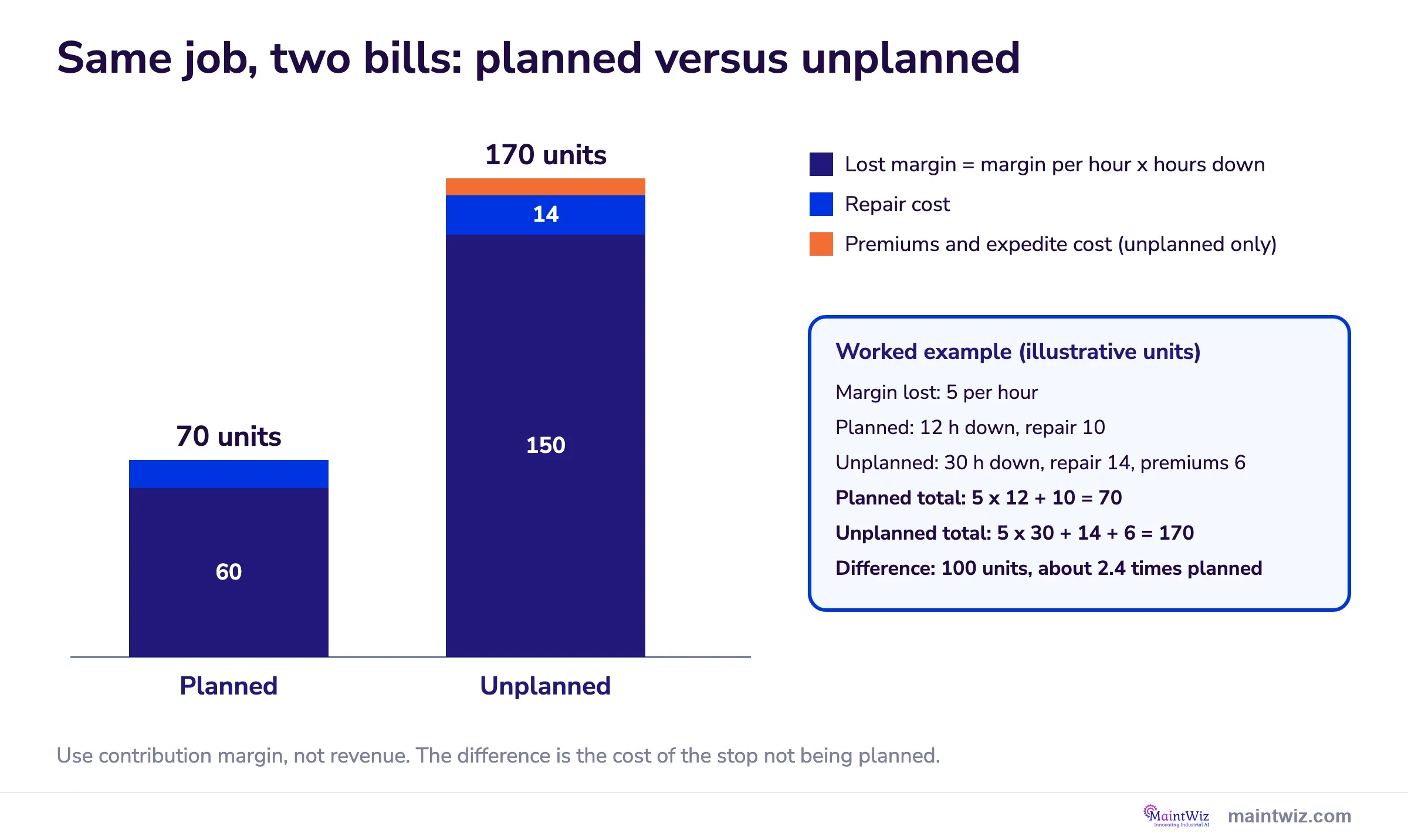

Stacked bars comparing an illustrative planned stop at 70 cost units with the same job unplanned at 170 units
Same job, two bills. Two stacked bars for the same job, planned at 70 units and unplanned at 170 units, split into lost margin, repair cost, and premiums and expedite cost, with a worked-example box that sets out the arithmetic for each bar.

Compare the lost-margin segment first: most of the gap comes from the extra hours down, with premiums a thin top layer. To use it for your own job, put your margin per hour and the hours down into the formula in the box. Use contribution margin, not revenue, as the footnote says.

Same job, two bills: text version
PlannedUnplanned
Hours down1230
Lost margin (5 per hour)60150
Repair cost1014
Premiums and expedite06
Total70170

Illustrative units. Total = margin lost per hour x hours down + repair cost + premiums and expedite cost; the difference (100) is the cost of the stop not being planned.

Related: Shutdown calculators · Shutdown ROI

See the shutdown calculator tools for related tools.

Try it: planned versus unplanned cost of the same job

Enter your own figures. Use contribution margin, not revenue. The starting numbers are for illustration; change them to your own to see your result. Nothing is sent or stored; the sums run in your browser.

Planned total
Unplanned total
Difference
Unplanned as a share of planned

The cost-of-delay version for an extra day of a planned shutdown is in shutdown budget planning. Avoid counting revenue and margin together, which double counts.

Evidence

What is the cost difference between planned and unplanned shutdowns?

DOE's operations and maintenance guide estimates that preventive maintenance saves 12 to 18 percent over a reactive program and predictive maintenance a further 8 to 12 percent over preventive alone, but these are program-level estimates for facility equipment, not shutdown costs. 4

For testing a savings claim, see shutdown program ROI.

DOE's guide also describes the maintenance approaches themselves: preventive work on a time or run-time schedule and predictive work based on measurements. 5

Reducing it

How do you turn unplanned stops into planned ones?

Keep a standing backlog of jobs that need an outage, use condition measurements to time work before failure, and place the work in the next planned window; these are working practices, not sourced results.

See shutdown program ROI for the formulas and a calculator. For building the estimate, see how to estimate a shutdown budget. A free Excel file for this page: budget and contingency workbook (.xlsx).

The backlog and its fields are in shutdown scope management; interval and condition-based timing are in how often a plant should shut down.
