Shutdown Progress Tracking: Daily Report and S-Curve

Short answer

To track shutdown progress, measure completed steps and actual dates against the baseline, report every job to one status date, plot planned and actual progress on an S-curve and review it at a short daily meeting. A one-page daily report and a simple forecast turn the numbers into decisions.

Daily management is part of phase 4 of the five-phase model, with project control running through it.

How MaintWiz helps: Daily meetings work best on live status, not yesterday's spreadsheet. The MaintWiz shutdown module gives technicians checklists with readings and photos, sends findings to the planner and shows a Today view of what needs attention. See the module · Get the daily progress template

By · Published · Last reviewed

What MaintWiz adds:Today page for the plannerChecklists with readings and photosFindings to the plannerHandover notes and as-left summary

Measuring

How should shutdown progress be measured?

Measure progress by completed steps and actual dates, not by a supervisor's feeling of percent complete, and report every job to one status date. GAO's schedule guide explains why percent-complete estimates are subjective. 1

Measure completed steps

GAO notes that percentage complete is subjective, and more so for long activities: 25 percent complete may be viable for a 4-day activity but is ambiguous for a 50-day one. 1

Record actual dates

GAO describes updating the schedule with actual progress and logic, so the plan shows what really happened and what is left. 1

Use one status date

GAO measures the remaining critical path from the current status date to the finish, so everyone should report to the same cut-off time. 1

Control the baseline

GAO says baseline and current schedules should go through change control, or staff keep revising the plan to match performance. 1

Break long jobs into steps of a day or less that are either done or not done. The critical path and float that the updates feed are explained in shutdown scheduling.

The meeting

How should the daily shutdown meeting run?

The daily meeting should be short, run to a fixed agenda at the same time every day, and finish with decisions recorded rather than with open discussion. HSE says handovers between shifts should be face to face, two-way and given enough time. 3

Daily shutdown operations flow: morning briefing, progress review, issue resolution and evening handoff
A daily shutdown rhythm in four steps: morning briefing, progress review, issue resolution and evening handoff. A MaintWiz illustration.

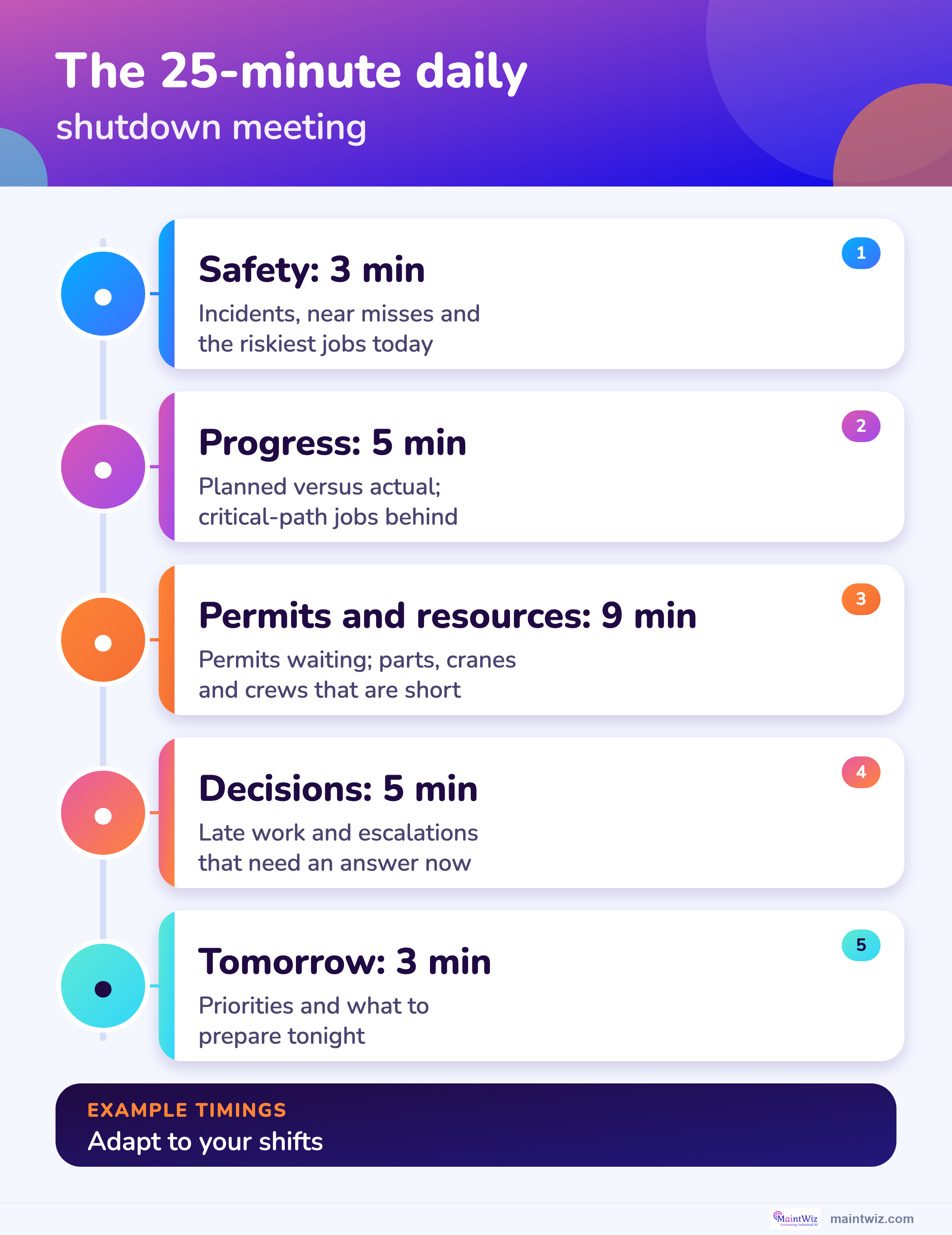

A daily meeting agenda (example timings)
MinutesItemWhat is covered
3SafetyIncidents and near misses since the last meeting; today's highest-risk jobs
5Progress against the planPlanned versus actual progress; critical-path jobs behind plan
5Permits and isolationsPermits live, waiting on isolation, or waiting on a test
4Materials and resourcesParts, cranes and crews that are short today
5DecisionsLate work, scope changes and escalations that need a decision now
3TomorrowPriorities and anything to prepare tonight

Software

Can software track shutdown progress?

Software can capture progress at the job, show planned against actual on one screen and produce the daily report from the same records, so the meeting starts from the data and not from a spreadsheet rebuilt overnight.

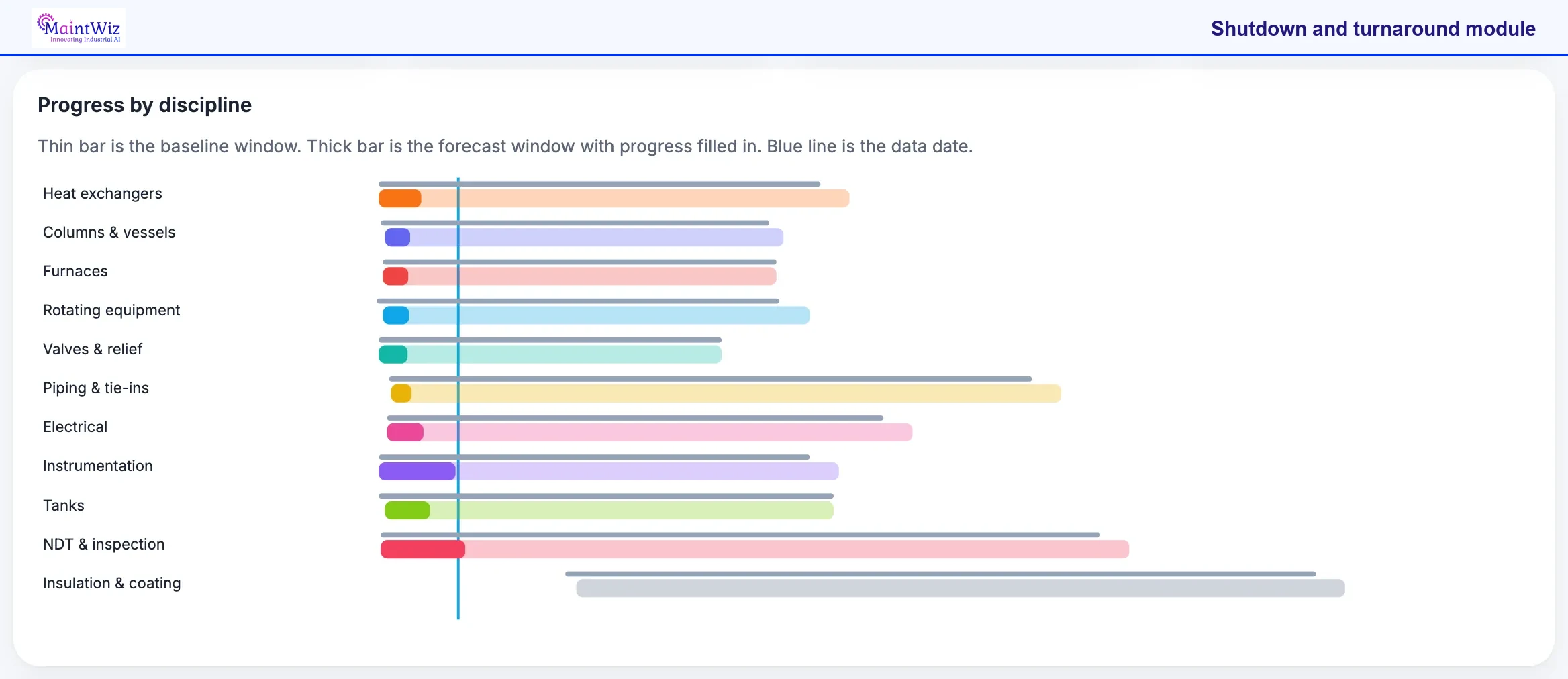

MaintWiz: progress by discipline during execution
Progress by discipline. A bar chart with one row per discipline, from Heat exchangers to Insulation & coating. A thin bar marks the baseline window, a thick bar the forecast window with progress filled in, and a blue vertical line the data date.

Compare each thick bar with the thin bar above it: a forecast window that runs past the baseline means the discipline is slipping. Then see how much fill sits left of the blue line. Use it in the daily meeting to choose which disciplines to chase.

For the full feature list, see the MaintWiz shutdown module data sheet.

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

The S-curve

What is an S-curve and how do you read it?

An S-curve plots cumulative planned progress and cumulative actual progress against time; it is S-shaped because work builds up, peaks and tails off, and a gap between the two lines shows how far ahead or behind the shutdown is.

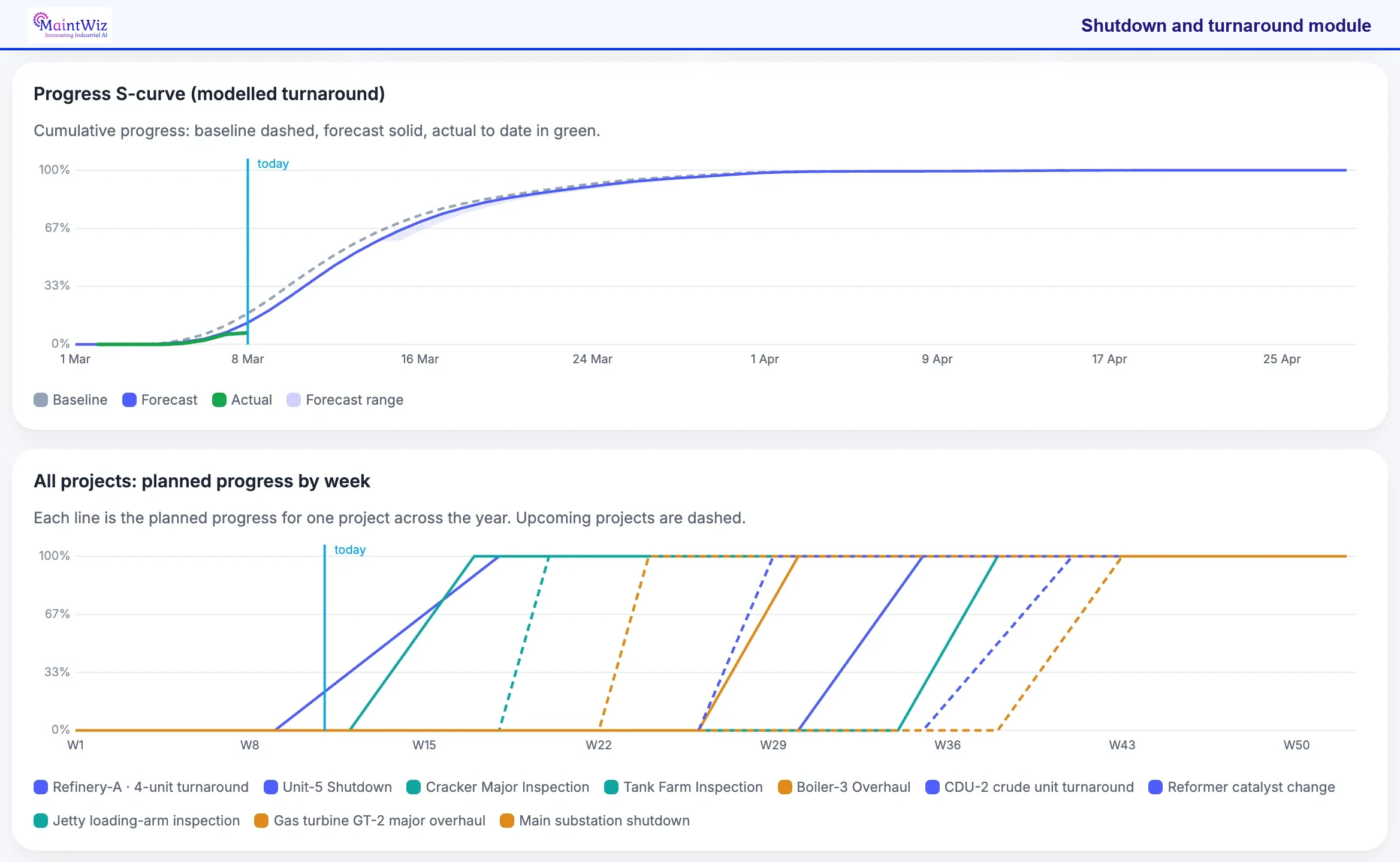

MaintWiz: progress S-curve of planned against actual progress
Progress S-curve. Two charts: a Progress S-curve with the baseline dashed, forecast solid, actual in green, a shaded forecast range and a today marker, and an All projects planned progress by week chart with one line per project and upcoming projects dashed.

Start with the lower chart: each line is one project, so the overlap shows the weeks when several projects are in progress together. Then go back to the S-curve and compare where the green actual line ends with the dashed baseline at the today marker. That gap is the schedule position now.

In the MaintWiz shutdown module the S-curve sits on the Progress view of the day-on-site screen. The shutdown manager and the planner read the same line in the daily meeting: where the green actual line meets the today marker, against the dashed baseline, shows whether the job is ahead or behind, and the shaded range shows how far the finish could still move.

Progress S-curve: what the screen shows
ElementWhat the screen shows
BaselinePlanned cumulative progress, dashed
ForecastProjected cumulative progress to the finish, solid
Actual to dateProgress achieved so far, in green
Forecast rangeShaded band around the forecast
Today markerA vertical line at the status date, so the gap is read at one point
All projects viewPlanned progress by week for each project across the year; upcoming projects dashed

Planned dates for the S-curve can come from the Excel to Gantt tool. See a planned versus actual review in the shutdown case study. For percent complete rules, the schedule index and the three-day look-ahead, see the shutdown S-curve and percent complete guide.

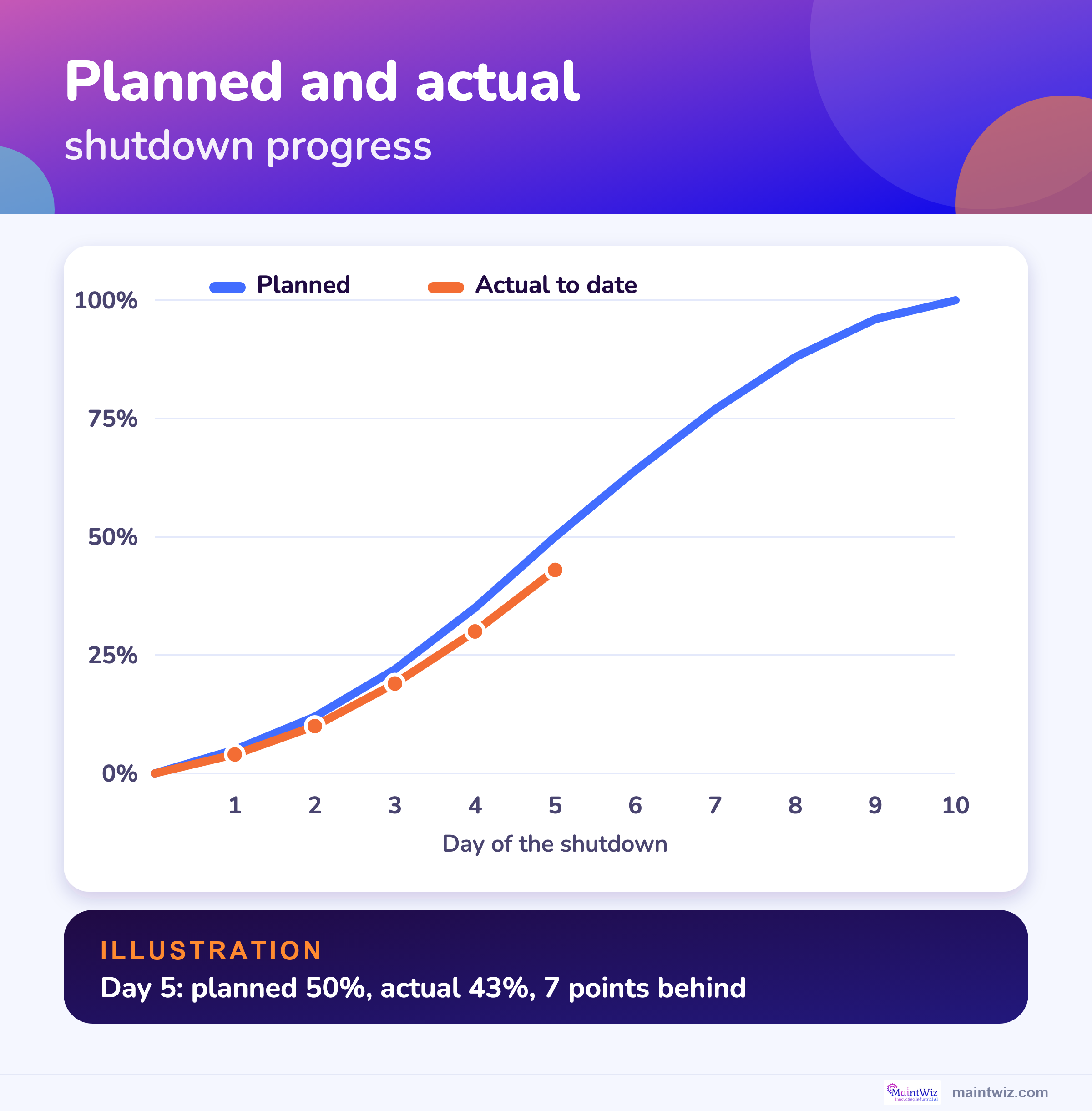

The numbers are for illustration. By the end of day 5 the plan called for 50 percent complete and the job stood at 43 percent, so it is 7 percentage points behind and has delivered 0.86 of the planned progress to date (43 divided by 50).

An illustrative S-curve: planned and actual cumulative progress
Day12345678910
Planned, % complete51222355064778896100
Actual, % complete410193043

For cost, the equivalent measures are the earned value indexes in shutdown KPIs: SPI is earned value divided by planned value. 2

Calculator

How do you forecast the finish date from today's progress?

Divide actual progress by planned progress to get a progress ratio, then divide the planned duration by that ratio to project the duration if the current pace continues.

More tools are on the shutdown calculator tools page. See critical path vs critical chain for how float is worked out.

Try it: forecast the finish from today's progress

Progress variance, points
Progress ratio (actual / planned)
Forecast duration, days
Days late at this pace

The report

What goes in a daily shutdown progress report?

A daily progress report shows planned versus actual progress, critical-path status, work done and not done, permits, safety, cost, scope changes, decisions needed and tomorrow's priorities, on one page.

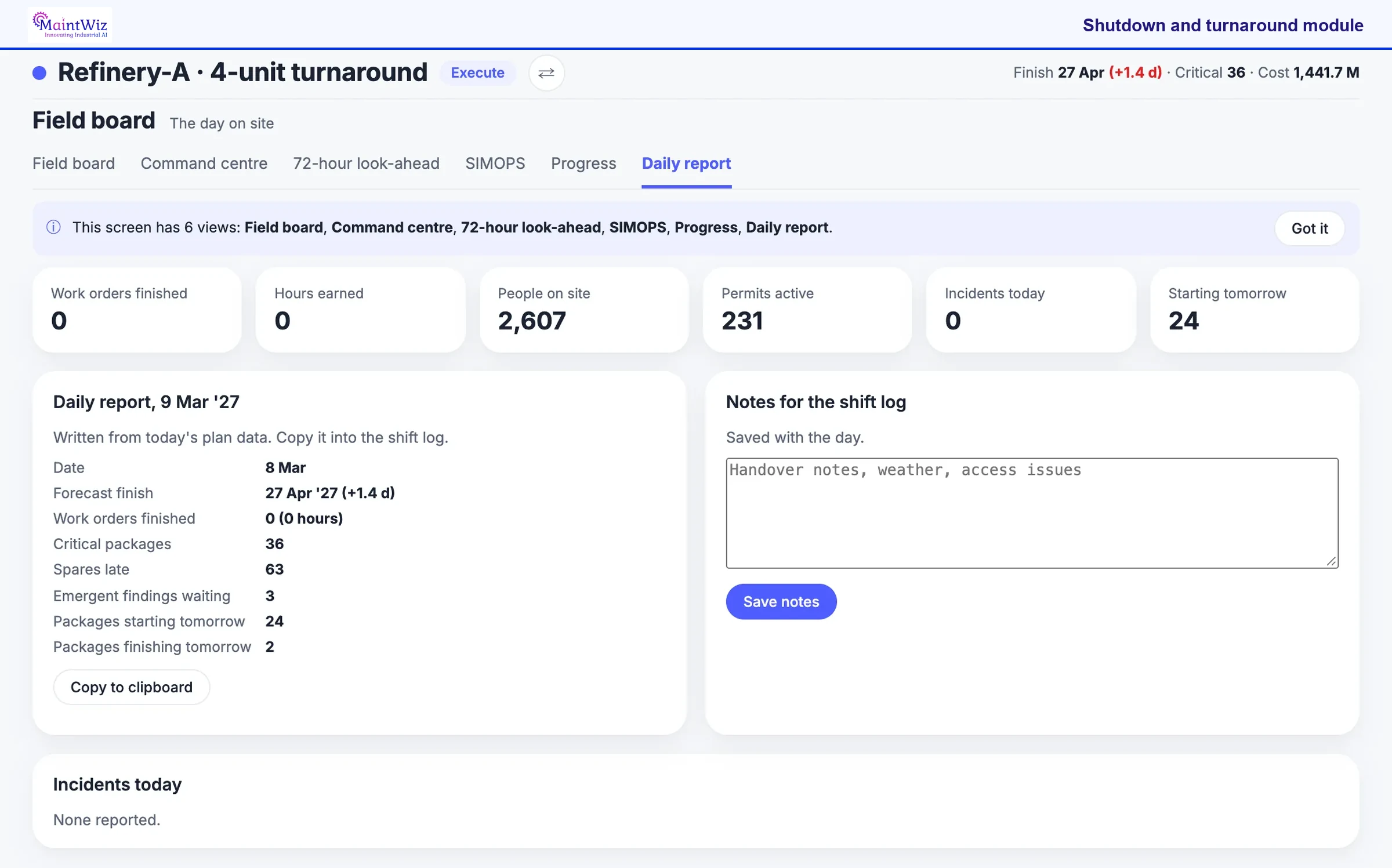

MaintWiz: daily report with shift log notes and incidents today
Daily report with shift log notes. The Daily report tab of the day-on-site screen. Six tiles run across the top, from work orders finished to starting tomorrow. Below are a report listing forecast finish, critical packages, spares late and packages starting tomorrow, a notes box with Save notes, and Incidents today.

Open the report before the daily meeting and read down the list: late spares, emergent findings waiting and the packages starting tomorrow. Those are the items that need a decision from the meeting. Copy the report to the shift log, then type the handover notes so tomorrow's team sees them.

The Daily report is one of six views on the day-on-site screen, beside the field board, command centre, 72-hour look-ahead, SIMOPS and progress. It is written from today's plan data, so the meeting starts from the same numbers; copy it to the clipboard for the shift log, and type handover notes, weather or access issues into the notes box, which is saved with the day.

Daily report in MaintWiz: what the screen shows
Part of the screenWhat it shows
Header countsWork orders finished, hours earned, people on site, permits active, incidents today and packages starting tomorrow
Daily reportDate, forecast finish and days late, work orders finished, critical packages, spares late, emergent findings waiting, packages starting and finishing tomorrow
Copy to clipboardMoves the report into the shift log or the meeting pack
Notes for the shift logFree text for handover notes, weather and access issues, saved with the day
Incidents todayThe incidents reported that day, or none reported

A daily progress and S-curve workbook is among the free shutdown templates. A free Excel file for this page: daily progress and S-curve workbook (.xlsx).

A daily progress report: fields
FieldWhat it shows
Planned and actual progressCumulative percent, with the S-curve updated
Critical-path statusJobs on or near the critical path, ahead or behind
Work completed and not completedBy area, with reasons for jobs not done
Permits and isolationsIssued, closed, waiting; isolations in force
SafetyIncidents, near misses, stop-work calls
Cost to dateActual cost against the plan and contingency used
Scope changesRequests approved, deferred or rejected today
Decisions neededIssues for the shutdown manager, with an owner and a time
TomorrowPriorities, crews and materials to arrange

Permit volumes and supervision are discussed in permit to work during shutdown; HSE guidance says very active periods such as shutdowns need extra resource for permit supervision or fewer active permits. 4

Visuals

Save the tracking charts

Two charts for the shutdown office wall. Click either for the full-size version.

FAQ

Frequently asked questions

How do you track progress during a shutdown?

Measure completed steps and actual dates against the baseline, report every job to one status date, and plot cumulative planned and actual progress on an S-curve. GAO explains why percent-complete estimates are subjective, especially for long activities. 1

What is an S-curve in shutdown management?

A chart of cumulative planned progress and cumulative actual progress against time. It is S-shaped because work ramps up, peaks and tails off; a gap between the lines shows how far behind or ahead the job is.

What should be in the daily progress report?

Planned and actual progress, critical-path status, work done and not done, permits, safety, cost, scope changes, decisions needed and tomorrow's priorities.

How long should the daily shutdown meeting be?

Short and fixed: the example agenda totals 25 minutes. HSE says shift handovers should be face to face, two-way and given enough time. 3

How do you forecast the finish date?

Divide actual progress by planned progress to get a ratio, then divide the planned duration by it. This simple projection assumes the current pace continues.

Why is percent complete unreliable?

GAO says percentage complete is subjective, more so as activity duration grows, since it depends on an expected duration that can vary. 1

How is schedule performance index calculated?

SPI is earned value divided by planned value. 2

Where does the progress data come from?

From the people doing the work, captured at the job, so planning, permits and cost read from the same records.
