Steel Plant Shutdown: Blast Furnace Reline Planning
A steel plant shutdown is a planned stop of a blast furnace or mill for relining, repair and inspection. Blast furnace operators aim for campaigns of 15 to 20 years between relines, and one 2008 reline was reported at a record 70 days of downtime. Planning rests on gas, confined space and energy control rules plus your own history.
How MaintWiz helps: Relines and mill stops need long-lead parts and a tight critical path. The MaintWiz shutdown module gives plant teams one plan for scope, schedule, permits, spares and execution, from the first work package to close-out. See the module · Get the data sheet
By Jai Balachandran · Published · Last reviewed
What MaintWiz adds:Scope, schedule and permits in one planSpares status with SAPReadiness gatesFindings to the planner
Fact block
How is a steel plant shutdown planned?
A blast furnace is relined only once per campaign, which operators aim to stretch to 15 to 20 years, and one 2008 reline was reported at 70 days of downtime against over 80 days for the previous one. 1,2
India: the Occupational Safety, Health and Working Conditions Code, 2020 came into force on 21 November 2025 and subsumes the Factories Act, 1948. The Act sections quoted on this page now have corresponding duties in the Code, and the Centre and the states are still issuing rules under it, so confirm the current rule for your state before you plan work. 8,9
| Item | Guidance | Source |
|---|---|---|
| Usual term | Blast furnace reline for the major outage at the end of a campaign; other units use shutdown or planned outage | EU study, AIST |
| How often | Operators aim for blast furnace campaigns of 15 to 20 years between relines (EU study, 2001) | EU study |
| How long | One German blast furnace reline in 2008 was reported at a record 70 days of downtime, against over 80 days for its 1996 reline; a single furnace, not a norm | AIST |
| Other steel units | Typically rolling mills stop for 3 to 7 days a year for roll, bearing and hydraulic work; sinter plants and converters for about 1 to 2 weeks; a converter reline every few years takes 2 to 3 weeks | Typical |
| Gas exposure limits | Carbon monoxide: NIOSH recommended limit 35 ppm over 8 hours (ceiling 200 ppm); OSHA limit 50 ppm; immediately dangerous at 1,200 ppm | NIOSH pocket guide |
| US regulatory driver | OSHA permit-required confined spaces (1910.146) and control of hazardous energy (1910.147) | OSHA 1910.146, OSHA 1910.147 |
| India driver | Factories Act 1948: a competent person must certify a confined space free of dangerous gas, fume or dust in writing before entry, or the entrant must use breathing apparatus with a rope held outside (section 36) | Factories Act 1948 |
Reline
How long does a blast furnace reline take?

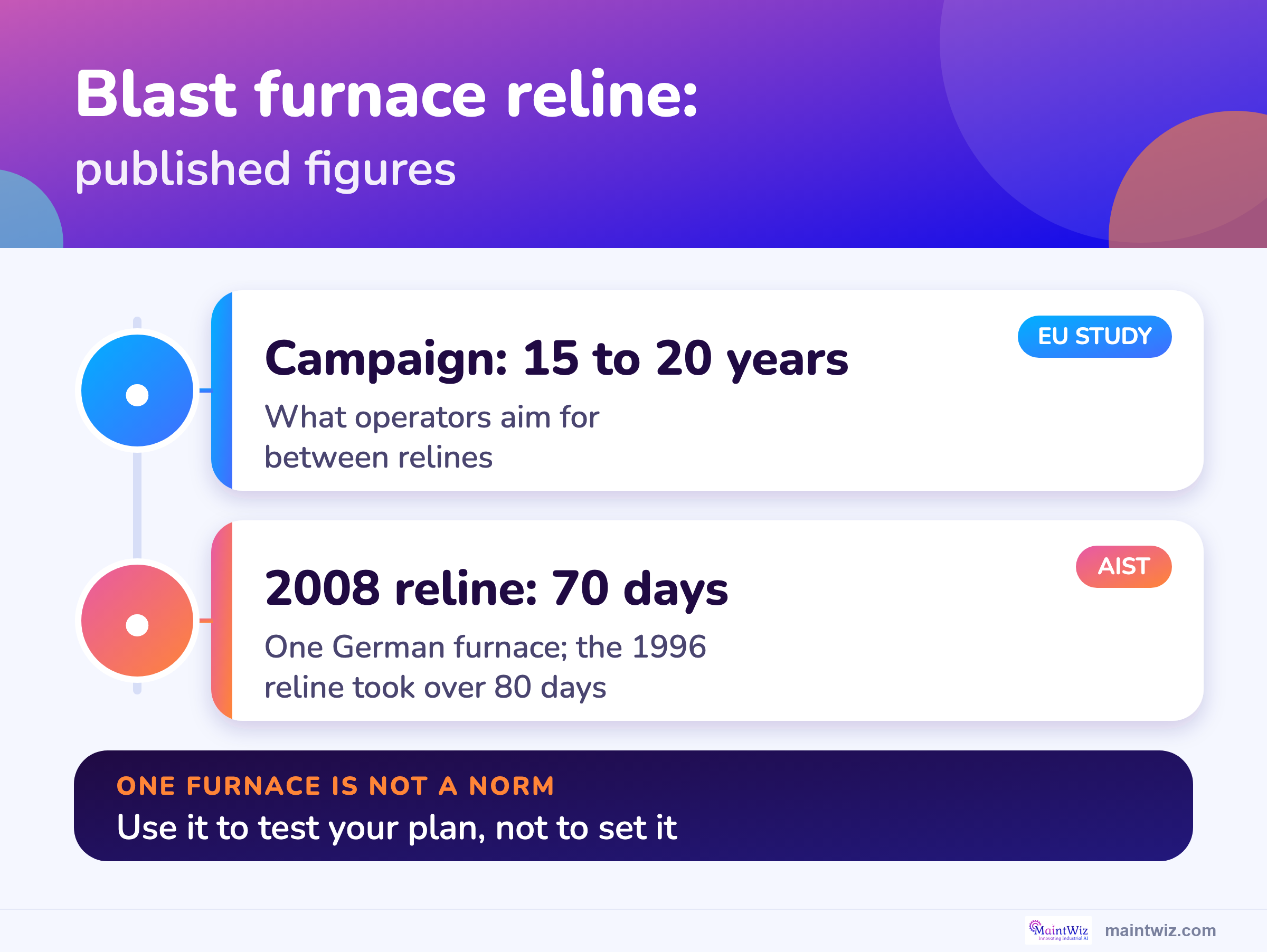

The only public figure found is one German blast furnace reline in 2008 reported at a record 70 days, against over 80 days for its 1996 reline, so there is no typical duration to plan against. 2
For a mill reline in mining, see mining shutdown planning.
Because a campaign runs 15 to 20 years, a reline is a rare event that most teams have never run, and lessons from the last one are the best planning data. 1 Plan it backward from the restart date using the method in how to plan a plant shutdown and the critical path in shutdown scheduling.
Software
How can software help with a steel plant shutdown?
Software can hold the permit, isolation and lockout records for many crews in one place and show the status of each job against the reline or shutdown schedule.

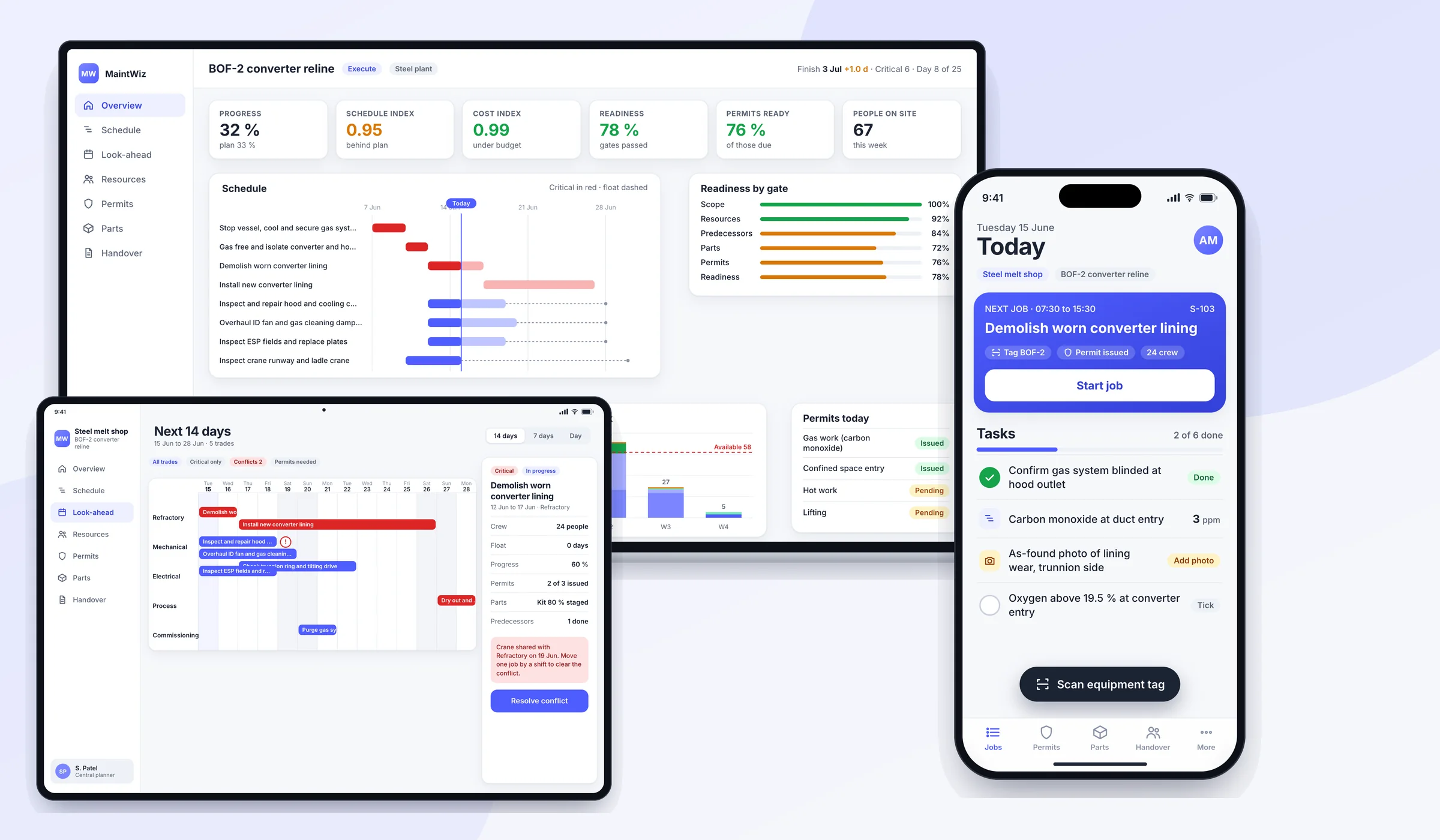

The phone list is where the steel safety checks show: confirm the gas system is blinded, carbon monoxide at the duct entry, oxygen above 19.5 percent at the converter entry. The laptop shows readiness by gate, and the tablet shows the crane shared between trades. Check each against how your reline is run.

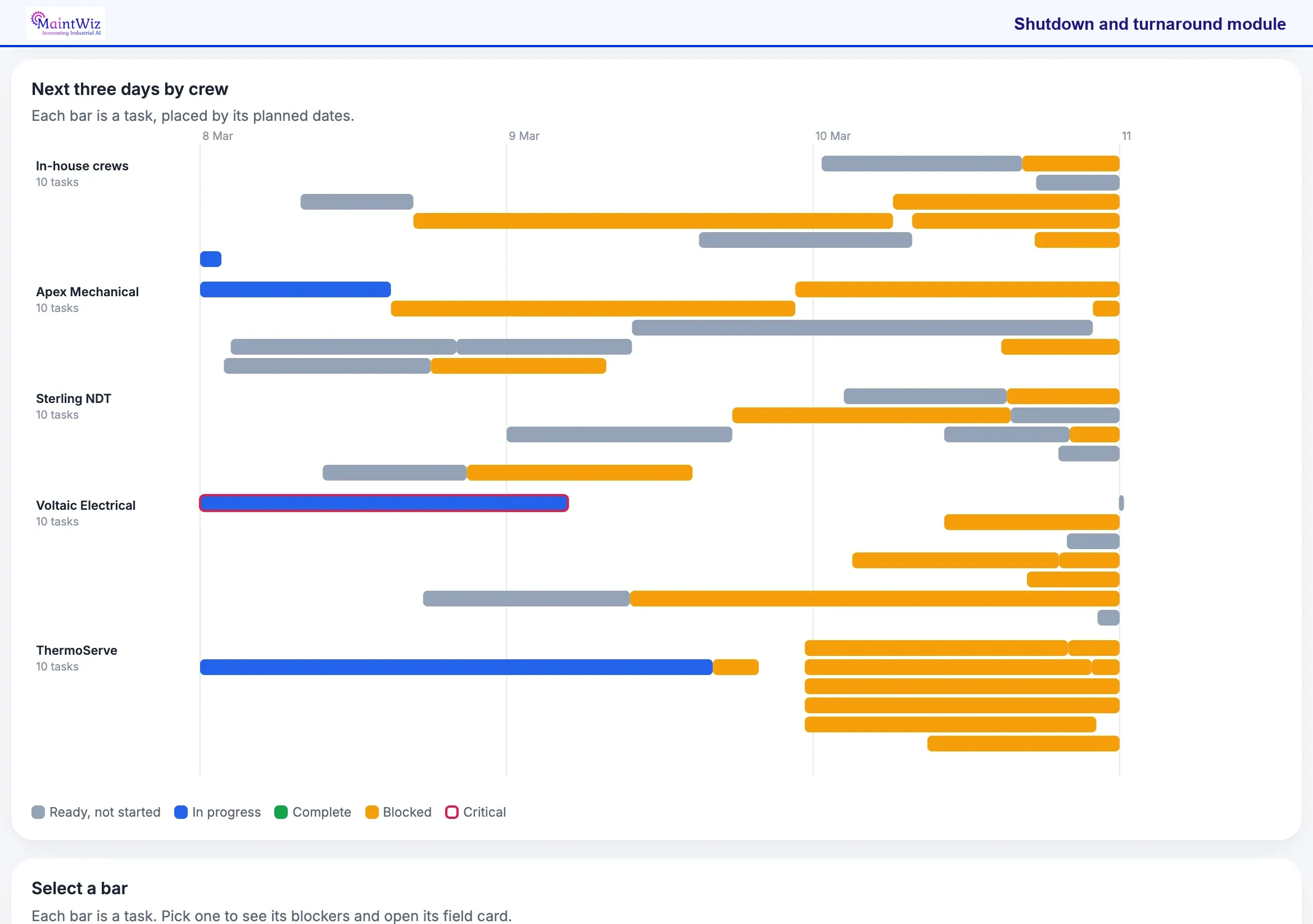

Look for the orange blocked bars stacking up late in the window, and for the red-outlined critical task under Voltaic Electrical. The supervisor can use the view to clear blockers on the next day's jobs before crews arrive, and to see which contractor has the most work waiting.
Also: product data sheet.
What the shutdown module covers
- Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
- Asset prioritization, so the most critical equipment is scoped first
- Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
- Electronic permits to work, risk management and contingency plans
- Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
- Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis
Proof
What MaintWiz customers report
Results from MaintWiz customers across maintenance operations.
Gas
What gas hazards must a steel shutdown plan cover?
Plans must cover toxic gas, and the clearest public numbers are for carbon monoxide: NIOSH recommends 35 ppm as an 8-hour average with a 200 ppm ceiling, OSHA's limit is 50 ppm and 1,200 ppm is immediately dangerous to life or health. 3

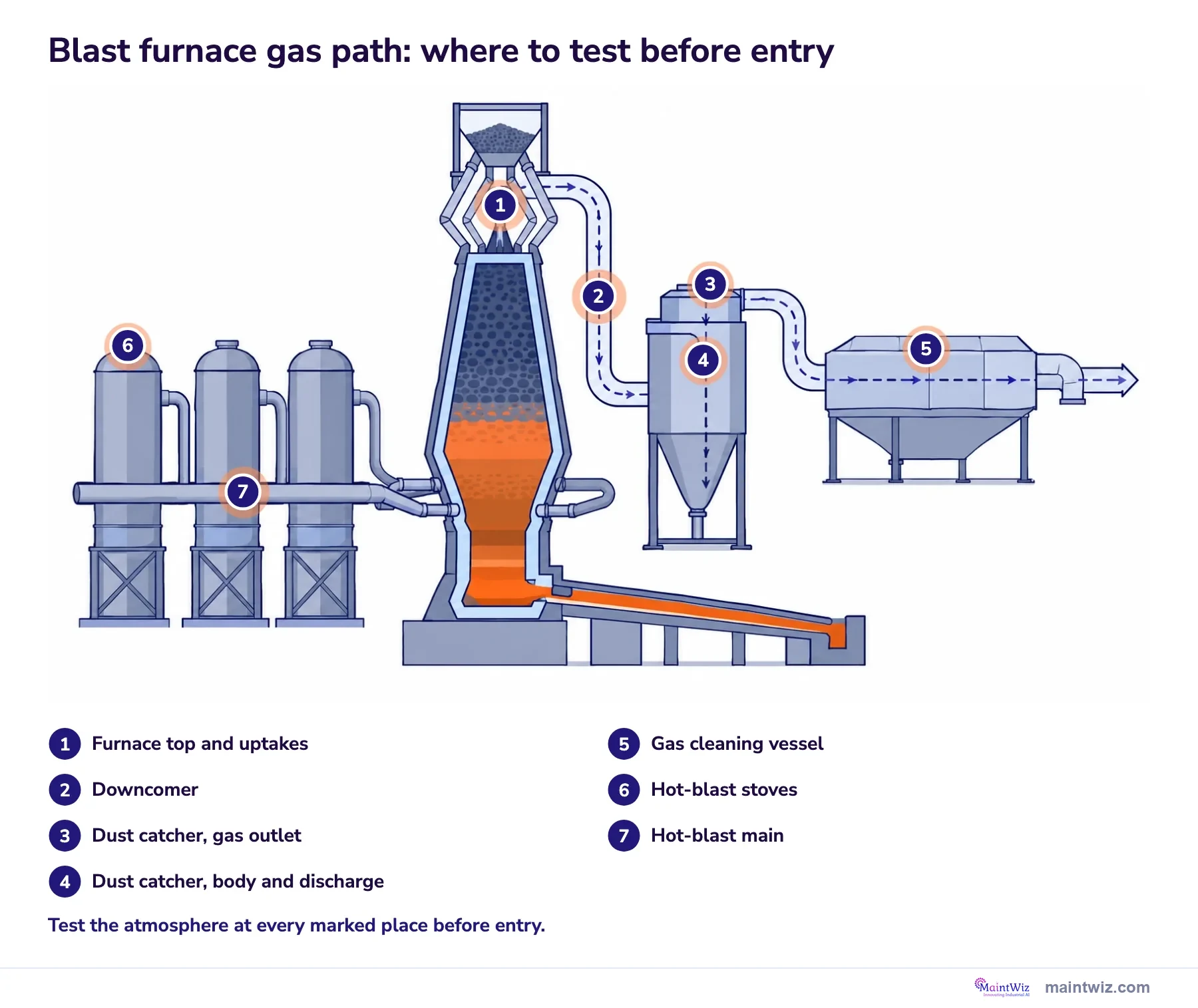

Follow the arrows from the furnace top through the downcomer and dust catcher to gas cleaning, then check the stoves and the hot-blast main. Put each marked place on the permit and gas-test list so no entry is missed. Use the order when you plan isolation and confined-space entry.
| Marker | What it marks | Note |
|---|---|---|
| 1 | Furnace top and uptakes | |
| 2 | Downcomer | |
| 3 | Dust catcher, gas outlet | |
| 4 | Dust catcher, body and discharge | |
| 5 | Gas cleaning vessel | |
| 6 | Hot-blast stoves | |
| 7 | Hot-blast main |
Illustration by MaintWiz with numbered markers.
Related: Permit to work in a shutdown · OSHA rules for shutdowns
Entry into any permit-required confined space needs a written permit documenting the required measures. 4 Which areas can hold process or combustion gas is a site decision for the gas hazard assessment. See permit to work during shutdown.
Isolation
How should isolation and lockout work across large crews?
Use group lockout with one authorized employee coordinating crews, transfer lockout protection in an orderly way at shift change, and exchange lockout procedures with outside contractors. 5

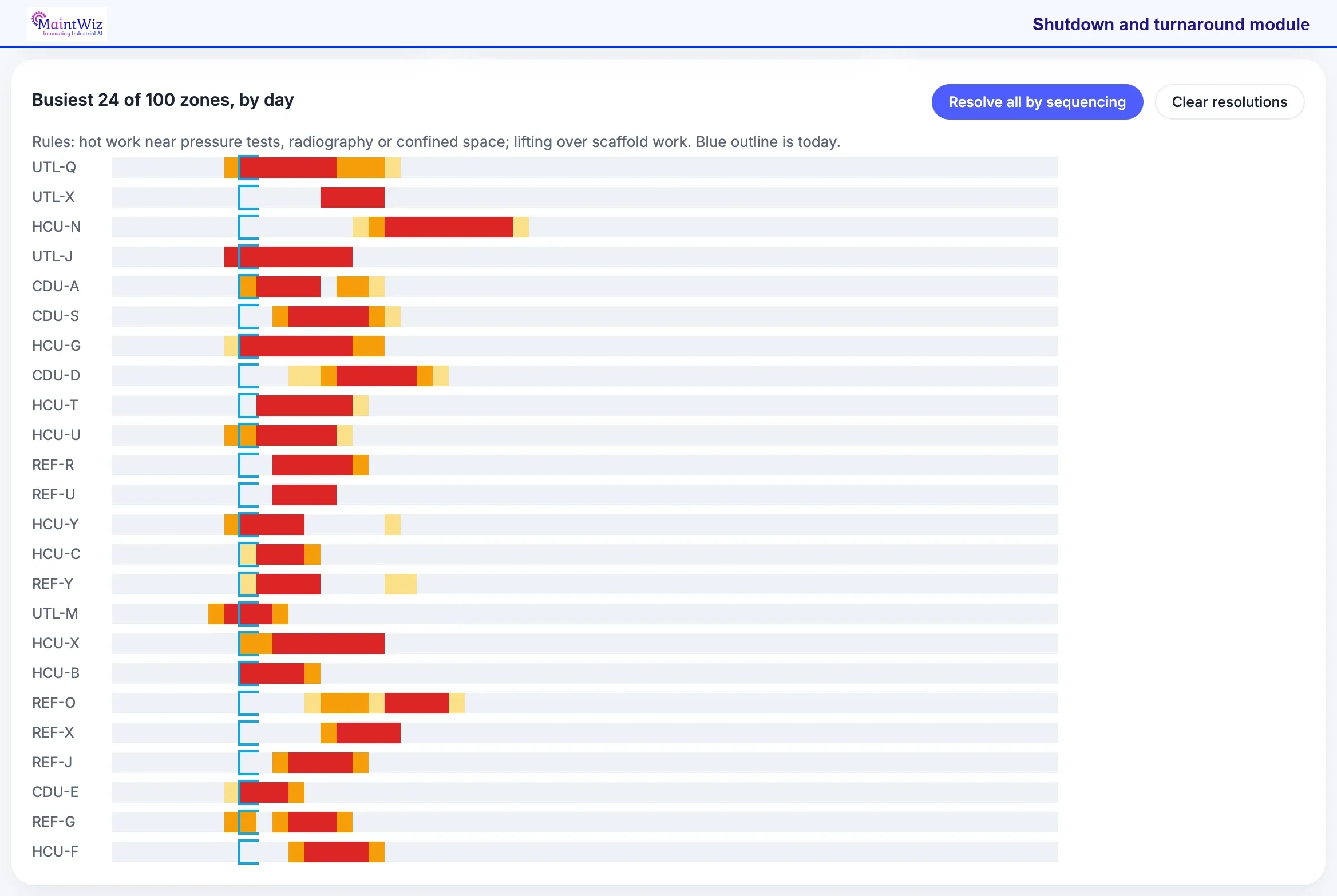

Look for the zones with the longest bars near the today outline. The rules line says the clashes are hot work near pressure tests, radiography or confined space, and lifting over scaffold work. The area leads decide which job goes first in each zone, and the sequencing button applies that order.
Boiler isolation is covered in annual boiler shutdown in India.
HSE adds that isolation certificates support the permit and should be cross-referenced to it. 6 More on handover and controls is in shutdown execution.
Checklist
What belongs on a steel plant shutdown checklist?

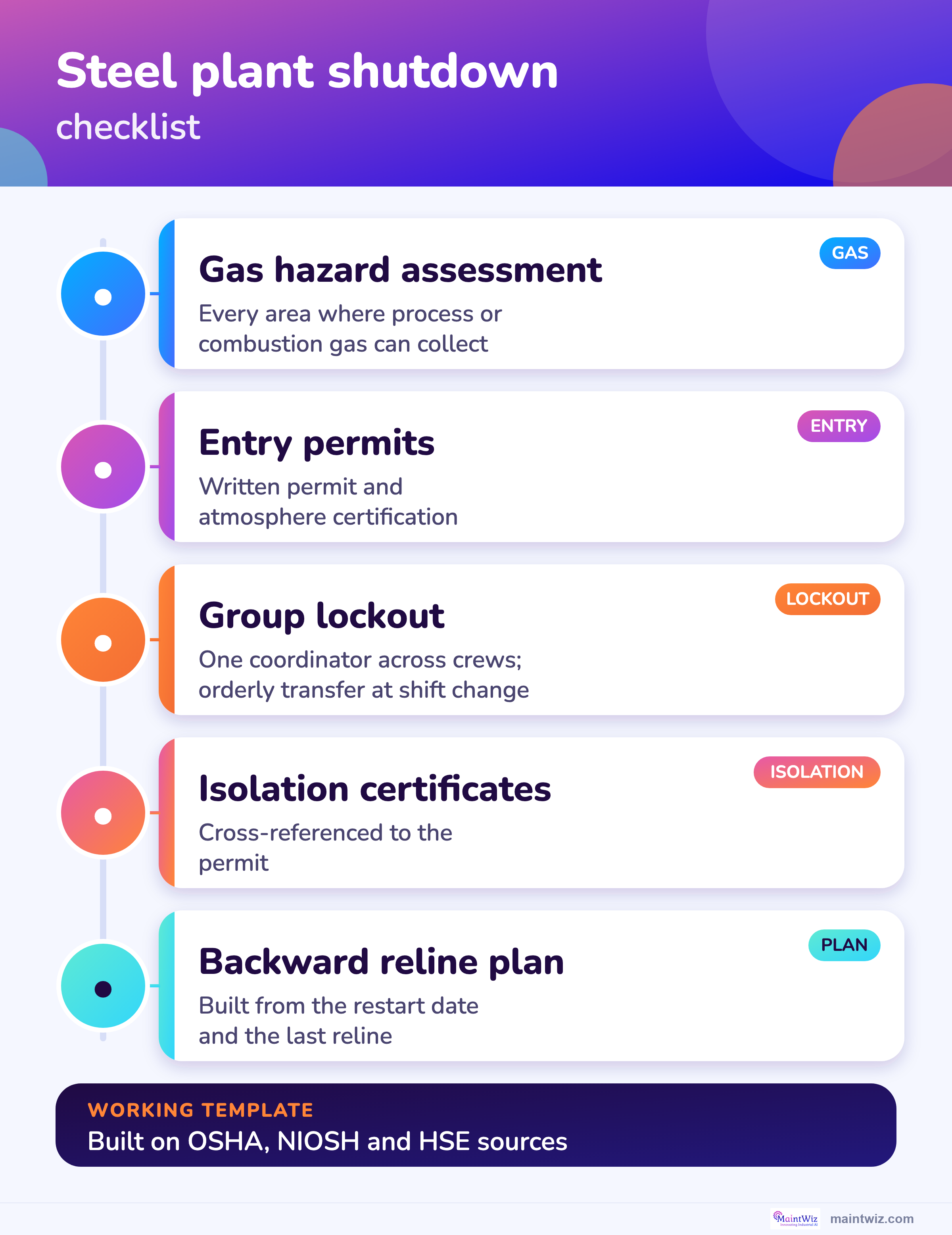

A steel plant shutdown checklist should cover the gas hazard assessment, confined space permits and certification, group lockout, shift handover, isolation certificates and a reline plan built backward from restart.
A free Excel version is available: Steel plant shutdown checklist (.xlsx).
| Check | Basis |
|---|---|
| Gas hazard assessment for every area where combustion or process gas can collect | Carbon monoxide is toxic at low concentrations; know the limits and who monitors |
| Confined space entry permit and atmosphere certification | OSHA requires an entry permit; the Factories Act requires written certification or breathing apparatus, and neither removes the need for atmospheric testing and rescue planning |
| Group lockout across crews with one coordinator | OSHA group lockout gives each person protection equivalent to a personal lock |
| Lockout continuity at shift change | OSHA requires an orderly transfer of lockout protection |
| Isolation certificates tied to permits | HSE guidance: certificates support the permit and should be cross-referenced |
| Reline plan built backward from the restart date | The 2008 reline shows the days can be cut, not that 70 is typical |
The general list is the 40-step shutdown checklist.
FAQ
Frequently asked questions
How long does a blast furnace reline take?
No typical figure is published. One German furnace's 2008 reline was reported at 70 days against over 80 days in 1996. 2
How long does a blast furnace campaign last?
Operators aim for 15 to 20 years between relines, according to a 2001 EU study. 1
What is the exposure limit for carbon monoxide?
NIOSH recommends 35 ppm over 8 hours with a 200 ppm ceiling; OSHA's limit is 50 ppm; 1,200 ppm is immediately dangerous to life or health. 3
Is a confined space permit required in a steel plant?
Under OSHA 1910.146, entry to a permit-required confined space is authorized by an entry permit. In India the Factories Act requires written certification or breathing apparatus, and neither removes the need for atmospheric testing and rescue planning. 4,7
How does group lockout work?
A procedure gives each member of a group protection equivalent to a personal lock, with one authorized employee coordinating when several crews are involved. 5
What is the interval for rolling mills or arc furnaces?
Use equipment makers' guidance and your own history.
Do isolation certificates replace permits?
No. HSE says they support the permit and should be cross-referenced to it. 6
What rules apply outside the US and India?
Requirements differ by site and jurisdiction. Check the rules that apply to your plant.
Sources
Sources
- Publications Office of the European Union, An in-depth study into prolonging blast furnace campaign life (2001)
- Association for Iron & Steel Technology, ThyssenKrupp Steel to Restart Blast Furnace 1 at Duisburg-Schwelgern (20 March 2008)
- US National Institute for Occupational Safety and Health, NIOSH Pocket Guide to Chemical Hazards: Carbon monoxide
- OSHA, 29 CFR 1910.146, Permit-required confined spaces
- OSHA, 29 CFR 1910.147, The control of hazardous energy (lockout/tagout)
- UK Health and Safety Executive, The safe isolation of plant and equipment (HSG253, 2006)
- Government of India, Ministry of Labour and Employment, The Factories Act, 1948
- PRS Legislative Research, The Occupational Safety, Health and Working Conditions Code, 2020
- DLA Piper, Government of India notifies the Labour Codes (November 2025)
